Saudi Mobile App Vendor Evaluation Scorecard: Technical, Commercial and Delivery Checks

Saudi Mobile App Vendor Evaluation Scorecard: Technical, Commercial and Delivery Checks

September 2, 2026
Sana Ullah
Written By : Sana Ullah
Associate Digital Marketing Manager
Facts Checked by : Zayn Saddique
Technical Validation
Zayn Saddique

Table of Contents

Share Article:

Choosing a mobile app development vendor is difficult because proposals rarely describe capability in the same way. One company may emphasize design, another may lead with technologies, and another may compete mainly on price. These differences make direct comparison unreliable unless every vendor is evaluated against the same requirements, evidence standards, and risk controls.

Saudi projects add another layer to the decision. Buyers may need Arabic and right-to-left experiences, local payment or identity integrations, clear data responsibilities, secure backend systems, and reliable support across launch and ongoing operations. A polished presentation does not prove that a vendor can deliver these requirements.

This guide provides a vendor-neutral framework for evaluating a mobile app development company in Saudi Arabia. It combines mandatory disqualification gates with a weighted 100-point scorecard covering technical, commercial, delivery, and Saudi-market readiness.

A Saudi business should evaluate mobile app vendors in two stages.

First, apply mandatory gates for source-code ownership, account control, team transparency, security responsibilities, scope clarity, Saudi readiness, subcontracting, and post-launch continuity. A vendor that fails a critical gate should not proceed merely because it earns a high total score.

Second, score the remaining vendors across eight weighted categories:

  1. Product discovery and scope definition

  2. Saudi-market and Arabic readiness

  3. Technical architecture and engineering

  4. Security, privacy, and data responsibilities

  5. Delivery governance and communication

  6. Quality assurance and release readiness

  7. Commercial terms, ownership, and handover

  8. Verifiable evidence and client references

Request evidence for every important claim. Score vendors independently, compare differences between evaluators, verify references, and use paid discovery when significant uncertainty remains.

Download the Saudi Mobile App Vendor Scorecard

Use the editable workbook with this guide to compare up to three vendors. It includes project-type weights, mandatory-gate status, 0-to-5 category scores, weighted totals, evidence confidence, reference checks, category floors, conditions, and a final decision record.

Download Scorecard

Saudi mobile app vendor evaluation scorecard preview

How the Vendor Evaluation Works

Apply the framework before price preferences or personal relationships influence the decision.

  1. Define the project and risk profile. Record the intended users, platforms, Arabic and English needs, integrations, data sensitivity, launch target, operating model, and expected scale. Select the standard, startup, enterprise, regulated, or custom weight profile before reviewing proposals.
  2. Issue one evaluation pack. Give every vendor the same requirements, assumptions, response format, clarification deadline, and evidence requests. Normalize scope, team, integrations, environments, QA, infrastructure, warranty, support, and ownership before comparing headline prices.
  3. Apply gates before ranking. Assess ownership, account control, team transparency, security responsibilities, scope, Saudi readiness, subcontracting, and post-launch continuity. A failed critical gate pauses selection regardless of the weighted total.
  4. Score evidence independently. Ask product, engineering, security, procurement, and business stakeholders to score vendors separately. Investigate material differences rather than averaging away unclear requirements or unsupported claims.
  5. Verify and document the decision. Check references, resolve conditions, use paid discovery when uncertainty remains, and record scores, evidence, assumptions, risks, negotiated terms, approval owners, and the reasons alternatives were not selected.

Phase

Main action

Decision output

Requirements

Define users, journeys, risk, integrations, constraints, and profile

Comparable evaluation pack

Mandatory gates

Test ownership, access, team, security, scope, Saudi readiness, subcontracting, and continuity

Pass, conditional, or fail

Weighted score

Score the eight categories from 0 to 5 using the approved weights

Risk-adjusted total and category gaps

Verification

Review evidence, clarification answers, and client references

Verified claims, conditions, and unresolved risks

Discovery and contract

Reduce uncertainty and translate commitments into binding terms

Approved vendor and traceable decision record

Saudi mobile app vendor selection flow

Mandatory Disqualification Gates

Mandatory gates identify risks that a weighted score can hide. Apply them before final ranking and repeat them after contract negotiations because a vendor’s position may change when responsibilities become legally binding.

Mandatory gate

Pass condition

Warning signs

Source code and intellectual property

Project-specific ownership or permanent usage rights are defined in writing

Ownership deferred until final payment without repository visibility; broad vendor ownership over custom work

Accounts and repositories

Client has agreed access to repositories, app stores, cloud platforms, analytics, and essential services

Vendor-controlled accounts with no documented transfer or administrative access

Named delivery team

Roles, seniority, allocation, location, and replacement process are disclosed

Sales profiles presented as the delivery team; unrestricted substitutions

Security and data responsibilities

Access, testing, incident, data, and remediation responsibilities are assigned

Generic claims with no responsible owner, method, or evidence

Scope and acceptance

Deliverables, exclusions, dependencies, and acceptance criteria are measurable

Ambiguous “complete app” promises; acceptance based only on visual completion

Saudi-market readiness

Arabic, RTL, integrations, data responsibilities, and operational needs are addressed where relevant

Saudi readiness reduced to translation or a local office address

Subcontracting transparency

Subcontractors, responsibilities, locations, and controls are disclosed

Undisclosed delivery partners or unclear access to code and data

Launch and support continuity

Release ownership, warranty, handover, monitoring, and escalation are defined

No support boundary, rollback responsibility, or knowledge-transfer plan

Source Code and Intellectual Property

The contract should distinguish project-specific code from vendor-owned frameworks, open-source software, licensed components, and third-party services. Buyers need to understand what they own, what they are licensed to use, and whether any dependency could restrict future maintenance or vendor replacement.

A pass requires written terms that are consistent with the proposal, delivery process, and repository access. Verbal assurances are not enough.

Accounts, Repositories, and Production Access

The client should know who will create and administer source repositories, Apple and Google developer accounts, cloud environments, analytics tools, signing assets, domain services, and third-party integrations.

Vendor convenience should not create permanent client dependency. Administrative control, access timing, credential handling, and transfer procedures must be agreed before development begins.

Named Team and Replacement Controls

Evaluate the people expected to perform the work rather than only the company’s general capability. Confirm the delivery lead, product or business analyst, designers, mobile engineers, backend engineers, QA specialists, DevOps support, and security responsibilities that apply to the project.

The proposal should also explain allocation, time-zone coverage, planned substitutions, approval rights, and knowledge-transfer requirements when a team member changes.

Security and Data Responsibilities

The vendor should explain how security requirements enter discovery, architecture, development, testing, release, and incident handling. Responsibilities for authentication, authorization, encryption, API security, secrets, logging, vulnerability remediation, backups, and production access should have named owners.

If the vendor cannot explain the boundary between client, vendor, cloud provider, and third-party responsibilities, mark the gate as conditional or failed.

Scope, Dependencies, and Acceptance

The scope must define what will be delivered, what is excluded, what the client must provide, and how completion will be verified. Acceptance criteria should cover functional behavior, integrations, Arabic and English experiences, performance, security, data handling, and release readiness where relevant.

A proposal that provides a confident fixed price while leaving major integrations or workflows undefined carries hidden change risk.

Saudi-Market Readiness

Saudi readiness should be tested against the project’s actual needs. This may include bilingual content, RTL behavior, local payment methods, identity services, regional forms and formats, data responsibilities, support hours, and release operations.

Do not require every project to use every Saudi integration. Require the vendor to identify which local requirements apply, which do not, and what evidence supports that conclusion.

Subcontracting Transparency

Subcontracting is not automatically a problem, but undisclosed subcontracting creates accountability and security risk. The vendor should identify external teams, their responsibilities, access to client systems or data, quality controls, and replacement process.

The primary vendor must remain accountable for all contracted outcomes.

Launch, Warranty, and Support Continuity

Confirm who prepares store submissions, production environments, monitoring, release notes, rollback procedures, and launch support. Define the warranty period, defect classification, response expectations, escalation path, documentation, and transition into ongoing maintenance.

Without this gate, a technically complete build can still become operationally difficult to launch or support.

Gate Decision Rule

Use one of three outcomes for every gate:

  • Passed: The requirement is documented and supported by acceptable evidence.
  • Conditional: A fix is possible, but it must become a dated proposal or contract condition with a named owner.
  • Failed: The vendor rejects the requirement, cannot support the claim, or leaves an unacceptable risk unresolved.

A failed critical gate should pause selection. Conditional gates should be resolved before contract signature or recorded as explicit conditions precedent.

The 100-Point Saudi Mobile App Vendor Scorecard

Score each vendor from 0 to 5 in every category, then convert the category score into weighted points.

How the Scoring Model Was Designed

The weights, score bands, category floors, shortlist range, and evaluator-difference trigger in this guide are configurable decision rules. They are not industry benchmarks or statistically validated predictions of project success.

The default profile is designed to balance the common product, Saudi-market, engineering, security, delivery, QA, commercial, and evidence risks of a standard business application. Adjust the weights before scoring when the project has a different risk profile, document the reason for each change, and keep the total at 100.

Mandatory gates and buyer-defined category floors override the total score. Use the model to make evidence and trade-offs visible, then apply qualified legal, security, privacy, procurement, and technical review where the project requires it.

Weighted points = (category score ÷ 5) × category weight

Evaluation category

Weight

What the category measures

Product discovery and scope definition

12

Ability to turn business goals into validated requirements, risks, and delivery boundaries

Saudi-market and Arabic readiness

14

Ability to design, validate, and operate an experience appropriate for Saudi users and integrations

Technical architecture and engineering

15

Architecture quality, integration design, maintainability, scalability, and engineering controls

Security, privacy, and data responsibilities

15

Security-by-design practices, data decisions, access controls, testing, and accountability

Delivery governance and communication

12

Planning, reporting, change control, dependency management, and escalation

Quality assurance and release readiness

12

Test strategy, environments, automation, defect controls, performance, and launch preparation

Commercial terms, ownership, and handover

12

Price clarity, assumptions, ownership, accounts, documentation, warranty, and exit readiness

Verifiable evidence and client references

8

Relevance and strength of proof supporting the vendor’s claims

Total

100

Category Scoring Scale

Score

Interpretation

Evidence standard

0

No response or unacceptable position

Requirement ignored or rejected

1

Weak

General claim with no relevant method or proof

2

Limited

Partial approach with significant gaps or weak evidence

3

Acceptable

Credible approach that meets the requirement with adequate evidence

4

Strong

Detailed, relevant approach supported by strong evidence

5

Exceptional

Highly relevant, verified capability with clear ownership, controls, and measurable proof

Avoid awarding a 5 merely because a presentation is impressive. The highest score should require both a strong method and evidence that the vendor has applied it successfully in a comparable context.

Blank Vendor Evaluation Sheet

Duplicate this table for every shortlisted vendor. Enter a raw score from 0 to 5, calculate the weighted points, and cite the evidence used for the score.

Evaluation category

Weight

Raw score (0–5)

Weighted points

Evidence or risk note

Product discovery and scope definition

12

Saudi-market and Arabic readiness

14

Technical architecture and engineering

15

Security, privacy, and data responsibilities

15

Delivery governance and communication

12

Quality assurance and release readiness

12

Commercial terms, ownership, and handover

12

Verifiable evidence and client references

8

Total

100

For each row, calculate weighted points with (raw score ÷ 5) × weight. Keep unverified claims in the evidence column so uncertainty remains visible during the final comparison.

1. Product Discovery and Scope Definition — 12 Points

Strong vendors do not begin with screens and features alone. They clarify the business outcome, users, journeys, constraints, dependencies, assumptions, and measures of success before committing to a delivery plan.

Evaluate whether the vendor can:

  • Separate business goals from requested features
  • Identify primary users, roles, journeys, and edge cases
  • Validate assumptions through interviews, prototypes, data, or technical spikes
  • Define MVP boundaries and deferred capabilities
  • Map integrations, data sources, and client-owned dependencies
  • Create a risk register and decision log
  • Turn findings into measurable scope and acceptance criteria
  • Explain how discovery changes estimates and delivery planning

Strong evidence includes a redacted discovery plan, assumptions register, user-flow map, prototype test summary, prioritized backlog, integration inventory, or scope-decision record.

Reduce the score when discovery is described as a few introductory meetings with no defined outputs or decision gates.

2. Saudi-Market and Arabic Readiness — 14 Points

The vendor should show how Saudi-market needs affect product decisions, not simply promise Arabic translation. Relevant considerations may include Arabic-first journeys, RTL behavior, bilingual content management, forms, dates, numerals, names, addresses, notifications, payments, identity, support, and regional operating workflows.

Use the project’s requirements to evaluate whether the vendor can:

  • Plan Arabic and English experiences from the same product model
  • Handle RTL navigation, layout, icons, gestures, and mixed-direction content
  • Validate forms, errors, notifications, search, and content expansion
  • Test representative devices, operating systems, and accessibility behavior
  • Identify applicable payment, identity, or business-system dependencies
  • Distinguish provider eligibility and client responsibilities from development work
  • Explain Arabic content ownership, review, and release controls
  • Support Saudi operating hours and stakeholder communication where required

Ask for production examples and test evidence. A translated design file is weaker than a working product whose Arabic flows, defects, and validation process can be demonstrated. Buyers can use this Arabic-first mobile app design guide to define the experience areas a vendor should be prepared to validate.

Do not award additional points solely for having a local address. Score the team’s demonstrated ability to deliver the required Saudi experience.

3. Technical Architecture and Engineering — 15 Points

Architecture should reflect the product’s users, workflows, integration dependencies, scale assumptions, security needs, operating model, and expected roadmap. A list of technologies is not an architecture.

Evaluate whether the vendor can explain:

  • Why native, cross-platform, or another approach fits the project
  • How mobile clients, APIs, backend services, databases, queues, and third parties interact
  • How environments, configuration, secrets, and releases are separated
  • How authentication, authorization, offline behavior, and synchronization work
  • How integration failures, retries, idempotency, and reconciliation are handled
  • Which components need scalability, caching, background processing, or graceful degradation
  • How logs, metrics, traces, crashes, and business-critical events will be observed
  • How code quality, reviews, branching, CI/CD, dependencies, and technical debt are controlled
  • How architecture decisions and trade-offs will be documented

Strong evidence includes a comparable architecture diagram, decision record, API contract, repository workflow, deployment pipeline, performance result, or example of a production trade-off the vendor managed.

Lower the score when the proposed solution is a generic stack reused without reference to project constraints.

4. Security, Privacy, and Data Responsibilities — 15 Points

Security evaluation should connect product risks to design, implementation, testing, release, and operations. Buyers should not accept “we follow best practices” without understanding which practices apply and who owns them.

Evaluate whether the vendor can:

  • Identify sensitive data, privileged actions, likely threats, and abuse cases
  • Define authentication, authorization, session, and role controls
  • Protect data in transit, at rest, on devices, and in logs
  • Manage secrets, certificates, signing assets, and privileged production access
  • Secure mobile APIs and third-party integrations
  • Apply dependency scanning, code review, security testing, and remediation gates
  • Define incident, vulnerability, backup, and recovery responsibilities
  • Explain data collection, retention, deletion, and access decisions
  • Produce security evidence appropriate to the product’s risk

For projects processing personal data, the vendor should be able to translate responsibilities into product and architecture decisions. The PDPL-aware mobile app development guide can help buyers prepare technical questions, but legal applicability and compliance conclusions should receive qualified review.

A security certificate or policy may support the evaluation, but it does not replace project-specific threat analysis and delivery controls.

5. Delivery Governance and Communication — 12 Points

Delivery confidence depends on how the vendor manages decisions, dependencies, progress, quality, changes, and escalation. A methodology label such as Agile does not reveal whether the project will be controlled effectively.

Evaluate whether the vendor defines:

  • Delivery phases, milestones, sprint or iteration cadence, and approval points
  • Named product, project, technical, and client responsibilities
  • Backlog ownership, prioritization, and acceptance workflow
  • Status reports showing progress, decisions, risks, dependencies, and forecast changes
  • Change-request and commercial-impact controls
  • Demonstration, review, and stakeholder-feedback routines
  • Dependency tracking for client and third-party actions
  • Escalation paths and recovery planning when delivery moves off track
  • Team continuity and replacement procedures

Ask to see a redacted status report, risk log, release plan, change record, or retrospective action list. Strong governance makes problems visible early; weak governance reports activity without explaining outcome or risk.

6. Quality Assurance and Release Readiness — 12 Points

QA should begin with requirements and acceptance criteria, not after development is nearly complete. The approach must cover the full product, including backend services, integrations, Arabic and English behavior, devices, environments, performance, security, and release operations.

Evaluate whether the vendor provides:

  • A risk-based test strategy and traceable acceptance criteria
  • Functional, integration, regression, device, and usability coverage
  • Arabic, RTL, and bilingual test scenarios where relevant
  • API, error-state, timeout, retry, and reconciliation tests
  • Automation decisions based on release frequency and risk
  • Performance, load, resilience, and recovery tests when required
  • Defined defect severity, ownership, retest, and release-blocking rules
  • Production-like test environments and controlled test data
  • App-store, phased-release, rollback, monitoring, and launch checks

Strong evidence includes test plans, defect reports, automation results, release-readiness reviews, device matrices, performance reports, or examples of a release stopped because a gate was not met.

Reduce the score when QA is described only as manual testing at the end of each sprint.

7. Commercial Terms, Ownership, and Handover — 12 Points

Commercial comparison should reveal what each price includes, which assumptions can change it, and whether the client can operate the product without unreasonable dependency on the vendor.

Evaluate whether the proposal defines:

  • Scope, exclusions, assumptions, dependencies, and change triggers
  • Team roles, allocation, rates, and replacement rules
  • Milestones, payment events, acceptance, and termination terms
  • Infrastructure, licences, third-party fees, and store-account costs
  • Warranty, maintenance, support, and service boundaries
  • Source-code, design, documentation, data, and IP rights
  • Repository, cloud, app-store, analytics, and integration-account control
  • Documentation, knowledge transfer, credential transfer, and final sign-off
  • Treatment of vendor frameworks, open-source components, and third-party licences

Use the Saudi mobile app development cost guide to normalize cost drivers before comparing totals. The cheapest proposal is not the lowest-risk proposal when important work, team capacity, or ownership terms are missing.

8. Verifiable Evidence and Client References — 8 Points

Evidence should prove that the vendor performed responsibilities relevant to the proposed work. A large portfolio does not help if the vendor cannot explain what it actually delivered.

Evaluate whether the vendor can provide:

  • Live or archived product evidence where disclosure is permitted
  • Its exact responsibility for design, mobile, backend, integrations, QA, or operations
  • Comparable project constraints and decisions
  • Artifacts that support technical and delivery claims
  • Measurable outcomes with a credible method and baseline
  • Evidence that proposed team members performed similar work
  • References able to discuss delivery behavior, not only satisfaction
  • Recent examples relevant to the current capability

Buyers can review software and mobile application case studies as a starting point, but every example should still be tested for exact responsibility, comparability, and evidence strength.

Award fewer points when logos, screenshots, or awards are presented without responsibility or delivery proof.

Need an Independent Scorecard Review?

A scorecard can reveal capability differences, but technical and commercial risks may still be difficult to interpret. Digixvalley can review your requirements, shortlisted proposals, architecture assumptions, and evidence before you select a delivery partner.

Strong Evidence vs. Weak Sales Claims

Vendor evaluation improves when buyers define acceptable evidence before proposals arrive. This prevents confident language, brand recognition, or presentation quality from receiving more weight than delivery proof.

Vendor claimWeak supportStronger evidence
“We have Saudi-market experience”Local office, regional logo, or general market statementComparable Saudi product, exact responsibility, relevant integrations, Arabic validation, and client reference
“We build Arabic-first applications”Translated screens or an RTL switchProduction flows, mixed-direction behavior, Arabic QA records, device testing, and responsible reviewers
“Our architecture is scalable”Cloud logos or a generic diagramAssumptions, bottleneck analysis, load results, scaling decisions, monitoring, and failure behavior
“We follow security best practices”Policy statement or certification aloneThreat model, control ownership, test scope, findings, remediation evidence, and release gates
“We use Agile delivery”Sprint terminologySample plan, backlog controls, status reporting, decision log, demos, and change management
“We provide automated testing”Tool list or coverage percentage without contextRisk-based automation scope, pipeline results, failure handling, and maintained test examples
“You will own everything”Proposal sentence with no boundariesContract terms covering code, accounts, data, designs, documentation, licences, and transfer timing
“We delivered this application”Logo or screenshotExact role, team, dates, artifacts, release evidence, and reference confirmation
“Our clients achieved major growth”Percentage with no baseline or methodDefined metric, period, baseline, attribution boundary, and client confirmation

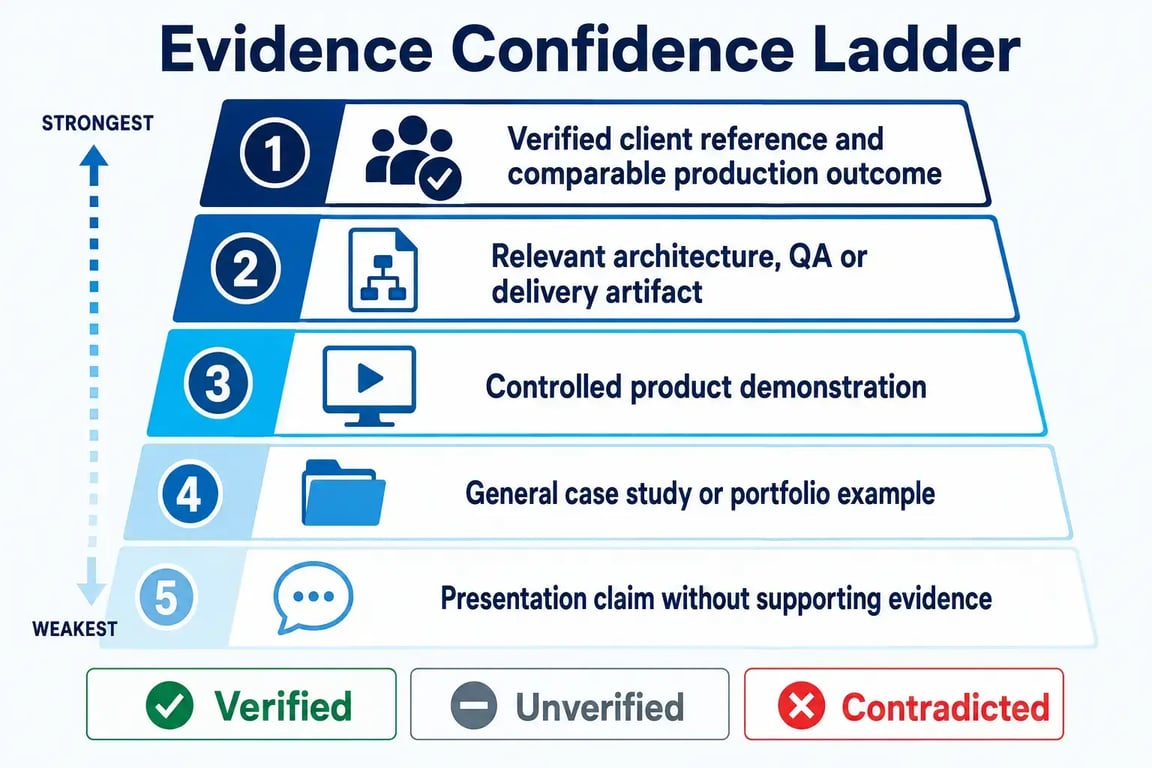

Evidence Hierarchy

Use this hierarchy when two vendors make similar claims:

  1. Verified client or production evidence: A relevant client confirms responsibility and delivery behavior, or the product and release evidence can be independently checked.
  2. Relevant project artifacts: Architecture decisions, test reports, backlog records, release documentation, or other outputs show how the vendor worked.
  3. Controlled demonstration: The vendor demonstrates a relevant system, repository workflow, dashboard, or process while protecting confidential information.
  4. Documented method: A project-specific plan explains activities, owners, outputs, gates, and decisions but has limited proof of prior execution.
  5. Unsupported claim: Marketing language, a tool list, or a general assurance with no method or evidence.

Higher-level evidence deserves more confidence, but relevance still matters. An independently verified eCommerce project may provide little evidence for a high-risk healthcare workflow if the responsibilities and constraints are different.

Verify Exact Responsibility

For every portfolio example, ask which organization owned product strategy, UX, mobile development, backend services, cloud infrastructure, integrations, QA, release, and support. A vendor may have contributed to a product without owning the capability being evaluated.

Check Comparability

Compare the example with the proposed project across user type, transaction risk, data sensitivity, platforms, integrations, Arabic requirements, scale, and operating model. The example does not need to be identical, but the vendor should explain which decisions transfer and which do not.

Protect Confidential Evidence

Confidentiality should not end verification. Alternatives include redacted artifacts, controlled screen sharing, anonymized case details, reference calls, code walkthroughs without copying, or demonstrations of reusable delivery processes.

Check Evidence Freshness

Confirm when the work occurred and whether the people who performed it are part of the proposed team. Old evidence may still be useful, but it should not imply that the same capability, team, or process exists today without confirmation.

Classify Every Material Claim

Use three statuses in the evaluation record:

  • Verified: Appropriate evidence supports the claim.
  • Unverified: The claim may be credible, but evidence is missing or insufficient.
  • Contradicted: Evidence, references, contract terms, or proposal details conflict with the claim.

Do not treat an unverified claim as false. Treat it as uncertainty that should affect the score and the decision.

Adjusting the Scorecard by Project Type

The default scorecard fits a typical Saudi business application, but project risk should determine category weights. Keep the same evidence rules and 0-to-5 scoring scale while changing the importance of each category.

Evaluation categoryStandard business appStartup or MVPEnterprise platformRegulated or sensitive-data app
Product discovery and scope12181210
Saudi-market and Arabic readiness14121212
Technical architecture and engineering15121817
Security, privacy, and data15101522
Delivery governance and communication12151510
Quality assurance and release readiness12101315
Commercial terms, ownership, and handover121586
Evidence and references8878
Total100100100100

Standard Business Application

Use the default profile for customer portals, service applications, booking products, commerce experiences, and operational apps with moderate integration and data risk. It balances product, technical, delivery, and commercial factors.

Startup or MVP

Increase the weight of discovery because the product may contain untested assumptions. Delivery governance also matters because short feedback cycles, prototype validation, and scope decisions should happen quickly.

Commercial flexibility and ownership receive additional weight because early-stage teams need clear burn control, reusable discovery outputs, and freedom to change delivery models. Do not reduce architecture or security below the minimum appropriate to the product’s data and transaction risk.

Enterprise Platform

Increase architecture, delivery governance, and QA weights. Enterprise products often depend on identity systems, legacy platforms, multiple environments, stakeholder approvals, complex roles, data migration, and formal release processes.

Evaluate integration ownership, non-functional requirements, observability, change management, documentation, and support transition in greater depth.

Regulated or Sensitive-Data Application

Security, privacy, data, architecture, and QA should dominate the evaluation. Require explicit threat analysis, access controls, data-flow decisions, security testing, auditability, incident responsibilities, and release gates.

The scorecard does not replace legal, regulatory, privacy, or security review. Use qualified specialists to confirm obligations and required evidence for the specific product and organization.

Creating a Custom Profile

Adjust weights before proposals are scored. Document why each weight changed and confirm that the total remains 100.

Do not change weights after seeing vendor scores unless the requirements genuinely changed. Reweighting after results are known can turn the framework into a justification for a preferred vendor.

The same profile, questions, evidence standards, and formula must be used for every vendor in the comparison.

How to Interpret the Final Vendor Score

The total score indicates overall evaluation strength, but it must be read alongside mandatory gates, category-level risks, evidence quality, and evaluator confidence.

The following bands are suggested starting points. A buyer may set different thresholds before evaluation when its governance or risk appetite requires them.

Final score

Interpretation

Recommended action

85–100

Strong overall fit

Proceed to contract diligence or a paid discovery phase after confirming gates and references

70–84

Viable with identifiable gaps

Clarify weaknesses, negotiate conditions, and rescore affected categories

55–69

Material delivery or evidence risk

Do not proceed without significant remediation, stronger proof, or a tightly bounded paid test

Below 55

Weak fit

Remove from the active shortlist unless the project or proposal changes substantially

Any failed critical gate

Unacceptable unresolved risk

Pause selection regardless of the total score

Review Category Floors

A high total can hide a serious weakness. Establish minimum category scores before evaluation. For example, a regulated product may require at least 4 out of 5 for security and at least 3 for architecture and QA, even if the weighted total exceeds 85.

Separate Capability from Evidence

A vendor may present a credible approach without proving it has delivered that approach before. Record both capability confidence and evidence confidence. Where evidence is limited, reduce the score or make verification a selection condition.

Investigate Evaluator Differences

Compare individual scores before calculating the final result. As a practical review rule, a two-point or larger difference in a category should trigger discussion of the underlying evidence, assumption, or risk. Buyers may set a stricter trigger before scoring.

Do not solve disagreement by automatically using the average. First determine whether someone had missing information or interpreted the requirement differently.

Distinguish Fixable and Structural Gaps

Some gaps can be corrected through a named senior engineer, additional Arabic testing, clearer acceptance criteria, or a revised handover plan. Other gaps are structural, such as refusing client account control, hiding subcontractors, or lacking relevant security capability.

Fixable gaps may become contract conditions. Structural gaps should normally disqualify the vendor.

Use a Risk-Adjusted Decision Record

Decision factor

What to record

Weighted score

Total and category scores using the approved project profile

Mandatory gates

Passed, conditional, or failed with supporting evidence

Evidence confidence

Verified, unverified, or contradicted material claims

Major risks

Probability, impact, mitigation, owner, and target date

Commercial variance

Scope, assumptions, exclusions, team, and cost differences

Conditions

Required proposal or contract changes before approval

Decision

Selected vendor, approval owners, and rationale

Apply Tie-Breakers in the Right Order

When two vendors have similar scores, compare:

  1. Fewer unresolved critical risks
  2. Stronger evidence for the project’s highest-weight categories
  3. Better proposed-team relevance and continuity
  4. Clearer ownership and accountability
  5. More credible discovery and risk-reduction plan
  6. Better normalized commercial value

Do not use the lowest price as the first tie-breaker unless scope, evidence, team, ownership, and delivery risk are genuinely equivalent.

Use Paid Discovery When Uncertainty Remains

A short paid discovery phase can validate collaboration, requirements, architecture assumptions, integration risks, and delivery estimates before a larger commitment. Define the expected outputs, acceptance criteria, duration, team, price, ownership, and exit options in advance.

Paid discovery should reduce uncertainty, not become an indefinite pre-development stage.

Reference-Call Questions That Verify Vendor Performance

Reference calls are most useful after the proposal has been scored. Use them to verify the claims that most influenced the score and the risks that remain unresolved.

Ask for references from projects comparable in product complexity, integrations, data sensitivity, language requirements, delivery model, or scale. When exact comparability is unavailable, record the limitation.

Responsibility, Comparability, and Team

  1. What was the vendor actually responsible for? Ask which parts of discovery, design, mobile development, backend engineering, integrations, QA, cloud operations, release, and support the vendor owned. Compare the answer with the portfolio and proposal claims.
  2. How similar was the project to ours? Confirm the product type, users, platforms, integrations, data risk, language requirements, scale, and delivery constraints. This determines how strongly the reference supports the current decision.
  3. Did the proposed team work on your project? Ask which named people participated, their roles, and whether they remained through delivery. A strong company reference does not confirm the capability of a completely different proposed team.

Scope, Delivery, and Quality

  1. Was the original scope realistic? Ask whether the initial proposal captured important requirements and dependencies. Explore whether later changes resulted from new business decisions, reasonable discovery, or avoidable omissions.
  2. What was the hardest technical or product problem? Request a specific example that shows how the vendor handled uncertainty, trade-offs, and accountability.
  3. What happened when delivery moved off track? Ask how quickly the issue became visible, who escalated it, what recovery plan was created, and whether forecasts were updated honestly. The response is more informative than a claim that nothing went wrong.
  4. How reliable was quality before release? Discuss defect patterns, regression issues, integration failures, device coverage, production incidents, and the client’s testing burden. Confirm whether the vendor’s QA evidence matched actual release quality.

Saudi Readiness, Security, and Commercial Control

  1. How well did the vendor handle Arabic or Saudi requirements? Where relevant, ask about RTL behavior, bilingual content, forms, payments, identity, regional workflows, and local stakeholder communication. Determine whether the vendor led these decisions or relied on the client to identify every issue.
  2. How were security and data responsibilities managed? Ask whether access, testing, vulnerabilities, production incidents, backups, and data decisions had clear owners. Do not request confidential details; focus on process, accountability, and evidence.
  3. Were commercial changes predictable? Confirm whether invoices, change requests, team allocation, third-party costs, and schedule impacts were consistent with the agreement. Ask which costs or assumptions surprised the client.
  4. Did the client receive practical ownership? Ask when the client received repository access, app-store control, cloud access, documentation, credentials, and knowledge transfer. Confirm whether another team could maintain the product after handover.
  5. What was post-launch support like? Discuss response times, defect ownership, monitoring, release support, operating-system changes, third-party updates, and escalation. Compare the answer with the proposed warranty and support model.

Final Reference Judgment

  1. What would you change if you started again? This may reveal weaknesses in discovery, team composition, architecture, communication, acceptance, or commercial structure that a general satisfaction question misses.
  2. Would you hire the vendor again for a similar project? Follow a yes or no answer with “under what conditions?” A conditional answer can identify where the vendor performs well and where additional controls are needed.

Strong and Weak Reference Signals

Strong signal

Weak signal

Specific examples with dates, responsibilities, and outcomes

General praise with no delivery detail

Reference confirms claims made in the proposal

Reference describes a different capability or team

Problems and recovery actions are explained openly

Reference claims nothing went wrong

Ownership and handover were practical

Client depended on vendor-controlled accounts or undocumented knowledge

Commercial changes were traceable

Cost or schedule changes arrived without clear evidence

Client would rehire the vendor for a defined project type

Rehire answer is vague or unrelated to the proposed work

Record the reference’s role, project relationship, date of engagement, relevant similarities, verified claims, new risks, and any limits on what could be confirmed.

Final Vendor Selection Workflow

The selection process should create a traceable path from business requirements to contract approval. The following workflow keeps comparison consistent while giving buyers clear opportunities to stop, clarify, or reduce risk.

Phase 1: Prepare the Evaluation

Step 1: Define the project.

Document the business outcome, users, main journeys, platforms, languages, integrations, data sensitivity, target release, operating model, and known constraints. Separate confirmed requirements from assumptions that still need validation.

Step 2: Select the scoring profile.

Choose the standard, startup, enterprise, regulated, or custom weight profile before reviewing proposals. Set any minimum category scores and identify critical mandatory gates.

Step 3: Build a qualified shortlist.

Screen vendors for relevant delivery capability, team availability, operating fit, and willingness to meet the mandatory gates. Keep the shortlist manageable enough for meaningful evidence review and reference checks.

Step 4: Issue the same evaluation pack.

Provide every vendor with identical requirements, response instructions, timelines, assumptions, questions, and evidence requests. Use one clarification log so material information is shared fairly.

Phase 2: Compare Vendors Consistently

Step 5: Normalize proposals.

Create a comparison table before scoring.

Comparison field

Normalize across vendors

Scope

Included journeys, features, platforms, integrations, environments, and exclusions

Team

Roles, seniority, allocation, location, and start availability

Delivery

Discovery, design, development, QA, release, and support activities

Client dependencies

Content, decisions, credentials, provider contracts, test data, and approvals

Commercials

Price model, assumptions, change triggers, payment events, licences, and infrastructure

Ownership

Code, designs, documentation, accounts, data, and third-party components

Timeline

Phase durations, dependencies, review time, contingency, and launch support

Do not compare headline prices until these fields are aligned.

Step 6: Collect and classify evidence.

Map each material claim to supporting evidence and mark it verified, unverified, or contradicted. Record confidentiality limits without assuming that a claim is verified merely because evidence cannot be shared.

Step 7: Score independently.

Ask relevant stakeholders to score vendors separately.

Stakeholder

Primary evaluation focus

Business or product owner

Outcomes, users, scope, priorities, and product decisions

Engineering or architecture

Technical fit, integrations, scalability, maintainability, and operations

Security or privacy

Threats, data, access, testing, incidents, and accountability

Delivery lead

Planning, dependencies, communication, governance, and continuity

Procurement or legal

Commercial clarity, ownership, licences, acceptance, and exit terms

Evaluators should cite the proposal section, artifact, answer, or reference supporting each high or low score.

Step 8: Apply mandatory gates.

Assess every gate independently of the weighted score. Pause vendors with failed critical gates and create a dated resolution list for conditional gates.

Phase 3: Verify Claims and Reduce Uncertainty

Step 9: Run clarification sessions.

Use clarification meetings to resolve scoring differences and material uncertainties. Ask the proposed delivery team to participate. Send unanswered questions in writing and update the evidence record after receiving responses.

Step 10: Complete reference checks.

Select references that can verify the highest-weight capabilities and the vendor’s exact responsibility. Record confirmed claims, contradictions, risks, and reference limitations.

Step 11: Use paid discovery when necessary.

For complex or uncertain projects, commission a bounded discovery phase before the full build. Require reusable outputs such as validated requirements, user flows, architecture decisions, integration findings, risk register, estimate, and delivery roadmap.

Phase 4: Contract, Approve, and Transition

Step 12: Complete contract and ownership diligence.

Translate the selected approach into binding terms. Confirm scope, acceptance, team, substitutions, change control, security, data, IP, account control, documentation, warranty, support, termination, and handover.

Check that the contract does not weaken commitments that earned points during evaluation.

Step 13: Approve a decision record.

Document the selected vendor, final score, gate status, evidence confidence, references, normalized commercial position, key risks, required conditions, and approving stakeholders. Also record why the closest alternatives were not selected.

Step 14: Transition into delivery.

Use the evaluation record as an input to kickoff. Confirm that risks, assumptions, commitments, owners, and conditions move into the discovery plan, backlog, architecture decisions, and governance process.

Selection is complete only when the evidence and commitments behind the decision become visible delivery controls.

This gives your business something operationally useful.

Final Takeaway

Selecting a mobile app development company in Saudi Arabia should not depend on the most polished presentation, the largest portfolio, or the lowest quoted price. A stronger decision begins with mandatory disqualification gates and continues with a weighted evaluation of discovery, Saudi readiness, architecture, security, delivery, QA, ownership, and supporting evidence.

The final score is a decision aid rather than the complete decision. Buyers should investigate category-level weaknesses, verify important claims through artifacts and client references, normalize proposal differences, and use paid discovery when technical or commercial uncertainty remains.

Start by selecting the appropriate project profile in the editable scorecard. Apply mandatory gates, record the evidence behind every material score, and carry the final conditions into the contract and delivery plan.

A high total score should never compensate for unacceptable risks involving source-code ownership, data responsibilities, team transparency, security, or operational continuity. The strongest vendor is the one whose proposed team, delivery approach, contractual commitments, and verified experience match the project’s actual risk profile.

Document the evidence, assumptions, unresolved risks, and approval conditions behind the final choice. This creates a defensible vendor decision and provides a clearer foundation for moving from evaluation into accountable delivery.

Need Help Reviewing Your Vendor Shortlist?

Digixvalley can review your requirements, compare shortlisted vendors, identify proposal gaps, and assess technical or commercial risks before you commit to a development contract.

FAQs

How Many Mobile App Vendors Should a Saudi Business Shortlist?

A shortlist of three to five qualified vendors is a practical starting range for many buyers. Use a smaller or larger group when procurement rules or market availability require it, but keep the list manageable enough for meaningful technical validation, proposal analysis, and reference checks. Remove vendors that fail a mandatory gate before applying the weighted scorecard.

Should a Saudi Business Choose a Local or Offshore Development Company?

Neither option is automatically better. Evaluate the actual delivery team, Arabic capability, Saudi-market knowledge, communication process, security controls, integration experience, and supporting evidence.

A local address does not guarantee delivery quality. An offshore company can remain a viable choice when it demonstrates Saudi readiness and provides reliable communication and support coverage.

How Can Buyers Verify That a Mobile App Portfolio Is Genuine?

Ask for live app-store links, the project timeline, the vendor’s exact responsibilities, relevant artifacts, and a client reference. Confirm whether the proposed team performed similar work and whether the product’s release history supports the claim.

Logos, screenshots, and general case-study descriptions do not establish that the vendor designed, developed, or operated the application.

Is Paid Product Discovery Useful Before a Full Development Contract?

Paid discovery is useful when requirements, integrations, architecture, data responsibilities, or delivery estimates remain uncertain. Expected outputs should include validated requirements, user flows, architecture decisions, technical risks, estimates, and a delivery roadmap.

The client should be allowed to retain and reuse these outputs. Paid discovery may be unnecessary when the project scope has already been independently validated and contains little uncertainty.

About Author

Zayn Saddique is the CEO & Owner with strong expertise in digital transformation, web development, mobile app development, custom software, and AI solutions services. He helps startups, SMEs, and enterprises leverage innovative, scalable, and business-focused technologies to stay competitive in a rapidly evolving market. With a deep understanding of modern trends and intelligent solutions, he is dedicated to delivering practical strategies that drive growth, efficiency, and long-term success.
Zayn Saddique

Let’s Build Something Great Together!

Latest Blogs

Wait! Before You Press X,

See What You Could Gain!

aws partner
google partner
microsoft azure
cloudflare

* Mandatory Field
