Mobile app product discovery helps a business decide whether an application should be built, what its first release should contain and which risks must be resolved before greater investment.
For a Saudi mobile application, discovery may need to examine Arabic and English journeys, data responsibilities, third-party integrations and internal approval requirements. These considerations should be included only when they affect the product, organization or intended users.
Businesses still defining the broader delivery approach can first plan a Saudi-ready mobile app project and use discovery to resolve the assumptions preventing reliable scope, estimates or vendor proposals.
Mobile app product discovery should validate the problem, identify priority users and journeys, test high-risk assumptions, investigate technical dependencies, define the smallest defensible release and produce a documented Go, Conditional Go, Extend, Pause or No-Go decision.
Discovery does not need to remove every uncertainty. It should reduce the uncertainties capable of changing product value, scope, architecture, cost, timeline or operating responsibility.

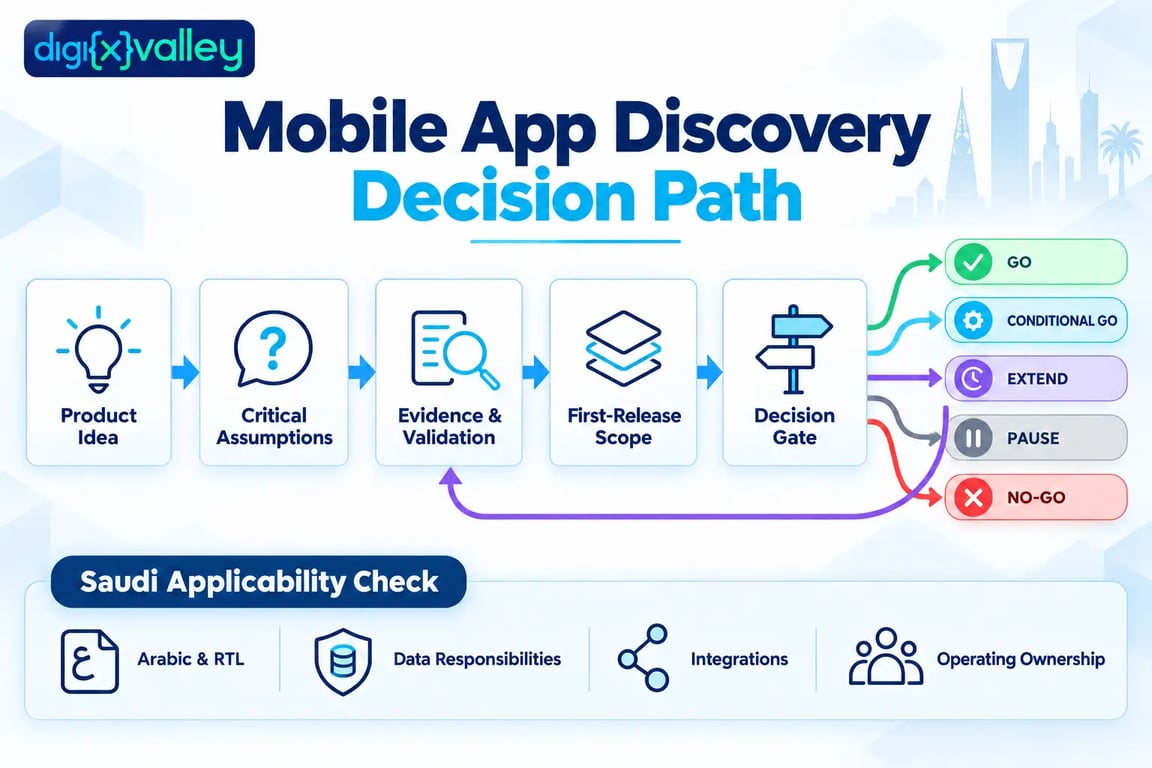

What Mobile App Product Discovery Must Decide
A discovery engagement should begin with a decision mandate rather than a workshop schedule. The organization must identify what it needs to learn before approving an RFP, development contract, pilot or further investment.
For one project, the central uncertainty may be whether users need the proposed workflow. Another may depend on access to an identity, payment, logistics or internal business system. A third may have validated demand but still lack a credible release boundary.
Decision area | What discovery must establish |
|---|---|
Problem and outcome | Whether the application addresses an important, evidence-supported need |
Users and journeys | Who needs the product and which tasks must succeed |
Assumptions | Which beliefs are supported, rejected or still unresolved |
Release boundary | What is required, conditional, deferred or excluded |
Saudi applicability | Which bilingual, data, sector or integration requirements apply |
Technical feasibility | Whether the release can meet its essential operating conditions |
Delivery viability | Whether scope, dependencies, responsibilities and investment form a credible plan |
Final gate | Whether to proceed, proceed conditionally, investigate, pause or stop |
A discovery output is useful only when it supports or changes a decision. Interview notes without conclusions, wireframes without validated journeys and architecture diagrams without recorded trade-offs demonstrate activity but do not establish readiness.
The final record should show what was assumed, what was investigated, what the evidence established, what remains unresolved and who is authorized to decide.
Discovery is complete when the organization has enough evidence to make the next investment decision—not when every possible question has been explored.
Choose the Right Validation Stage
A project brief, discovery engagement, prototype and minimum viable product serve different purposes. Treating them as interchangeable can cause a business to request vendor estimates before the product is ready to be estimated.
Stage | Primary purpose | Expected output | What it does not prove |
|---|---|---|---|
Project brief | Describe the initial business context, users, objectives and constraints | A shared starting point for discussion | That the proposed solution is validated or technically feasible |
Product discovery | Investigate decision-critical assumptions and define a defensible release | Evidence register, validated journeys, scope boundary, risks and gate decision | That every delivery risk has been eliminated |
Prototype | Test a specific workflow, interaction or technical assumption | User feedback or technical findings tied to a defined question | That the product is production-ready |
MVP | Release the smallest operational product capable of producing meaningful evidence | A working first release with measurable outcomes | That market fit, adoption or commercial success is guaranteed |
Discovery can include prototypes, but producing screens is not its primary objective. A prototype is valuable only when it tests a documented assumption and produces evidence that affects scope, design or the investment decision.
An MVP comes later. It should be built only when the organization has enough confidence in the problem, priority journeys, release boundary and delivery conditions to justify production investment.
When a Separate Discovery Phase Is Needed
Project risk—not project size—should determine whether formal discovery is necessary. A relatively small application may still require discovery when it depends on an uncertain integration, an untested user journey or an unresolved operating responsibility.
For a Saudi mobile app, uncertainty may also involve Arabic and English experiences, identity or payment services, data responsibilities, sector-specific conditions or internal approval processes. These factors should enter discovery only when they apply to the proposed product.
Use three questions to determine whether an assumption belongs in discovery:
- Decision impact: Could the answer materially change product value, scope, architecture, cost, timeline or operational responsibility?
- Evidence gap: Does the organization lack reliable evidence supporting the current assumption?
- Validation value: Can targeted research, prototyping or technical investigation reduce the uncertainty before development?
When all three answers are yes, the assumption should normally be investigated before a major delivery commitment.
A separate discovery engagement may be unnecessary when the organization already has validated users and journeys, confirmed integration access, a clear first-release boundary, named decision owners, measurable acceptance conditions and a credible plan for operating the application.
Existing designs do not automatically remove the need for discovery. Screens may show how an experience could work without proving that the workflow is needed, technically achievable or operationally supported.
A fixed deadline also does not eliminate discovery. When missing a launch date would have serious consequences, focused discovery can become more important because unresolved dependencies must be identified earlier.
Run discovery when the cost of validating a critical assumption is lower than the likely cost of discovering that assumption during development.
Inputs Required Before Mobile App Discovery Begins
Discovery should not begin from a blank canvas. The team needs enough context to focus its investigation, identify missing evidence and avoid spending workshops reconstructing information the organization already holds.
The starting material does not need to be complete. Its purpose is to establish a traceable baseline rather than predetermine the solution.
Input area | What should be available at the start |
|---|---|
Decision mandate | The investment decision discovery must support and who has authority to make it |
Business context | The problem, desired outcome and reason the application is being considered |
Users and journeys | Known user groups, priority tasks and current workflow problems |
Existing evidence | Research, analytics, customer feedback, operational data or previous experiments |
Business constraints | Indicative budget, target dates, procurement conditions and fixed commitments |
Technical environment | Existing systems, integrations, authentication methods, data sources and known access limitations |
Saudi applicability | Intended market, required languages, relevant data responsibilities, local integrations and possible sector conditions |
Operating ownership | Expected owners for content, support, releases, security decisions and ongoing product performance |
A deadline or budget should be recorded as a constraint, not silently converted into proof that the proposed scope is achievable. Discovery must test whether the expected release can fit those boundaries and show which trade-offs would be required.
Existing materials should also be treated according to their evidence strength. A stakeholder opinion, for example, should not carry the same confidence as observed user behaviour or verified system documentation.
Use three simple classifications for every starting input:
- Confirmed: Supported by accessible evidence or an accountable owner.
- Assumed: Currently accepted but still requires validation.
- Unknown: Not yet answered and potentially important to the decision.
This classification prevents assumptions from entering the release plan as established facts.
Minimum Conditions for Starting Discovery
Discovery is ready to begin when the organization has a named sponsor, a clear decision to support and reasonable access to the people or systems needed for investigation. Product, technical, operational and compliance representatives do not need to attend every activity, but their availability and decision responsibilities should be agreed in advance.
Missing information does not always justify delaying discovery. A gap can become a documented assumption with an owner, validation method and deadline.
The engagement should be paused, however, when nobody can authorize a decision, essential stakeholders are unavailable or the organization cannot explain what decision the work is intended to inform. Under those conditions, discovery is likely to produce documents without resolving investment uncertainty.
Begin discovery with sufficient context to investigate the product not with a requirement that every answer already exists.
Saudi Applicability Gate: What Must Be Confirmed Before Detailed Discovery
A mobile app intended for Saudi users should not be labelled Saudi-ready based only on Arabic screens or local branding. The project must first determine which market, data, sector, integration and operating conditions actually apply.
This is an applicability gate, not a legal approval exercise. Its purpose is to expose requirements that could materially affect research, user experience, architecture, scope or vendor responsibilities. Legal, privacy, security and sector specialists should confirm matters within their authority.
Applicability area | Question discovery must answer | Required output |
|---|---|---|
Users and language | Who will use the application, and which journeys require Arabic, English or both? | Agreed language scope, RTL requirements and journeys requiring bilingual validation |
Personal data | What identifiable or sensitive information will be collected, used, stored or shared? | Preliminary data inventory, processing purposes and named responsibility owners |
Organization roles | Which party determines how data is used, and which vendors process it on the organization’s behalf? | Initial responsibility map covering the organization, development vendor and third parties |
Sector conditions | Does the product operate in a regulated or approval-dependent sector? | Applicable requirements, confirming authority and unresolved compliance questions |
External integrations | Does the release depend on identity, payment, messaging, mapping or government and enterprise systems? | Integration owners, access status, technical constraints and fallback decisions |
Hosting and transfers | Where will environments and data be hosted, and will any vendor or service process data outside Saudi Arabia? | Proposed hosting model, third-party register and questions requiring specialist review |
Accessibility | Are public-sector, organizational or user-specific accessibility standards applicable? | Testable accessibility requirements included in design and acceptance criteria |
Product operations | Who will manage Arabic content, support, incidents, releases and third-party service changes? | Named operational owners and a support-continuity model |
Where personal data is within scope, the discovery team should define PDPL-aware data responsibilities and route legal conclusions to the organization’s qualified privacy or legal owner.
Each area should receive one of three classifications:
- Applicable: Convert the condition into a requirement, risk, acceptance criterion or architectural constraint.
- Not applicable: Record the reason and the person who confirmed it.
- Unconfirmed: Assign an owner, evidence requirement and resolution date.
Unconfirmed must not be interpreted as “not applicable.” If the answer could change data architecture, integration design, release approval or contractual responsibility, the matter should remain visible until an accountable specialist resolves it.
Passing the Applicability Gate
The project can proceed into detailed discovery when all high-impact areas have been assessed and every applicable condition has an owner. Lower-impact uncertainties may remain open when their validation method and deadline are documented.
The gate should be conditional when an important question remains unresolved but can be investigated safely during discovery. It should pause when an unknown requirement could invalidate the proposed architecture or release and no responsible owner or validation route exists.
Saudi readiness should be demonstrated through applicable requirements, assigned responsibilities and testable evidence not inferred from the project location.
Need an Independent Scorecard Review?
Core Mobile App Product Discovery Workstreams
Mobile app discovery should be organized around decisions, not a fixed sequence of workshops. Each workstream must reduce a defined uncertainty and produce evidence that can change the product or investment decision.
The depth of each workstream should reflect project risk. A product with well-understood users but an uncertain enterprise integration may require more technical investigation. A technically simple application with uncertain demand may require stronger user research and prototype testing.
Discovery workstream | Decision it must support | Minimum useful output |
|---|---|---|
Problem and outcomes | Is the problem important enough to justify investment, and what result should the product create? | Evidence-supported problem statement, baseline conditions and measurable outcome |
Users and journeys | Who needs the product and which tasks must succeed? | Priority-user definition, current journey, observed problems and evidence gaps |
Release and experience | What is the smallest coherent release capable of producing the intended outcome? | Validated journeys, scope boundary and prototype findings where needed |
Technical feasibility | Can the release operate within its integration, performance and platform constraints? | Architecture decisions, access status, technical-spike results and unresolved dependencies |
Data, security and applicability | Which data, security, language and sector conditions affect the product? | Data flow, responsibility map, applicable requirements and specialist decisions |
Delivery and operations | Can the organization build, launch, support and improve the release responsibly? | Delivery model, ownership, roadmap, estimate assumptions and operational risks |
The workstreams should inform one another rather than operate as separate departmental exercises. A change to an Arabic user journey may affect data collection, integration design, support responsibilities and release scope. A failed technical spike may require a different workflow rather than only a different engineering task.
Each workstream should close with a supported decision, a contradicted assumption, an unresolved condition with an owner or a reason the matter is outside the approved discovery boundary.
Workstream principle: Every activity should produce evidence, resolve a decision or expose a dependency. If it does none of these, it should not consume discovery time.

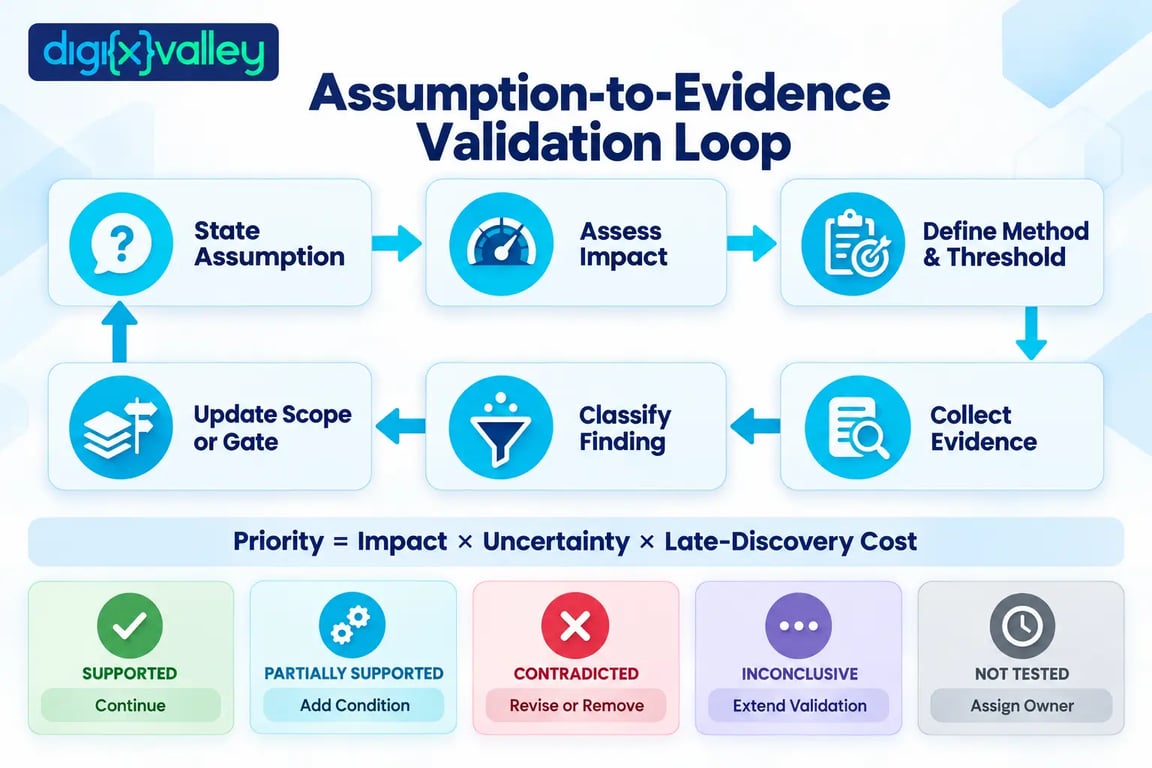

Assumption-to-Evidence Register and Validation Priorities
Discovery becomes useful when assumptions are converted into testable statements. Until supporting evidence is available, stakeholder confidence should not be treated as proof.
Each important assumption should be recorded with the decision it affects, the consequence if it is wrong, the existing evidence, the validation method, a success threshold, an owner and the resulting action.
A practical prioritization rule is:
Validation priority = consequence if wrong × evidence uncertainty × cost of discovering the answer late
This does not require a complicated numerical model. High, medium and low classifications are sufficient when the reasoning is recorded. An assumption should receive early attention when it could invalidate the product, substantially change architecture or make the release operationally unviable.
Low-impact preferences can remain in the backlog until the critical assumptions have been investigated.
Evidence Classifications
After investigation, each assumption should receive a clear evidence status:
- Supported: The agreed evidence threshold has been met.
- Partially supported: Some elements are supported, but a bounded gap still affects the decision.
- Contradicted: The evidence does not support the assumption.
- Inconclusive: Some evidence exists, but it is insufficient for a reliable decision.
- Not tested: Validation has not yet taken place.
A contradicted assumption is not a failed discovery outcome. Identifying it before development is evidence that discovery has prevented avoidable investment.
Illustrative Assumption-to-Evidence Register
The following example is illustrative, not a real client case or a universal benchmark. It shows how a hypothetical Saudi field-service booking application could connect findings to release decisions.
Assumption | Impact if wrong | Validation method and project-specific threshold | Illustrative finding | Status and decision effect |
|---|---|---|---|---|
Arabic-speaking customers can complete the priority booking journey without assisted support | High | Usability test with 10 representative users. At least 8 must complete the critical path without moderator assistance or a blocking error | Seven users completed it. Three misunderstood the address-confirmation step | Contradicted. Redesign the address step and retest before confirming the journey |
The existing scheduling system can create, reschedule and cancel appointments through its API | High | Review verified documentation and complete all three actions using test data in a sandbox | Documentation was supplied, but sandbox access was not available | Inconclusive. Make successful technical validation a condition before committing to the integration scope |
Online payment is required in the first release | Medium | Map the operational journey and confirm whether payment on service completion can support the intended launch | The operations owner accepted payment on completion for the initial controlled release | Contradicted. Defer in-app payment unless later user evidence changes the decision |
The service team can support bookings during all advertised operating hours | High | Confirm staffing ownership, escalation coverage and response expectations with the operating team | Weekday coverage was assigned, but weekend coverage remained unapproved | Partially supported. Restrict launch hours or resolve weekend ownership before release |
The usability threshold in this example tests whether people can operate a defined journey. It does not establish market demand or predict adoption. Different assumptions require different evidence standards.
Turning Findings Into Product Decisions
A finding should never end as an isolated research observation. It must change at least one downstream artifact, such as the release scope, journey design, architecture, risk register, estimate, acceptance criteria or gate decision.
If evidence contradicts a proposed feature, the team should revise or remove the feature. If a critical assumption remains inconclusive, its owner, deadline and investment consequence should appear in the Conditional Go record.
Evidence principle: An assumption is not resolved because it has been discussed. It is resolved when agreed evidence supports or contradicts it strongly enough to make a decision.
Required Mobile App Discovery Deliverables and Acceptance Criteria
A discovery deliverable is complete only when it supports a decision. File creation alone does not demonstrate that the problem, scope or technical risks have been resolved.
The organization should agree on deliverables and acceptance conditions before discovery begins. This prevents disagreements about whether a presentation, prototype or backlog represents finished work.
Deliverable | Minimum required content | Acceptance condition |
|---|---|---|
Product decision brief | Problem, priority users, desired outcome, constraints and decision mandate | The sponsor confirms that the brief represents the decision discovery was commissioned to support |
User and journey evidence | Research sources, priority journeys, observed problems and unresolved questions | Findings distinguish evidence from opinion and show how the release was affected |
Assumption-to-evidence register | Assumption, impact, validation method, threshold, finding, status and owner | Every high-impact assumption is supported, contradicted or assigned a resolution condition |
First-release scope | Included, conditional, deferred and excluded capabilities with rationale | Every item has a defined boundary, dependency and acceptance condition |
Prototype and validation record | Tested hypothesis, prototype version, participant criteria, findings and design changes | Results demonstrate what was tested and what changed; visual approval alone is insufficient |
Technical feasibility pack | System context, integration status, data flows, technical constraints, non-functional needs and investigation results | Critical dependencies are verified or recorded as conditions with owners and deadlines |
Responsibility and operating model | Product, data, security, content, support, account and release ownership | No critical responsibility remains assigned only to “the business,” “IT” or “the vendor” |
Delivery roadmap and estimate | Phases, dependencies, assumptions, team needs, estimate range and major risks | The estimate is traceable to the agreed scope and clearly states what could change it |

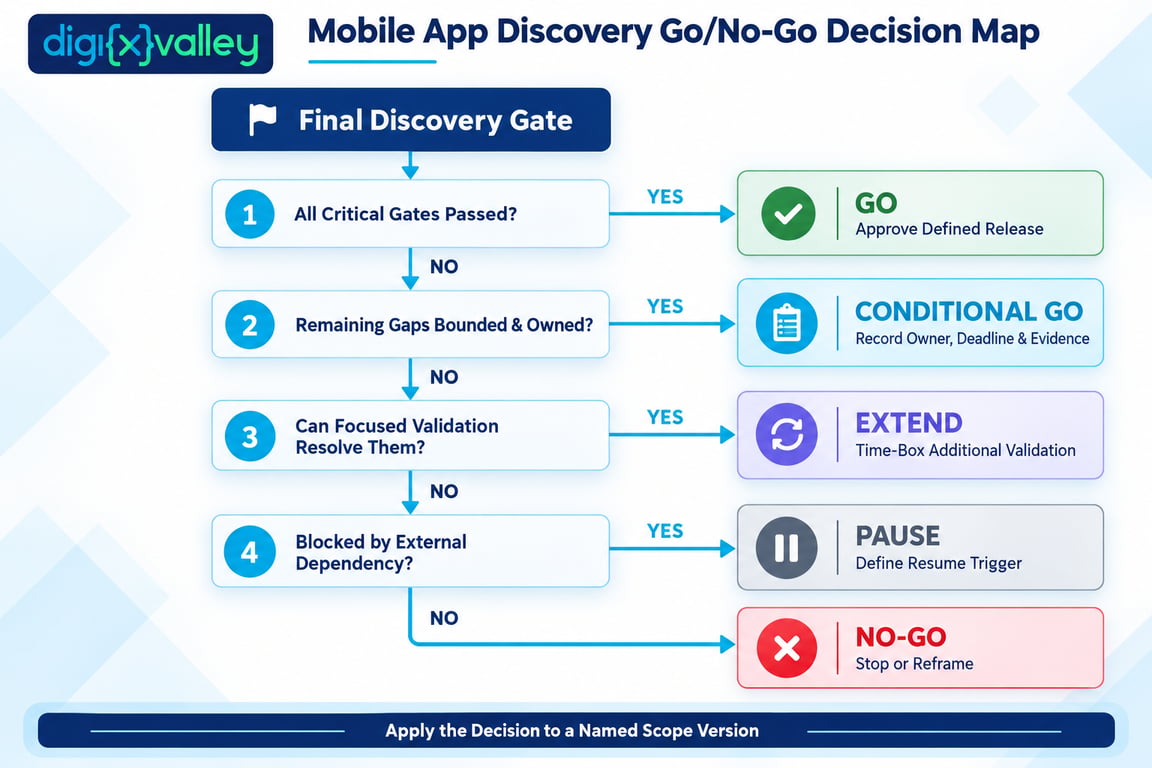

Final gate record | Go, Conditional Go, Extend, Pause or No-Go decision with supporting evidence | The authorized decision-maker signs off on the result and every condition has an owner and due date |
Make Acceptance Conditions Observable
Acceptance language should describe what can be checked. Terms such as complete, professional, user-friendly or scalable are too subjective when no observable condition accompanies them.
For example, integration feasibility assessed is weak. A stronger condition states that API documentation has been reviewed, sandbox access has been confirmed, the critical transaction has been tested and unresolved limitations have been assigned to an owner.
The same principle applies to design. A clickable prototype is not automatically accepted because stakeholders like its appearance. The record should identify the journey tested, the users represented, the problems observed and the changes made in response.
Discovery Handover Quality
A team that did not attend the discovery workshops should still be able to understand:
- What problem the application is intended to solve.
- Which users and journeys have priority.
- What belongs in the first release and what does not.
- Which assumptions are supported, contradicted or unresolved.
- What must happen before development can proceed safely.
A slide deck without source evidence, an unprioritized feature backlog, an untested prototype or an estimate without assumptions should not pass acceptance.
All accepted artifacts should include a version, owner, reviewer and decision date. Links to supporting evidence should remain accessible to the organization after the engagement ends.
Acceptance principle: A discovery artifact is finished when another accountable team can use it to make or execute the next decision without reconstructing the reasoning behind it.
Discovery Roles, Decision Rights and RACI Matrix
Mobile app discovery requires clear decision rights. The organization should know who can approve the product direction, who owns the evidence and who must resolve specialist questions.
A vendor may lead discovery activities without becoming accountable for the client’s investment, privacy, legal or sector decisions. Only one role should be accountable for each decision; shared attendance does not replace clear authority.
Discovery activity | Accountable | Responsible | Consulted | Informed |
|---|---|---|---|---|
Confirm the decision mandate | Executive sponsor | Product owner and discovery lead | Finance or procurement, technical lead | Discovery team |
Validate users and priority journeys | Product owner | UX or research lead | Discovery lead, operations, technical specialists | Executive sponsor |
Prioritize assumptions | Product owner | Discovery lead | UX, technical, privacy, security and operations specialists | Executive sponsor |
Confirm Saudi applicability | Organization’s privacy, compliance or sector owner | Assigned specialist and discovery lead | Product owner, technical lead, legal counsel where needed | Executive sponsor |
Define the first-release boundary | Product owner | Discovery lead | UX, technical, operations and specialist owners | Executive sponsor |
Assess architecture and integrations | Technical lead | Architecture or engineering lead | Product, security, data and third-party owners | Executive sponsor |
Confirm the operating model | Operations owner | Operational lead | Product, technical, support and security owners | Executive sponsor |
Accept discovery deliverables | Product owner | Discovery lead | Workstream owners and reviewers | Executive sponsor |
Make the final gate decision | Executive sponsor | Product owner prepares the recommendation | Technical, privacy, security, operations and procurement owners | Delivery team |
Preserve Client Decision Authority
The discovery lead should organize evidence, expose disagreements and maintain the decision record. The role should not convert a workshop majority into an approved business decision.
Technical, privacy, security and operational specialists should confirm conclusions within their authority. The executive sponsor remains accountable for accepting residual investment risk, while the product owner controls the release boundary.
If a critical decision has no accountable owner, the engagement should treat that absence as a readiness issue rather than assigning it informally to the development vendor.
Ownership principle: Every critical decision requires one accountable owner, a documented evidence basis and a visible consequence.
Go/No-Go Gates and the Final Discovery Decision Record
Discovery should finish with an explicit investment decision, not a general recommendation to move forward. The decision must apply to a named scope version and be supported by traceable evidence.
Gate thresholds should be agreed before validation begins. A team should not lower a threshold after receiving an inconvenient result simply to preserve the original solution.
Decision gate | Minimum condition for passing |
|---|---|
Problem and outcome | Evidence supports an important problem, a defined user group and an outcome the organization can measure |
Priority journeys | Critical journeys have been investigated and no unresolved usability issue prevents the intended outcome |
Release boundary | Included, conditional, deferred and excluded capabilities are documented with acceptance conditions |
Technical feasibility | Critical architecture and integration assumptions are verified or controlled through explicit conditions |
Saudi applicability | Relevant language, data, sector and operating conditions have been assessed and assigned to accountable owners |
Delivery and operations | Required people, dependencies, support ownership and release responsibilities form a credible operating plan |
Investment viability | The sponsor understands the estimate range, assumptions, remaining risks and consequences of scope changes |
Passing a gate does not mean the area is risk-free. It means the remaining uncertainty is understood and acceptable for the next investment stage.
Select the Correct Discovery Outcome
Outcome | When it should be used | Required next action |
|---|---|---|
Go | All critical gates pass and remaining risks fall within the organization’s agreed tolerance | Approve the defined release for procurement or delivery planning |
Conditional Go | The direction is supported, but bounded dependencies must be resolved before an irreversible commitment | Record each condition, owner, deadline, required evidence and failure consequence |
Extend | Evidence remains insufficient, but focused additional investigation is likely to resolve it | Approve a time-boxed validation extension with specific questions and outputs |
Pause | Progress is blocked by access, governance, funding or an external dependency | Define the resume trigger and preserve the current evidence record |
No-Go | Evidence contradicts the product case, feasibility or acceptable investment conditions | Stop the current release direction or return for substantial reframing |
A No-Go decision is not evidence that discovery failed. It may represent the highest-value outcome when it prevents an unsupported product from entering development.
Conditional Go should not become a way to hide unresolved blockers. It is appropriate only when the remaining condition is specific, owned, time-bound and capable of being verified before the affected commitment.
Illustrative Conditional-Go Decision Record
The example below continues the hypothetical Saudi field-service booking application introduced earlier. It is not a real client result, and its thresholds should not be treated as universal standards.
Decision: Conditional Go for a controlled first release covering service selection, address confirmation, appointment booking, rescheduling and booking-status updates.
The revised Arabic booking journey passed the project’s usability threshold after the address step was redesigned. Payment was deferred because the operating team could support payment on service completion. Weekday support ownership was confirmed, while weekend bookings were removed from the release boundary.
The scheduling integration remained unresolved because the API sandbox had not been provided. The decision therefore could not become an unconditional Go.
Condition | Accountable owner | Required evidence | Deadline or control point | Consequence if unmet |
|---|---|---|---|---|
Obtain access to the scheduling sandbox | Client integration owner | Working credentials and representative test data | Before final integration scope approval | Do not commit to a fixed integration estimate |
Validate create, reschedule and cancel actions | Technical lead | Recorded technical-spike results for all three transactions | Before development Sprint 1 | Return the integration to Extend or revise the release |
Confirm the preliminary personal-data flow and responsibility map | Organization’s privacy owner | Reviewed data-flow record and assigned responsibilities | Before architecture approval | Do not use production personal data |
Approve the restricted operating hours | Operations owner | Signed release-hours and escalation record | Before release baseline approval | Limit the release or pause operational launch |
The final decision record should also identify the approved scope version, evidence reviewed, accepted residual risks, decision authority and next review date. Conditions should remain visible in procurement documents, delivery plans and acceptance criteria until they are closed.
Gate principle: Approve only the scope supported by evidence. A promising product direction does not justify accepting an unresolved critical dependency.
From Discovery to RFP, Estimation and Development Handoff
Discovery should not end with a folder of documents. Its outputs must be converted into procurement, contractual and delivery controls that preserve the decisions already made.
The correct handoff depends on who will build the product. When a vendor has not been selected, the evidence and release boundary should become the basis of a structured RFP. When a delivery partner is already appointed, the same material should inform estimation, architecture planning and the statement of work. An internal team should receive an equivalent decision-ready package.
Discovery output | How it should be used next |
|---|---|
Product decision brief | Establish the business context, intended users and expected outcome |
Validated release boundary | Define the scope vendors or delivery teams must estimate |
Assumption-to-evidence register | Expose supported decisions, unresolved risks and prohibited assumptions |
Acceptance-criteria matrix | Inform contractual deliverables, backlog acceptance and user-acceptance testing |
Technical feasibility pack | Support architecture review, integration estimates and technical due diligence |
Responsibility model | Establish governance, approvals, operational ownership and vendor boundaries |
Gate decision record | Preserve conditions that must be resolved before contract, development or launch |
Delivery roadmap and estimate | Support funding approval, vendor comparison and staged investment decisions |
Convert Scope Into a Comparable Estimate
A discovery estimate is not automatically a fixed commercial commitment. It remains dependent on the scope version, integration evidence, delivery model, quality expectations and unresolved conditions used to create it.
Every estimating party should receive the same baseline and restate its assumptions, exclusions, dependencies and team model. Buyers can then compare how each proposal interprets the scope instead of comparing headline totals built on different assumptions.
The article on mobile app development cost in Saudi Arabia explains how scope, architecture, integrations, quality requirements and delivery responsibilities affect the commercial range.
When a high-impact dependency remains unresolved, the organization should use a range, a paid technical validation stage or a conditional work package. Forcing an unsupported fixed price usually moves uncertainty into exclusions, change requests or delivery compromise.
Preserve Discovery Decisions in the Contract
Conditions recorded during discovery must appear in the RFP, proposal evaluation, statement of work or contract. They should not disappear when documents are rewritten by procurement or sales teams.
The contractual package should identify the approved scope version, acceptance conditions, client and vendor responsibilities, intellectual-property ownership, account control, third-party costs and the treatment of changes.
The organization should also retain reusable access to the discovery outputs. Editable source files, research evidence, architecture records and decision logs should not remain available only through a vendor-controlled workspace.
After proposals are received, buyers can use the Saudi mobile app vendor evaluation scorecard to compare evidence, delivery controls, commercial terms and Saudi-market readiness on a consistent basis.
Run a Handoff Review
The receiving delivery team should review the evidence before accepting the plan. This is an opportunity to challenge assumptions, confirm dependencies and identify any difference between the discovery recommendation and the proposed implementation.
If a new finding materially changes value, feasibility, cost or the release boundary, the project should return to the relevant decision gate. Handoff is not permission to ignore new evidence.
Need help converting product uncertainty into a decision-ready release? Discuss Your Project with Digixvalley.
Handoff principle: Discovery creates value only when its evidence, conditions and responsibilities survive into procurement and delivery.
Common Mobile App Discovery Failures and How to Prevent Them
Discovery often underperforms because the process is treated as documentation or design approval rather than evidence-led decision-making. The most serious failures allow unsupported assumptions to pass into procurement and development.
Failure pattern | Why it weakens the project | Prevention |
|---|---|---|
The solution is approved before discovery starts | Research becomes an exercise in defending an existing idea | Give the team authority to revise, reduce or reject the proposed solution |
Workshops have no decision mandate | Discussion produces notes without resolving investment uncertainty | Define the decisions, evidence gaps and decision authority before scheduling activities |
Stakeholder opinions replace user evidence | Internal confidence may not represent actual behaviour or user needs | Test high-impact user assumptions with appropriate research or behavioural evidence |
“Saudi-ready” is treated as a generic label | Language, data, sector and operating requirements remain undefined | Run the Saudi Applicability Gate and assign every applicable condition to an owner |
A polished prototype is treated as validation | Visual approval does not prove usefulness, usability or feasibility | Connect each prototype to a specific assumption, test method and recorded result |
Integration claims rely on documentation or sales assurances | Access restrictions and technical limitations appear during development | Verify critical transactions through accessible documentation, test environments or technical spikes |
The backlog grows without an explicit release boundary | Estimates become unstable and priority features compete with optional ideas | Classify capabilities as included, conditional, deferred or excluded |
Estimates are forced before critical uncertainty is reduced | Vendors protect themselves through contingencies, exclusions or later change requests | Use estimate ranges, validation stages or conditional work packages |
Unresolved risks disappear during handoff | Procurement or delivery proceeds as though discovery produced an unconditional Go | Carry every condition into the RFP, contract, roadmap and acceptance criteria |
Recognize Discovery Theatre
Discovery has become theatre when its outcome would remain unchanged regardless of the evidence collected. Common warning signs include workshops designed only to confirm executive preferences, prototypes created without a validation question and reports that describe activities without showing their effect on scope.
A healthy discovery process allows evidence to change the original concept. It may remove features, alter the operating model, expose an infeasible dependency or recommend that investment should stop.
If the team detects discovery theatre, it should pause the activity schedule and restate the decision mandate. Existing claims should be reclassified as supported, contradicted, inconclusive or untested before further work continues.
Prevention principle: The purpose of discovery is not to create confidence in the original idea. It is to establish how much confidence the available evidence justifies.
Conclusion and Final Mobile App Discovery Action Plan
Mobile app product discovery should create a defensible investment decision. Its value comes from reducing the uncertainties capable of changing product value, release scope, architecture, cost, timeline or operating responsibility.
A useful discovery process may confirm the proposed product, narrow its first release, change its delivery approach or show that development should not begin. Each of these can be a successful outcome when supported by evidence.
Use the following action plan:
- Define the decision mandate. State what investment decision discovery must support and who can authorize it.
- Establish the evidence baseline. Separate confirmed information from assumptions and unknowns.
- Run the Saudi Applicability Gate. Identify which language, data, sector, integration and operating conditions apply.
- Prioritize decision-critical assumptions. Investigate the uncertainties with the highest consequence, weakest evidence and greatest cost if discovered late.
- Agree on evidence thresholds. Define how each important assumption will be tested and what result will support a decision.
- Accept decision-ready deliverables. Confirm that scope, journeys, feasibility, responsibilities and estimates are traceable to evidence.
- Record the final gate outcome. Select Go, Conditional Go, Extend, Pause or No-Go for a named scope version.
- Preserve the decision through handoff. Carry unresolved conditions, acceptance criteria and ownership into procurement, contracting and delivery.
If the critical gates pass, the organization can proceed with greater confidence and a more comparable delivery baseline. If they do not, the evidence should determine whether to extend validation, revise the release, pause the project or stop the current direction.
Need Help Reviewing Your Vendor Shortlist?
Frequently Asked Questions About Mobile App Product Discovery in Saudi Arabia
How Long Does Mobile App Product Discovery Take?
There is no universal duration. A focused application with accessible stakeholders and limited technical dependencies may be investigated within two to six weeks. Integration-heavy, approval-dependent or multi-user products may require a longer or staged engagement.
The schedule should be tied to defined evidence activities and decision gates. Discovery should not end only because the planned calendar period has expired.
How Much Does Mobile App Discovery Cost in Saudi Arabia?
Cost depends on the number and complexity of uncertainties being investigated. User research, bilingual prototype testing, technical spikes, integration analysis and specialist reviews require different skills and levels of effort.
Compare discovery proposals by their decision mandate, workstreams, deliverables, evidence standards and acceptance conditions. A low headline price provides little value if critical assumptions remain untested.
Is Product Discovery Required Before Every MVP?
Not every MVP needs a separate discovery engagement. An abbreviated readiness review may be sufficient when users and journeys are already validated, integration access is confirmed and the release boundary is clear.
Formal discovery becomes more important when unresolved assumptions could materially change product value, architecture, cost, delivery time or operational responsibility.
Should Arabic and English Journeys Be Validated Separately?
Both language experiences should be investigated when they serve priority users. Translating an approved English interface does not automatically validate Arabic navigation, right-to-left behaviour, content clarity, form entry or support expectations.
The team does not need to duplicate every activity. It should test the journeys where language or interface direction could change user comprehension, task completion or acceptance.
Can the Same Vendor Run Discovery and Development?
Yes, provided discovery does not automatically award the development contract. The client should retain decision authority, accept the outputs against agreed criteria and be able to reuse them with another qualified delivery team.
When multiple vendors will compete, each should receive the same approved scope, assumptions, conditions and technical baseline.
