A mobile app can have a polished interface and stable code but still fail at launch because a critical external system is not ready. The payment service may lack usable test accounts. The ERP may expose incomplete data. Identity verification may behave differently in production. The project may have no clear owner for failures between connected platforms.
Saudi mobile products often depend on payment gateways, Nafath or other identity services, enterprise resource planning systems, customer relationship management platforms, logistics providers, messaging services and internal business applications. Each connection introduces technical, operational and commercial dependencies that must be understood before the release plan is approved.
Integration readiness is more than confirming that an API exists. The project team must verify who owns the system, what data will move, how access will be granted, which environments are available, how failures will be controlled and who will restore the complete business journey.
This guide explains how to build an integration inventory, classify critical dependencies, validate access and contracts, test failure behaviour, plan reconciliation and make an evidence-supported release decision.
A Saudi mobile app integration is ready only when the named capability has an accountable owner, usable access, a testable contract, defined failure behaviour, reconciliation, operating support and current evidence tied to the release build and environment. A high score cannot override a failed mandatory gate.

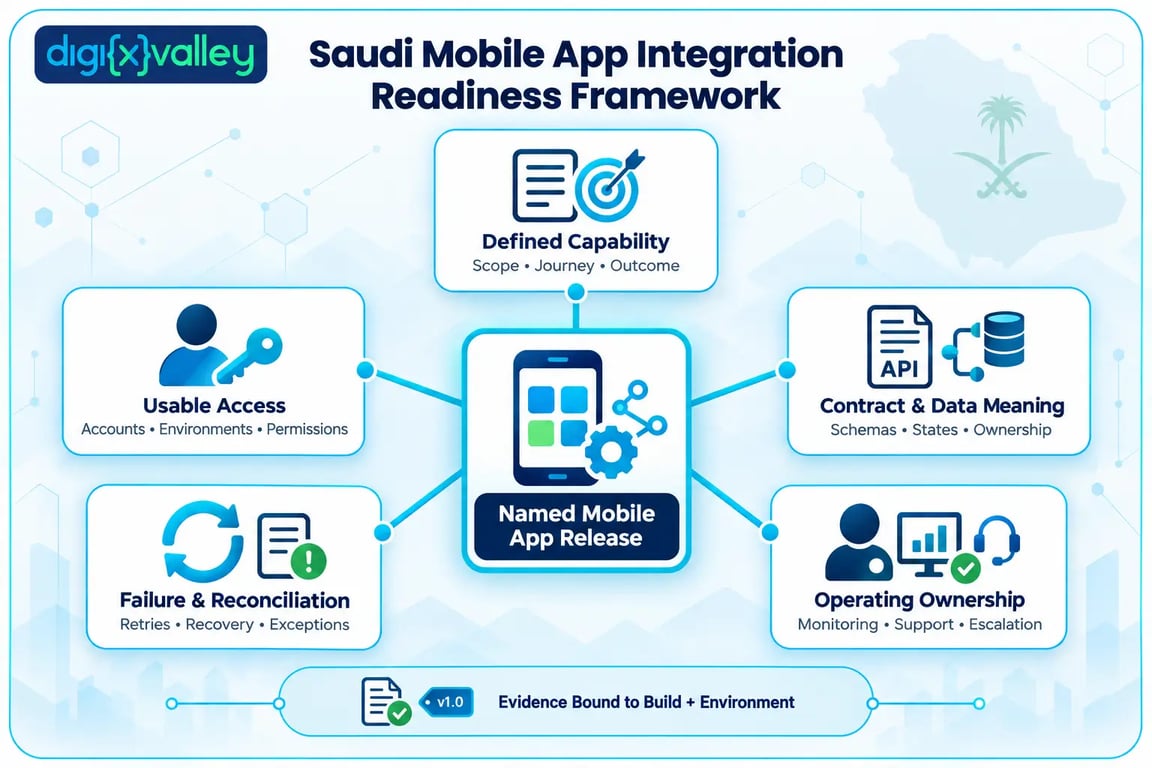

What Mobile App Integration Readiness Must Prove
Mobile app integration readiness is the verified ability of an internal or external system to support a defined application capability under realistic operating conditions.
An integration should not be classified as ready because documentation exists, a supplier confirms availability or one successful response appears in a demonstration. Readiness requires evidence that the complete interaction can work across the intended mobile build, backend version, environment, data set and business process.
The evidence must establish five connected conditions:
- The team has defined the exact capability and business outcome.
- The technical route, access and required environments are usable.
- The systems agree on identifiers, data meaning and authoritative state.
- Expected failures have safe user, system and recovery responses.
- One accountable owner can monitor, escalate and verify restoration.
“Connect the app to the ERP” is not a testable requirement. A usable definition identifies the process, data object, action, user and expected result. For example, the app may need to retrieve inventory, reserve an item, create an order, receive the authoritative order reference and display the result in Arabic and English.
The same principle applies to payments and identity. “Support payments” is too broad. Authorization, callbacks, refunds and settlement evidence are different capabilities. “Integrate identity” may include initial verification, repeated verification, recovery and the internal permission change that follows a confirmed result.
Available Is Not the Same as Ready
Integration state | What it establishes | Decision implication |
|---|---|---|
Documented | API or integration documentation exists | Continue investigation |
Accessible | The project has usable credentials and connectivity | Begin controlled validation |
Testable | A representative environment and data set are available | Execute functional and failure tests |
Operationally defined | Monitoring, support and incident ownership are assigned | Prepare for release approval |
Evidence-verified | Required scenarios passed against the named build and environment | Apply the readiness gate |
A sandbox connection may prove that authentication works. It does not automatically prove production readiness. The sandbox may simplify data, omit real limits, simulate callbacks or use different approval rules.
Every readiness claim should name the capability, provider, interface version, app build, backend version, environment, scenarios tested and unresolved conditions. Payment integration tested cannot support a release decision because it does not define what was tested or what remains uncertain.
Bind Readiness to a Named Release
Readiness is not a permanent property of a provider. It applies to a specific capability and system state.
An ERP may be ready for retrieving customer records but not for creating orders. An identity service may support registration but not recovery. A gateway may process successful payments while refund events or reconciliation reports remain unverified.
Approve capabilities separately so that a partially tested connection is not treated as fully ready. Every decision should answer four questions:
- What exact capability has been verified?
- Which build, version and environment were assessed?
- What evidence supports the conclusion?
- Who owns every unresolved condition?
If any answer is missing, classify the capability as conditional, incomplete or blocked according to its effect on the release.
Map Dependencies, Criticality and Owners
Create one controlled inventory of every system, service and approval the first release depends on. Without it, important facts remain scattered across proposals, diagrams, emails and individual team members.
Start with first-release user journeys rather than a general technology list. For each journey, trace what must happen after the user acts. A checkout journey may depend on authentication, pricing, inventory, payment authorization, order creation, confirmation and reconciliation.
This approach exposes hidden dependencies. A payment connection may require merchant approval, production credentials, webhook registration, network allowlisting and finance access to settlement records. An ERP connection may be available while the required module, transaction type or service account remains unavailable.
Record Capabilities, Not Only System Names
A system name does not show which part of the system the app needs. When one platform supports several important actions, record those capabilities separately so they can receive different readiness decisions.
Use a single dependency register as the controlling record:
Field | What to record |
|---|---|
Integration capability | The exact action the connected system must perform |
Dependent journey | The mobile feature or business process relying on it |
Criticality | Gate-critical, release-critical, important or deferrable |
Business owner | The person approving rules and expected outcomes |
Technical owner | The person controlling access, contract and technical decisions |
Provider or operator | The internal team or supplier operating the system |
System of record | The platform holding the authoritative state |
Data exchanged | Information entering, leaving or changing |
Interface and version | API, event, file route, SDK or protocol used |
Environments and access | Required accounts, credentials, certificates and network rules |
Failure effect | The user and business consequence if the capability fails |
Recovery route | Retry, queue, status check, reconciliation or manual review |
Evidence status | Verified, partial, unverified, contradicted or expired |
Open condition | Missing evidence, owner, deadline and expiry consequence |

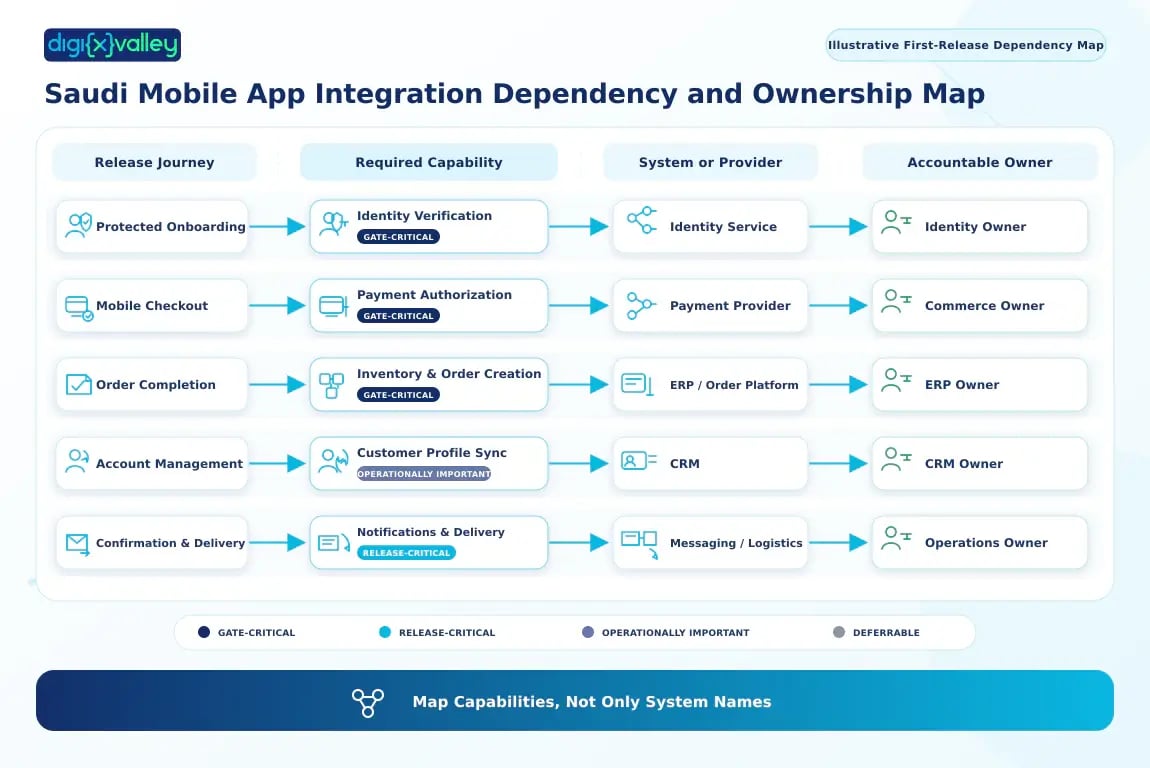

Example Dependency Register
Capability | Dependent feature | Criticality | Accountable owner | Key prerequisite | Failure effect | Status |
|---|---|---|---|---|---|---|
Customer identity verification | Protected onboarding | Gate-critical | Identity owner | Provider approval, access and representative test cases | User cannot complete onboarding | Conditional |
Payment authorization and callback | Mobile checkout | Gate-critical | Commerce or finance owner | Merchant account, credentials and callback route | Payment outcome may remain unknown | Testing |
Inventory availability | Product selection | Release-critical | ERP owner | Documented endpoint and acceptable response time | User may act on stale stock | Unverified |
Order creation | Checkout completion | Gate-critical | Order owner | Confirmed schema, references and duplicate protection | Payment may succeed without an order | Blocked |
Customer-profile update | Account management | Operationally important | CRM owner | Field mapping and source-of-truth decision | Customer records may conflict | Conditional |
OTP delivery | Sign-in or confirmation | Release-critical | Identity or communications owner | Sender approval, route and retry policy | User cannot complete the action | Testing |
These labels require evidence. A conditional item must name the missing evidence, owner and deadline. A blocked item must explain why the project cannot proceed safely.
Classify the Effect of Failure
Not every integration deserves the same testing effort or executive attention. Classify each capability against the named release, not against the perceived importance of the provider.
Criticality | Meaning | Required treatment |
|---|---|---|
Gate-critical | The release cannot be approved without the capability or an approved alternative | Verify access, success, failure, reconciliation and operating ownership |
Release-critical | A core journey depends on it, but a controlled temporary fallback may exist | Verify the primary route, fallback, recovery and time limit |
Operationally important | Failure affects efficiency, reporting or service quality without stopping the main journey | Monitor, assign an owner and define remediation |
Deferrable | The capability can be removed without damaging the intended first release | Exclude it and reassess later |
Assess the complete dependency chain. If payment succeeds but order creation fails, the customer may be charged without receiving an order. That makes payment confirmation, order creation and their reconciliation one gate-critical chain even though each uses a different system.
For every critical capability, record the failure condition, user-visible state, business effect, fallback, maximum tolerable interruption and recovery method. “The team will handle it manually” is not a control unless volume, access, response time and correction authority are known.
Assign Decision and Operating Ownership
Role | Primary responsibility |
|---|---|
Business owner | Defines the required outcome and acceptable disruption |
Technical owner | Controls the interface, architecture and internal system decision |
Implementation owner | Builds, configures and documents the assigned components |
Provider owner | Manages the external account and escalation route |
Verification owner | Confirms that required scenarios and controls passed |
Operational owner | Monitors the live connection and coordinates response |
Risk-acceptance owner | Approves any bounded limitation before release |
One person may hold several roles, but each responsibility still needs to be recorded. Assigning everything to the project team makes escalation and handover unreliable.
Production accounts should normally remain under the organization that will operate the product. A development partner can receive controlled access without becoming the permanent owner of billing, credentials, recovery or provider support.
Validate Access, Sandboxes and Test Data
An integration cannot be tested or released until the project has usable access to every required environment. Documentation may show that an interface is suitable, but work remains blocked when credentials, certificates, accounts or network permissions are missing.
Access readiness should cover the complete route from the mobile application to backend services, identity providers, external APIs, administrative portals and network controls.
Separate User Authentication from System Access
User authentication confirms who is using the app. System access determines whether the app or backend can perform an action in another platform. A user may sign in successfully while the backend lacks permission to retrieve an account, create an order or submit a payment.
For each integration, record the authentication method, credential recipient, required permissions, approval and revocation process, environment differences and account-recovery owner. Keep long-lived secrets and privileged provider credentials out of the distributed mobile app. Use a controlled backend when confidential credentials or protected business actions require it.
User-facing authorization should follow the provider’s supported native-app flow. Validate redirect handling, proof-key requirements, token audience, expiry, refresh behaviour, logout and recovery against the current provider configuration.
Confirm Environment and Account Control
Access area | Development or sandbox | Staging | Production |
|---|---|---|---|
Account owner | Named owner | Named owner | Organization-controlled owner |
Credentials | Test credentials | Environment-specific credentials | Controlled production credentials |
Data | Synthetic or approved test data | Representative controlled data | Approved live data |
Callback route | Development endpoint | Stable pre-production endpoint | Approved production endpoint |
Network rules | Test connection | Production-like restrictions | Approved firewall, VPN or allowlist |
Administrative access | Limited project access | Restricted validation access | Role-based operational access |
Evidence | Successful connection | End-to-end scenario results | Approval and deployment record |
The register should include merchant or supplier onboarding, certificates, redirect addresses, IP allowlisting, VPN connectivity, domain verification, sender registration and production-access approval. Each prerequisite needs an owner and target date.
Strategic accounts must remain recoverable by the operating organization. Confirm who controls the primary administrator, billing relationship, recovery email, multi-factor authentication method, credential storage, rotation, revocation and emergency access.
Authentication tests should include expired tokens, revoked credentials, invalid certificates, missing permissions and locked accounts. The user should receive an appropriate state while operational records retain enough context for investigation.
Teams planning the wider product can use Digixvalley’s mobile app development services in Saudi Arabia to place integration validation within discovery, architecture, development, testing and long-term operation.
Assess Sandbox Parity
A sandbox is useful only when the team knows what it can and cannot prove.
Validation area | Evidence required |
|---|---|
API version | Compatible versions across test and production |
Authentication | Representative credentials, token behaviour and scopes |
Business rules | Relevant validation, approval and transaction states |
Data model | Required fields, identifiers and formats |
Limits | Known rate, payload, transaction and timeout limits |
Events | Observable callbacks or webhooks |
Error behaviour | Reproducible declines, validation errors and unavailable states |
Operational records | References, logs and reports needed for investigation |
Production differences | Named owner and validation plan for every material gap |
The environments do not need to be identical. Differences that affect architecture, user experience, security, financial outcomes or the release decision must remain visible.
Use Representative, Controlled Test Data
Synthetic data is preferable when it can reproduce the required structure and edge cases. A Saudi mobile app may need Arabic and English names, Saudi phone-number formats, SAR transactions, different address structures, expired credentials, delayed callbacks, inactive records and provider-specific identifiers.
Each test record should have an identifier, purpose, owner and reset procedure. This makes results repeatable after a contract or configuration change.
Do not treat a successful endpoint request as an end-to-end test. A checkout scenario should follow the transaction through payment, order creation, customer confirmation and operational reporting. An identity scenario should follow the provider result into the internal account state and permission decision.
When a provider cannot reproduce a required condition, use a controlled mock, simulator, staging configuration or governed production test. Record the limitation clearly. A mock proves how the app handles the simulation. It does not prove that the provider behaves the same way.
Keep a capability conditional when a known environment difference requires later confirmation. Pause it when missing access, unusable data or undocumented behaviour prevents reliable validation.
Confirm API Contracts and Data Meaning
An API contract is the controlled agreement between the system providing a capability and the system consuming it. It defines request and response structure, authentication, business meaning, error behaviour, limits and change rules.
Integration defects often appear when two teams agree on technical format but interpret the data differently. Both systems may accept a status field while assigning different meanings to pending, completed or cancelled.
Define the Integration Route
Identify where each interaction executes. A mobile app may call a controlled backend, which then communicates with payment, identity, ERP or CRM services. Some providers may use supported mobile components or redirect flows.
This boundary determines where credentials, validation, retries, recovery and monitoring belong. Keep it consistent with the approved backend architecture for Saudi mobile apps.
Establish the Minimum Contract
Contract area | Required definition |
|---|---|
Operation | The business capability performed |
Provider and consumer | The systems on each side of the boundary |
Endpoint or event | Request method, event route or file exchange |
Authentication | Identity, credentials, permissions and signing rules |
Schemas | Required fields, optional fields, formats and validation |
State model | Permitted states, transitions and authoritative system |
Error contract | Error meaning and required consumer action |
Duplicate control | Stable operation identifier and repeated-request behaviour |
Timing and limits | Response time, expiry, rate, concurrency and payload restrictions |
Version and change | Supported versions, notice period, regression test and rollback |
Ownership | Approver, implementer and maintenance owner |
A copied example response is not a contract. Examples show one payload. Schemas and business rules define permitted behaviour.
Map Fields and Authoritative State
Prepare the field mapping before developers create transformations inside application code.
Source field | Target field | Transformation | Validation | Source of truth | Failure action |
|---|---|---|---|---|---|
customer_id | external_customer_ref | Preserve assigned identifier | Required and unique | CRM | Reject and record |
mobile_number | contact_phone | Normalize to the agreed format | Supported format | Customer profile | Request correction |
order_total | amount | Convert to the agreed monetary unit | Positive value and currency match | Order service | Block payment request |
payment_status | order_payment_state | Map provider state to internal state | Accepted state list | Payment service | Hold for reconciliation |
updated_at | source_modified_at | Convert to the agreed timestamp format | Valid time and timezone | Source system | Reject stale update |
Define whether each value is copied, transformed, calculated or enriched. Record what happens when the source value is missing, invalid, duplicated or unknown.
Missing, null, empty and zero are not automatically equivalent. Converting an unknown amount to zero or an unknown state to completed can be more damaging than rejecting the request.
Status models should define valid transitions, the system that triggers them, whether a state is temporary or final, and how delayed or out-of-order updates are handled. Preserve both internal and external references when authority changes during a transaction.
Make Errors, Events and Changes Actionable
A useful error tells the consumer whether to correct data, ask the user for information, restore authorization, retry later, wait for an event, open a review case or stop the transaction.
Manage user messages separately from technical diagnostics. The app may need a clear Arabic or English explanation while operational records retain the reference and context required for investigation. Both languages must communicate the same business meaning.
Define webhook identifiers, signatures, payload schemas, retry behaviour, expected ordering and duplicate treatment. Do not assume that an event arrives once, on time or in sequence.
Record which API version each environment supports. When a provider removes a field, changes its type, adds a new state or modifies authentication, identify which contract tests and readiness evidence must be renewed.
Turn readiness findings into an implementation plan
Reconcile Payment, Identity, ERP and CRM State

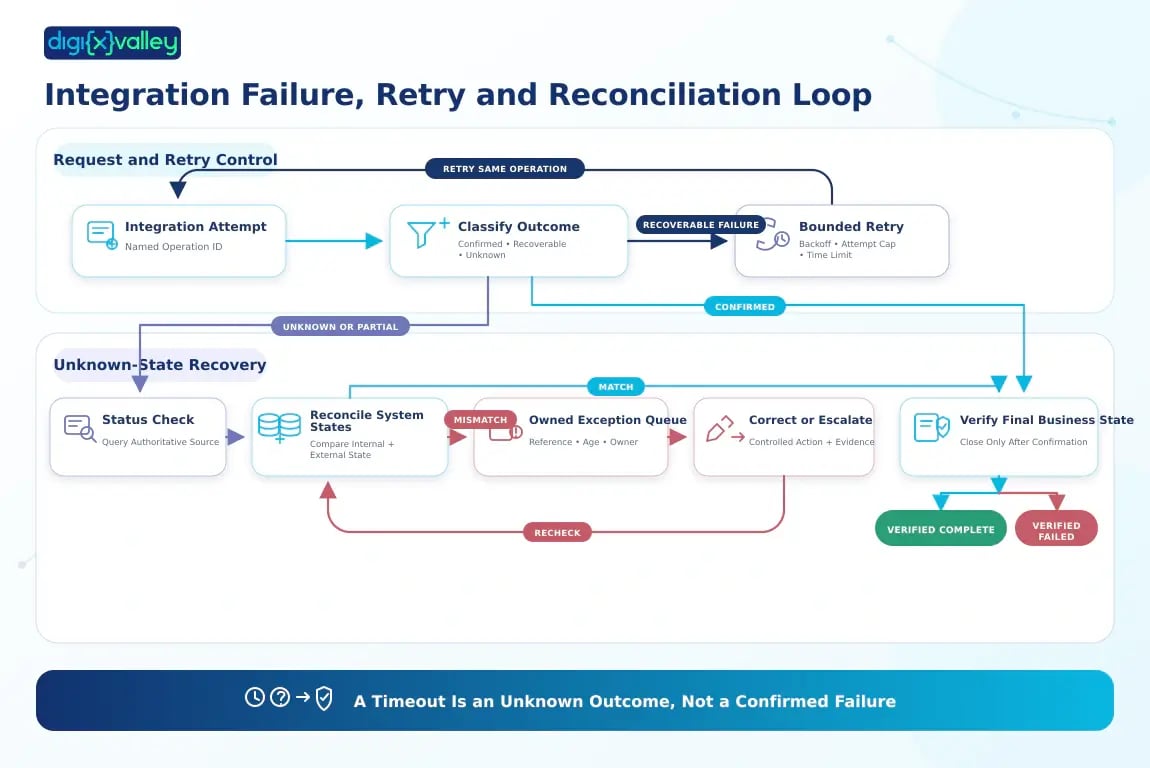

Retries attempt to complete a technical request. Reconciliation determines whether connected systems ultimately agree about the business outcome.
A payment may be authorized without an order. An identity result may be returned without the customer account changing. An ERP may accept an order while the app continues to show it as pending. These differences can remain hidden until a customer, finance team or support agent reports them.
Create One Reconciliation Record
Record element | Purpose |
|---|---|
Internal operation ID | Identifies the complete business action |
External reference | Locates the provider transaction |
Customer or account reference | Connects the action to the correct user |
Intended action | Describes the expected business outcome |
Requested value | Records the amount, state or data submitted |
Internal state | Shows what the application currently believes |
External state | Shows the provider or enterprise result |
Last confirmed event | Identifies the latest trusted update |
Timestamps | Establish request, response and review times |
Attempt history | Records retries and recovery actions |
Exception status | Shows whether investigation is required |
Resolution | Documents the final correction and approval |
Critical integrations normally use more than one trigger. A callback can update the normal path. An immediate status check can resolve a timeout. A scheduled comparison can find missing events.
Reconcile Each Business Outcome
For payments, compare the provider result, order state, amount, currency and internal and external references. Payment confirmed with no order is different from an order created after a decline. Both need a defined response. Do not invite another payment while the first outcome remains unknown.
For identity, confirm that the external result belongs to the correct account and produced the expected internal permission or journey state. A completed redirect does not prove successful verification. Use the provider’s confirmed result. When Nafath forms part of the approved route, validate its specific implementation through the Nafath integration guide for Saudi mobile apps.
For ERP records, relate the app operation to the authoritative order, inventory, fulfilment or invoice state. Availability, reservation and confirmed allocation are different capabilities. A successful lookup does not guarantee that stock remains available when the order is submitted.
For CRM records, define the authoritative system, update direction, matching rule, duplicate treatment and conflict rule for every shared attribute. Prefer stable internal and external identifiers. Email addresses and phone numbers may change or be shared.
Operate an Owned Exception Queue
Business event | Authoritative system | Exception condition | Resolution owner |
|---|---|---|---|
Payment authorization | Payment provider | Provider confirms payment but order is absent | Payments operations |
Identity result | Approved identity service | Provider result and account state disagree | Identity operations |
Order acceptance | ERP or order platform | App shows confirmed without ERP acceptance | Order operations |
Customer-profile update | Assigned profile system | Authoritative values conflict | Customer-data owner |
Refund completion | Approved financial record | Refund exceeds the pending threshold | Finance operations |
Each exception needs references, expected and observed states, age, criticality, owner, investigation evidence, permitted correction, escalation deadline and resolution.
Correction tools should preserve the earlier value, responsible operator, reason, time and resulting state. Operators should not make unrestricted database changes because a customer journey is blocked.
Reconciliation is ready when every critical outcome has an authoritative source, related references, comparison method, acceptable inconsistency period, controlled exception queue, named owner and evidence from mismatch-and-recovery testing.
Set Minimum Operating and Supplier Controls
An integration is not operationally ready unless the team can detect when it stops producing the expected business result and reach the party able to restore it.
Keep the readiness gate focused on the minimum evidence. The detailed observability model can be designed separately.
Monitor the Complete Integration Outcome
For every gate-critical capability, identify:
- The technical signal that detects availability, latency, errors or throttling.
- The queue or event signal that exposes delayed work.
- The reconciliation signal that exposes conflicting system states.
- The business signal that shows whether the dependent journey completed.
- The alert owner, escalation route and first safe action.
- the evidence that confirms recovery.
A low API error rate may appear healthy while checkout completion falls because responses are too slow. A provider may report availability while callbacks stop arriving. Technical and business signals must be reviewed together.
Use a correlation identifier to connect the mobile action, backend request, integration component and provider interaction without recording unnecessary sensitive information. Support should be able to determine whether the request reached the backend, whether the provider responded, whether an event arrived and which team owns the exception.
Alerts should identify the capability, environment, start time, condition, reference, owner and escalation route. Avoid alerting on every isolated error. Alert on conditions a person can investigate or mitigate.
Confirm Supplier Commitments and Boundaries
A published SLA does not prove that the required capability is covered. Confirm the included service and environment, maintenance exclusions, support hours, response target, restoration position, status-notification route, change notice, incident evidence and exit support.
A service credit is a contractual remedy. It does not restore a failed customer journey. The product still needs detection, fallback, reconciliation and communication controls.
For each failure area, name the first responsible party:
Failure area | Initial owner to confirm |
|---|---|
Mobile request or display state | Mobile implementation owner |
Backend orchestration or queue | Backend or integration owner |
Credential or account access | Account owner |
Enterprise data or business rule | ERP, CRM or business-data owner |
Provider availability or contract | Provider liaison |
Cross-system inconsistency | Reconciliation owner |
Recovery approval | Business and verification owners |
Test the support route before launch. A controlled request can confirm that the production account is recognized and that the correct contacts receive the case.
Provider change also requires ownership. Record how the team receives notices, assesses impact, repeats contract and journey tests, orders deployments, supports older mobile versions and renews evidence. The notice period must allow time for mobile review and user adoption.
Assemble the Integration Readiness Workbook
The evidence package should become one controlled workbook rather than a collection of disconnected tables. It should enable a reviewer to understand the named release without relying on verbal assurance.
The workbook has four connected components:
- Dependency register: capabilities, journeys, criticality, systems, owners, environments and conditions.
- Access and contract register: accounts, permissions, versions, schemas, mappings and production prerequisites.
- Failure and reconciliation matrix: timeouts, retries, duplicate control, degraded states, authoritative outcomes and exception ownership.
- Evidence, scorecard and decision record: artifacts, verification status, mandatory gates, weighted score and final approval.
Bind Evidence to Scope and Provenance
The workbook should identify the product, release scope, mobile build, backend version, environments, providers, interface versions, architecture baseline, assessment date, owners, reviewers and exclusions.
For every evidence item, record:
Evidence field | Purpose |
|---|---|
Evidence ID | Creates a stable reference |
Readiness claim | States what the evidence is expected to prove |
Artifact | Identifies the test result, contract, trace, report or approval |
Capability | Connects evidence to the dependency register |
Build and environment | Prevents evidence from being applied too broadly |
Provider or system version | Shows which configuration was assessed |
Result | Records the observed outcome |
Status | Verified, partial, unverified, contradicted, expired or not applicable |
Owner and reviewer | Shows who supplied and independently assessed it |
Review date | Supports expiry and reassessment |
An API guide can explain expected behaviour, but it does not prove usable access or a passed journey. A screenshot may support a result, but it should not stand alone without the scenario, environment, version and observed outcome.
Use consistent evidence classifications:
Status | Meaning |
|---|---|
Verified | Current evidence directly demonstrates the claim |
Partially verified | Some conditions are demonstrated, but a defined gap remains |
Unverified | Adequate evidence has not been supplied |
Contradicted | Available evidence shows that the claim is not currently true |
Expired | Evidence applies to an older build, environment or configuration |
Not applicable | The item does not apply and the reason is recorded |
Preserve failed and contradictory results. Attach remediation and independent retest evidence rather than deleting the earlier finding.
Convert every open gap into one of four treatments: resolve before continuing, resolve before production approval, accept as a bounded temporary condition, or remove from the named release. A condition must identify the evidence required, owner, deadline, affected capability and expiry consequence.

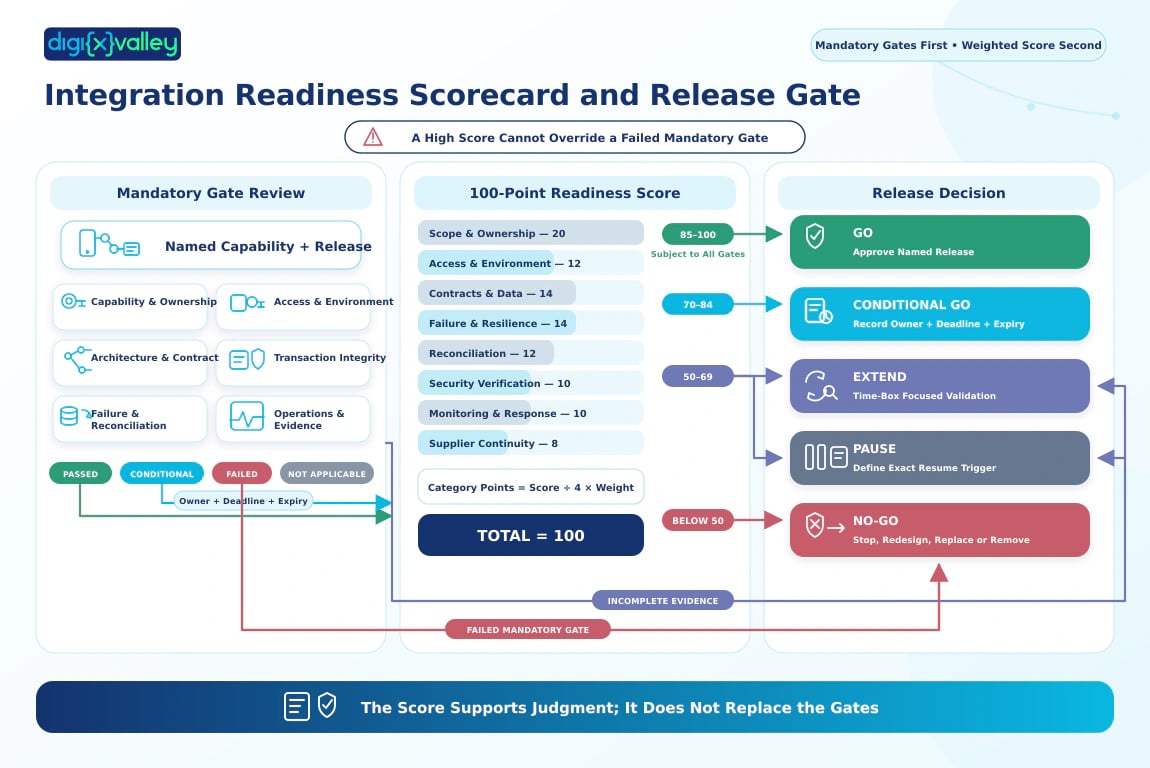

Apply Mandatory Gates and the 100-Point Scorecard
Use mandatory gates before applying the weighted score. Strong performance in one category cannot compensate for an unknown payment outcome, missing production-access route or absent owner for a gate-critical capability.
Mandatory Integration Gates
Gate | Pass condition |
|---|---|
Defined capability | The exact release feature and business outcome are documented |
Accountable ownership | Business, technical, verification and operational owners are assigned |
Access route | Test access exists and the production-access process is confirmed |
Architecture and data flow | Connection path, exchanged data and system of record are approved |
Contract and state meaning | Schemas, identifiers, states, errors and versions are agreed |
Transaction integrity | Duplicate, partial and unknown outcomes can be controlled |
Failure response | User, system and recovery behaviour are approved |
Reconciliation | Critical differences can be identified and resolved |
Operating support | Failure can be detected and the responsible party reached |
Evidence traceability | Current evidence is tied to the named build and environment |
Record each gate as Passed, Conditional, Failed or Not Applicable. A conditional gate requires a bounded gap, named owner, deadline and expiry consequence. A failed mandatory gate pauses approval for the affected capability.
Score the Evidence
Score | Evidence standard |
|---|---|
0 | No evidence exists, or evidence contradicts the readiness claim |
1 | Readiness is claimed or documented but not demonstrated |
2 | Partial evidence exists, but material scenarios remain unverified |
3 | The outcome is verified with bounded non-critical conditions |
4 | Current evidence verifies the outcome for the named scope and environment |
Evaluation category | Weight | What to assess |
|---|---|---|
Scope and criticality | 10 | Capabilities, journeys, exclusions and failure effect |
Ownership and account control | 10 | Business, technical, provider and operational ownership |
Access and environment readiness | 12 | Accounts, credentials, permissions and production route |
API contracts and data mapping | 14 | Schemas, mappings, states, errors, identifiers and versions |
Failure handling and resilience | 14 | Timeouts, retries, idempotency, degraded states and recovery |
Reconciliation and transaction integrity | 12 | Matching, investigation and correction of cross-system outcomes |
Security verification | 10 | Authentication, authorization, data exposure and assigned testing |
Monitoring and response | 10 | Signals, alerts, escalation and recovery evidence |
Supplier and change continuity | 8 | Support scope, change notice and exit conditions |
Total | 100 |
Calculate each category as:
Weighted category points = Category score ÷ 4 × Category weight
A score of three for API contracts and data mapping produces 3 ÷ 4 × 14 = 10.5 points.
Total score | Interpretation | Typical outcome |
|---|---|---|
85–100 | Strong evidence across required controls | Eligible for GO, subject to all gates |
70–84 | Broad readiness with controlled gaps | CONDITIONAL GO |
50–69 | Material uncertainty or incomplete evidence | EXTEND or PAUSE |
Below 50 | The integration cannot support the release reliably | NO-GO, redesign or removal |
Score gate-critical capabilities separately. A strong CRM connection must not hide an unready payment or identity dependency. At release level, the weakest unresolved gate-critical capability determines readiness.
The numerical result supports judgment. It does not replace the gates. A score of 90 cannot produce approval when a mandatory gate has failed.
Record the Release Decision
Decision | When it applies | Required action |
|---|---|---|
GO | All mandatory gates pass and the score meets the threshold | Approve the capability for the named release |
CONDITIONAL GO | Remaining gaps are bounded, owned and compatible with safe progress | Record the owner, evidence, deadline and expiry consequence |
EXTEND | Focused validation can resolve material uncertainty within a defined period | Approve a time-boxed validation plan and success threshold |
PAUSE | Validation depends on an unavailable approval, environment or external decision | Define the exact evidence required to resume |
NO-GO | A mandatory gate fails or the route cannot support the required outcome | Stop, redesign, replace or remove the capability |
A release decision applies only to the reviewed scope, versions, environments and evidence. It is not a permanent approval of the provider or architecture.
A conditional decision should identify the affected capability, current evidence, remaining risk, owner, deadline, decision stage, closure verifier and expiry consequence. Conditions affecting transaction integrity, required identity controls, production access or critical recovery normally need to close before release.
An extension should name the unresolved assumption, validation method, environment, owner, time limit, success threshold and the decision that follows each possible result. Repeated extensions without new evidence show that the dependency is not controlled.
A pause needs an exact resume trigger. “Waiting for the provider” is not enough. Record the missing credential, approval, contract or environment and the evidence that allows work to restart.
A no-go decision does not always cancel the app. The team may remove the capability, choose another provider, change the business process, introduce a controlled integration layer or reframe the release.
Worked Decision Example
Consider a hypothetical Saudi retail app preparing its first production release. Customer sign-in, catalogue retrieval and CRM profile updates have current evidence. Payment authorization also passes the successful and declined scenarios. However, the payment callback can arrive after the mobile request times out, and the team has not yet proved that a repeated checkout attempt cannot create another charge.
The combined readiness score is 86 out of 100. That score does not justify GO because transaction integrity is a mandatory gate. The payment capability should remain at EXTEND while the team performs a focused duplicate-control test using one stable operation identifier and a simulated lost response.
If the retest confirms that the backend returns the original result and reconciliation detects any payment without an order, the transaction-integrity gate can pass. The capability may then move to GO if the remaining gates pass.
If production credentials are still awaiting merchant approval but the route, owner and due date are documented, development may receive CONDITIONAL GO while production release remains blocked by that condition. If the provider cannot support safe duplicate control and no approved internal control can contain the risk, the payment route becomes NO-GO even though the overall score is high.
This example shows why the decision record needs both gate results and weighted scores. The score compares the breadth of readiness. The gates protect outcomes that cannot be averaged away.
Common Integration-Readiness Failures
Most integration problems begin when an unverified assumption becomes part of the architecture, estimate or release plan.
Failure pattern | Early warning | Preventive control |
|---|---|---|
API existence treated as readiness | No project-specific access or scenario evidence | Keep the capability unverified until demonstrated |
Critical integration started late | A core journey depends on unresolved access | Validate gate-critical dependencies during discovery |
Hidden onboarding dependency | Account, certificate or approval owner is unknown | Add administrative prerequisites to the register |
Conflicting data meaning | Teams use different field or state definitions | Approve the contract and mapping matrix |
Multiple sources of truth | Systems overwrite the same attribute | Assign authority and synchronization direction |
Sandbox treated as production proof | Production differences are undocumented | Maintain an environment-parity record |
Happy-path-only testing | No timeout, rejection, duplicate or recovery evidence | Execute failure and reconciliation scenarios |
Unsafe retries | Requests repeat after an unknown outcome | Use stable identifiers, status checks and reconciliation |
Missing exception queue | Systems disagree without an owned case | Define comparison rules and resolution ownership |
Undefined support boundary | Incidents move between teams | Assign the initial investigator and recovery verifier |
Technical-only monitoring | APIs appear healthy while journeys fail | Measure business outcomes and conflicting state |
Expired evidence | Approval refers to an older build or version | Define reassessment triggers |
Schedule overrides the gate | Failed controls become “minor conditions” | Resolve, remove, redesign or change the release plan |
Keep uncertainty visible. A documented unknown can be investigated, priced and scheduled. A hidden assumption becomes a late delivery problem.
Control Logging, Monitoring and Support Access
Logs must preserve enough evidence to operate and secure the app without becoming uncontrolled copies of production data.
Create a logging inventory covering mobile clients, APIs, identity, databases, cloud configuration, deployment pipelines, integrations and support systems. Assign an owner, location, retention period, access group and monitoring purpose to every source.
Keep Sensitive Content Out of Logs
Do not log passwords, one-time codes, private keys, access tokens or full authentication headers. Limit personal, payment, identity, health and location data. Redact before events reach the logging platform.
Treat logs as their own data store. Confirm their location, subprocessors, support access, backup and deletion model.
Turn Events into Action
Important alerts need a condition, severity, receiving team, response procedure, escalation route and closure requirement. Monitor critical user journeys as well as infrastructure health.
Testing should confirm that controls detect the threats identified during Saudi mobile app security testing.
Control Support Access
Use named identities, strong authentication, least privilege and time-limited approval. Record the person, purpose, scope, duration, location and actions.
Overseas support access belongs in the data-flow and transfer review. Support tickets and diagnostic files can also create additional data copies.
Conclusion and Final Integration Action Plan
Mobile app integration readiness is not established by an API document, successful login or one demonstration. It is established when the project can prove that a named capability works, fails safely and can be operated under realistic conditions.
For Saudi mobile products, that often means coordinating payments, identity, ERP, CRM, logistics, messaging and internal platforms across several owners and environments. The technical connection is only one part of the responsibility.
Use this final sequence:
- Define the release, capabilities and exclusions.
- Map every direct and indirect dependency.
- Classify criticality and assign decision and operating owners.
- Confirm accounts, permissions, environments and production access.
- Approve interface contracts, data mappings and authoritative states.
- Test successful, failed, delayed, repeated and partially completed scenarios.
- Prove reconciliation and exception ownership for critical outcomes.
- Assemble current evidence in the Integration Readiness Workbook.
- Apply mandatory gates before calculating the weighted score.
- Record one decision tied to the named scope, build, environment and evidence.
When a mandatory gate fails, the valid response is to resolve it, remove the dependent capability, adopt an approved alternative or change the release plan. The calendar does not change the meaning of the evidence.
Review Your Integration Readiness Before Committing the Release
Frequently Asked Questions
Can Development Begin Before Production Credentials Are Available?
Development can begin with sandbox or staging credentials when the required capability is testable and the production-access route is understood. The production account still needs a named owner, approval process, lead time and credential-storage plan.
The capability remains conditional until production access and the required production-specific controls are verified.
Does Every Saudi Mobile App Need Nafath, Payments, ERP and CRM?
No. Select integrations according to the product’s approved user journeys and business model. A mobile app should not add payment, identity or enterprise dependencies merely because they are common in the market.
Every connection should support a defined outcome. Remove a deferrable capability when it adds risk without improving the coherent first release.
How Can a Team Test Without a Suitable Sandbox?
Controlled mocks or simulators can support application development, but they do not prove that the provider behaves the same way.
Remaining validation may require a provider test account, controlled staging arrangement or carefully governed production test. Record the limitation, owner, method and evidence required before approval.
Who Should Approve Integration Readiness?
Approval normally involves the business owner, technical owner, implementation lead, relevant security or risk reviewer and operational owner. Suppliers can provide evidence, but they should not be the only party approving the client’s release decision.
One authorized role should record the final scope, gate results, score, conditions, evidence package and review date.
Can a Manual Workaround Support a Conditional Launch?
A manual workaround may support a limited release when the volume is manageable, the process is safe and one team owns it. Define access, case intake, evidence, correction authority, response time and reconciliation.
“Handle it manually” is not a sufficient fallback. Keep the release blocked when the team cannot estimate, control or verify the work.
When Should Integration Readiness Be Reassessed?
Reassess after material changes to the mobile build, backend, provider configuration, API version, data flow or operating model. Reopen the decision after significant incidents, repeated control failures, authentication changes, provider migration or evidence expiry.
The review frequency should reflect criticality, change rate and failure consequences rather than follow one universal interval.
