MVP app development costs in 2026 commonly range from $20,000 to $150,000 or more for a custom digital product. A focused application with one core user journey may sit near the lower end. A marketplace, SaaS platform, fintech product, healthcare application, logistics system, or AI-powered solution may require a significantly larger investment.
The final budget depends on feature complexity, platform choice, backend requirements, design depth, third-party integrations, security, testing, and the development team selected for the project.
Broader market research explains why a single universal figure is unreliable. Clutch reports that many app development companies charge approximately $25–$49 per hour, while GoodFirms places complete app projects across a much wider $15,000–$500,000+ range, depending on complexity, platform compatibility, features, and scalability. The estimates in this guide should therefore be treated as planning benchmarks rather than fixed quotations.
The most useful question is not simply:
How much does an MVP app cost?
It is:
What is the smallest reliable product that can validate the business idea?
Building too much consumes runway before demand is proven. Building too little produces weak feedback because users cannot complete the central task. A strong MVP balances cost control with enough functionality, quality, and reliability to generate meaningful evidence.
MVP App Development Cost in 2026
The table below provides practical planning ranges. The final estimate should be prepared after discovery and technical review.
MVP Level | Typical Planning Range | Typical Timeline | Suitable For |
Lean Validation MVP | $20,000 – $40,000 | 6 – 10 weeks | Single user type, single core workflow, basic market validation |
Standard Startup MVP | $40,000 – $80,000 | 10 – 16 weeks | Custom UX, dedicated backend, admin controls, 3rd-party API integrations |
Advanced MVP | $80,000 – $150,000+ | 14 – 24 weeks | Two-sided marketplaces, complex SaaS, real-time data streaming, custom AI pipelines |
Regulated / Enterprise MVP | $150,000+ | 5 – 9+ months | FinTech, healthcare (HIPAA), high security, and heavy enterprise compliance products |
Two applications with the same number of screens can require very different budgets. One may only store basic records, while another requires payments, permissions, real-time updates, audit logs, complex calculations, or integration with several external systems.
The main MVP cost drivers include:
- Feature and workflow complexity
- Number of user roles
- Web, native, or cross-platform delivery
- Backend architecture
- Third-party integrations
- Security and compliance
- Testing requirements
- Team structure
- Delivery timeline
- Post-launch iteration
What Is an MVP App?
A minimum viable product is the smallest functional version of a digital product that allows a business to test a core assumption with real users.
An MVP is not automatically:
- A clickable prototype
- A low-quality application
- A nearly finished product
- A collection of every feature on the roadmap
A useful MVP lets users complete the main value-producing action. It should also collect enough evidence to help the business decide whether to continue, change direction, or invest further.
For example:
- A booking MVP should let users find, request, and confirm a service.
- An ecommerce MVP should let customers discover, purchase, and track a product.
- A marketplace MVP should connect two user groups and support a controlled transaction.
- A SaaS MVP should help users complete a repeatable business process.
- An AI MVP should demonstrate measurable improvement in speed, accuracy, personalization, or automation.
MVP vs Prototype, Beta, and Full Product
These product stages serve different purposes and should not be assigned the same budget.
Product Stage | Main Purpose | Typical Output |
Prototype | Test an idea or user flow. | Clickable screens without complete backend logic |
MVP | Test real product demand. | Working product with essential functionality |
Beta | Identify usability and technical issues. | Refined version released to selected users |
Full Product | Support growth and operations. | Broader features, automation, and scalability |
A prototype demonstrates how an idea may work. An MVP allows people to use its core value. A full product supports larger operations and long-term growth.
Many budgeting problems begin when a business requests an MVP but describes a complete product.
MVP App Development Cost by Complexity
Complexity has a greater impact on cost than screen count alone. A simple dashboard and a real-time marketplace may contain a similar number of interfaces but require completely different engineering effort.
Lean MVP: $20,000–$40,000
A lean MVP may include:
- One primary user type
- Registration and authentication
- One core user journey
- Basic UI design
- A simple database and backend
- Limited administrative controls
- Analytics and error monitoring
- Basic testing and deployment
This range may suit a focused booking tool, an internal workflow application, a customer portal, or an early web product.
Standard Startup MVP: $40,000–$80,000
A standard MVP may include:
- Multiple user roles
- Custom UI and a reusable design system
- Payment or subscription integration
- User and admin dashboards
- Notifications
- Search and filtering
- Third-party APIs
- Detailed backend logic
- Cross-device testing
This is a common range for startup products that must support genuine customer or operational activity after launch.
Advanced MVP: $80,000–$150,000+
An advanced MVP may involve:
- Two-sided marketplace workflows
- Real-time messaging
- Live location tracking
- Advanced permissions
- AI functionality
- Complex payment distribution
- Multi-tenant SaaS architecture
- External data systems
- High-volume media
- Deeper security controls
Regulated or Enterprise MVP: $150,000+
Fintech, healthcare, insurance, and enterprise products may require additional security architecture, audit trails, documentation, access controls, legal review, testing, and deployment governance.
The word “minimum” does not remove regulatory, privacy, or security responsibilities.
MVP Development Cost by Product Type
Different product categories introduce different technical and operational requirements.
Product Type | Typical MVP Range | Main Cost Drivers |
Booking Application | $25,000 – $60,000 | Real-time availability calendars, automated scheduling logic, user profiles, and push/SMS notifications |
Ecommerce MVP | $40,000 – $90,000 | Dynamic product catalogs, secure checkout pipelines, payment gateways, order management, and basic inventory tracking |
SaaS MVP | $50,000 – $120,000 | Multi-tier subscriptions, role-based access control (RBAC), analytics dashboards, and multi-tenant database isolation |
Marketplace MVP | $70,000 – $150,000+ | Dual buyer/seller workflows, automated commission split logic, escrow/payouts, and dispute handling systems |
AI-Powered MVP | $60,000 – $150,000+ | LLM/model integrations, custom RAG data pipelines, vector search infrastructure, automated evaluation, and safety guardrails |
Fintech MVP | $80,000 – $180,000+ | Payment gateway APIs, KYC/AML identity verification, complete transaction auditability, and bank-grade data security |
Healthcare MVP | $80,000 – $180,000+ | HIPAA/GDPR compliance, protected health information (PHI) encryption, role permissions, and EHR/EMR system integrations |
Logistics MVP | $70,000 – $160,000+ | GPS fleet tracking, dispatch algorithms, mapping/route optimization data, and operational admin dashboards |
These ranges overlap because product category alone does not determine cost. Feature depth, business rules, and operational risk are often more important than the label attached to the application.
What Each MVP Budget May Buy
A budget range becomes more useful when it is connected to a practical outcome.

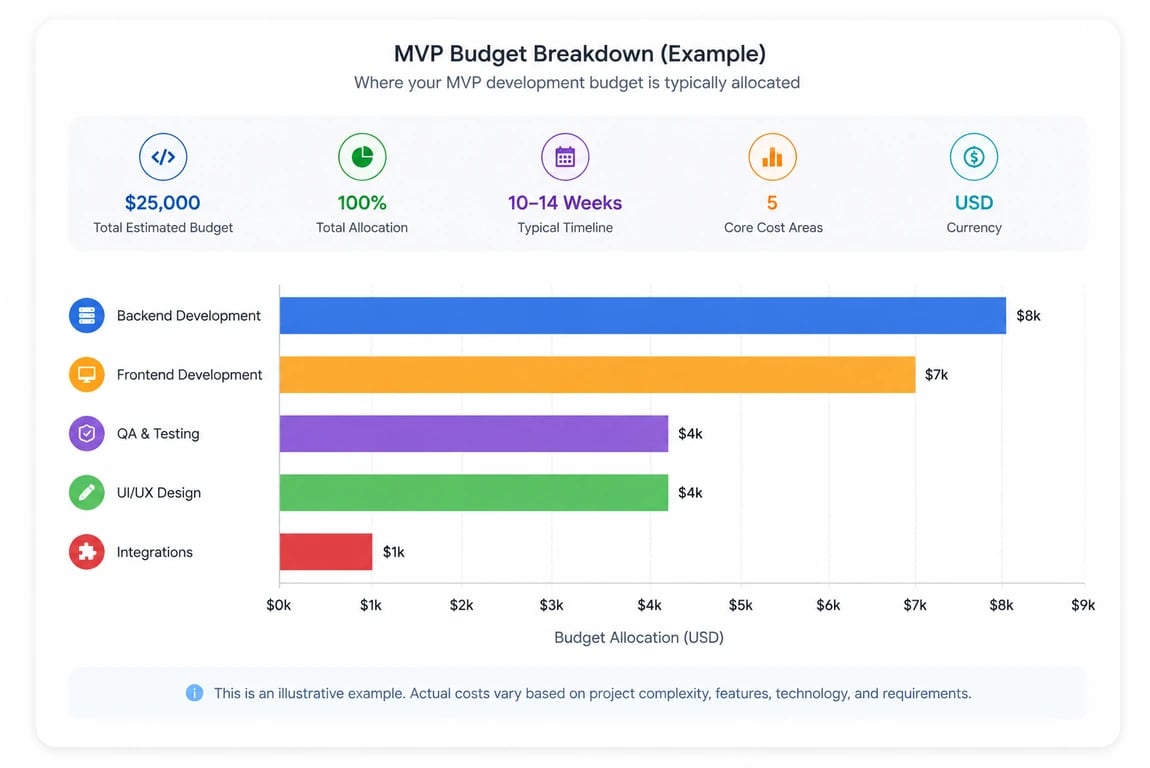

Around $25,000
This budget may support a narrow web or mobile product with one user role, limited screens, basic authentication, a simple backend, and minimal integrations.
It is not normally enough for a polished multi-sided marketplace, complex AI system, or regulated product.
Around $50,000
This may support a focused custom MVP with stronger UX, an admin dashboard, payment integration, notifications, and a production-ready backend.
The feature list will still require strict prioritization.
Around $100,000
This budget may support multiple roles, deeper workflows, stronger infrastructure, custom dashboards, advanced integrations, more extensive QA, and a wider launch scope.
Above $150,000
This level may be appropriate when validation requires regulatory controls, complex business logic, several interconnected applications, real-time operations, or enterprise-grade integrations.
A larger budget should buy reduced risk and better validation capability, not unnecessary features.
Illustrative MVP Cost Scenario
Consider a service-booking marketplace with customers, providers, and administrators.
Product area | Illustrative MVP scope |
Customer application | Registration, search, provider profiles, booking, and notifications |
Provider portal | Availability, service management, and booking decisions |
Administration | Users, listings, bookings, and basic reporting |
Payments | Third-party checkout and payment-status handling |
Backend | APIs, database, authentication, and booking logic |
QA | Functional, responsive, and device testing |
Launch | Production setup, analytics, and release support |
A focused version of this product may require approximately $60,000–$110,000.
This is an illustrative planning scenario, not a fixed quotation or a claimed Digixvalley case study. The final estimate would depend on confirmed requirements, assumptions, dependencies, and delivery responsibilities.
The cost may increase if the product adds:
- Live chat
- Automated matching
- Recurring subscriptions
- Split payments
- Dispute management
- Multi-language support
- Multi-location operations
- AI recommendations
- Advanced provider analytics
This demonstrates why buyers should compare complete scope rather than total price alone.
MVP Cost Breakdown by Development Phase
A reliable proposal should explain where the development budget is going.
Development phase | Typical budget share | Main deliverables |
Discovery and planning | 8%–12% | Requirements, assumptions, user flows, and roadmap |
UI/UX design | 12%–18% | Wireframes, interface design, and prototype |
Frontend development | 20%–30% | Mobile or web user experience |
Backend development | 20%–30% | APIs, database, authentication, and business logic |
Integrations | 8%–15% | Payments, maps, CRM, messaging, and analytics |
QA and testing | 8%–12% | Functional, regression, and device testing |
Deployment | 3%–6% | Environments, stores, and production launch |
Project management | 5%–10% | Planning, communication, and delivery control |
These percentages can overlap because project structures differ.
Backend work may equal or exceed frontend work when the MVP includes complex data, permissions, subscriptions, reporting, or operational workflows. Professional backend development solutions can support secure APIs, databases, dashboards, integrations, and scalable cloud architecture.

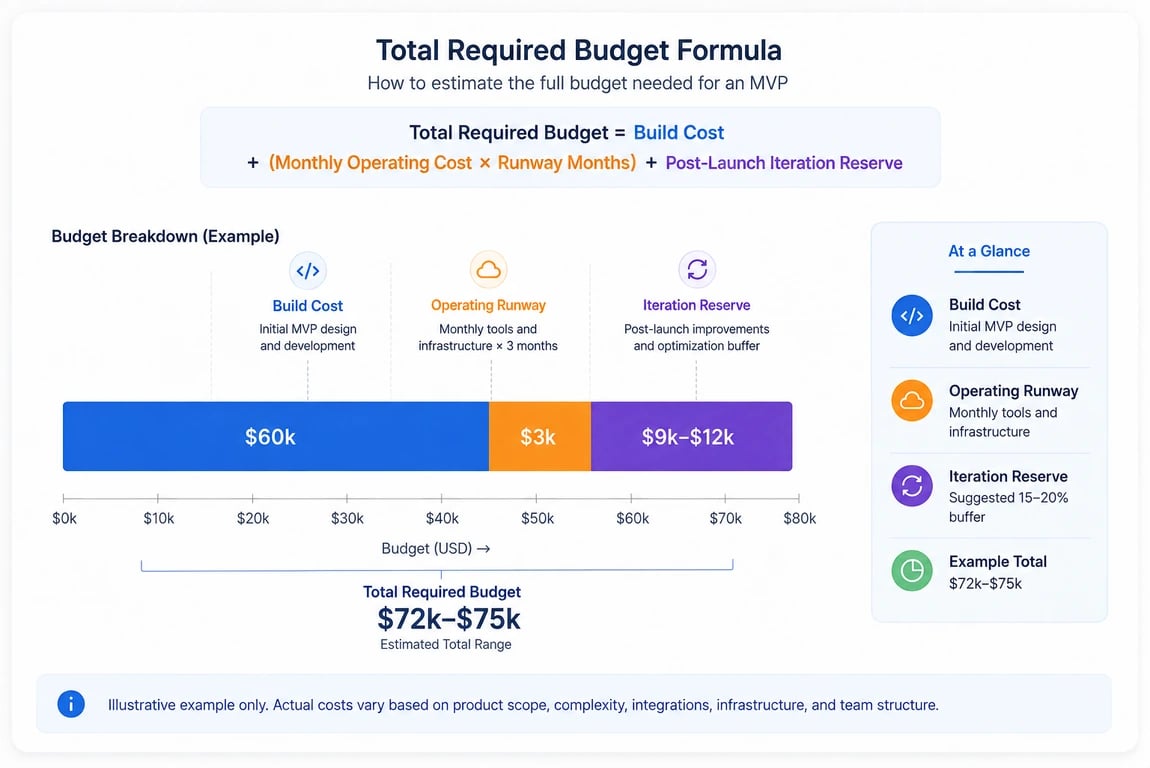

MVP Budget Planning Formula
The initial development quotation should not be treated as the entire MVP budget.
A more practical planning formula is
Initial Build Cost + Launch Cost + Post-Launch Iteration Budget
Initial build cost
This covers discovery, design, frontend and backend development, integrations, testing, and project delivery.
Launch cost
This may include production infrastructure, app-store preparation, monitoring, analytics configuration, final testing, and release support.
Post-launch iteration budget
These funds fix and improved based on real user behavior.
A practical planning reserve is approximately 15%–30% of the initial development budget, although the appropriate amount depends on launch risk and product maturity.
For example, if the initial MVP costs $60,000, a startup may reserve another $9,000–$18,000 for early improvements.
This reserve does not need to be spent immediately. It prevents the team from reaching launch with no budget available to respond to what users reveal.
The Main Factors That Change MVP Cost
Several decisions can move an MVP from one pricing tier to another.
Feature scope
Each screen does not carry the same engineering cost. A static profile is simpler than a payment flow, dispatch engine, recommendation system, or collaborative dashboard.
Number of user roles
Customers, vendors, administrators, support agents, drivers, managers, and partners may each need separate permissions and workflows.
Backend complexity
Cost rises when the product requires:
- Real-time synchronization
- Multi-tenant data separation
- Advanced search
- Audit logs
- Scheduled processing
- Role-based access
- Large-file or media storage
- Complex reporting
Third-party integrations
Payment gateways, maps, SMS, email, identity services, CRMs, analytics platforms, and AI providers reduce the need to build every capability from scratch.
However, each integration still requires configuration, data mapping, error handling, security controls, documentation, and testing.
UI and UX depth
A custom interface costs more than a product assembled from standard components. The MVP should still provide enough clarity, accessibility, and visual consistency for users to understand and trust it.
Security and compliance
Authentication, encryption, access control, logging, retention rules, and regulatory obligations must be scoped early. They should not be treated as final-week additions.
Platform Choice: Web, iOS, Android, or Cross-Platform?
Platform selection directly influences frontend development, testing, deployment, and maintenance costs.
Mobile vs. Web Approach Comparison Matrix
Approach | Cost effect | Suitable use |
Web-first MVP | Often the most economical | SaaS, B2B systems, portals, and dashboards |
iOS only | Lower than two native applications | Apple-focused target users |
Android only | Lower than two native applications | Android-dominant target users |
Native iOS and Android | Highest mobile frontend cost | Platform-specific features or demanding performance |
Flutter or React Native | Reduces duplicated frontend work | Startups targeting both mobile platforms |
A web-first strategy can be effective when the product does not depend on mobile hardware, background location, or app-store distribution. Web application development may suit SaaS products, portals, dashboards, and workflow-driven systems.
Businesses that need both mobile platforms may use cross-platform app development to share a substantial part of the frontend codebase.
Cross-platform development does not remove the cost of backend engineering, integrations, QA, security, deployment, or platform-specific adjustments.
Development Team Models and Pricing
The delivery model influences budget, communication, continuity, accountability, and long-term maintainability.
Team Model Comparison Matrix
Team model | Relative cost | Suitable for | Main risk |
Freelancer | Lower | Narrow tasks and prototypes | Limited capacity and continuity |
Small agency | Medium | Focused startup MVPs | Quality varies by team |
Product development company | Medium to high | Strategy, design, engineering, and QA | Higher initial investment |
In-house team | High | Long-term product ownership | Hiring time and operating overhead |
No-code team | Low to medium | Early validation and simple workflows | Customization and scalability limits |
Clutch’s August 2026 pricing guide reports that many app development companies charge around $25–$49 per hour, although actual rates vary by location, specialization, seniority, and provider model.
A fair comparison should include discovery, design, frontend work, backend work, testing, project management, documentation, deployment, and support, not only the hourly rate.
The cheapest quote is not always the least expensive outcome. Missing requirements, weak architecture, poor communication, and insufficient QA can produce rework that exceeds the initial saving.
MVP Development Timeline
A focused MVP may take approximately 8–20 weeks to plan, design, develop, test, and launch.
Phase | Typical duration |
Discovery | 1–2 weeks |
UI/UX design | 2–4 weeks |
Architecture and setup | 1–2 weeks |
Development | 6–12 weeks |
QA and stabilization | 2–4 weeks |
Launch preparation | 1–2 weeks |
Some phases can overlap. A regulated or integration-heavy product may take considerably longer.
Timeline and cost are connected. An aggressive deadline may require a larger team, parallel workstreams, quicker stakeholder decisions, and increased coordination.
Hidden and Ongoing MVP Costs
The development quotation is not the complete cost of owning and operating an MVP.
Hidden cost | Why it matters |
Cloud hosting | Powers backend services, databases, storage, and APIs |
Database and media storage | Increases as user records, files, and activity grow |
Maps and location services | May charge by requests, sessions, or billable events |
Payment processing | Introduces transaction and payout fees |
Email and SMS | Charges usually grow with user activity |
App-store accounts | Required for mobile distribution |
Analytics and monitoring | Needed to measure validation and diagnose failures |
Maintenance | Covers bugs, dependencies, and operating-system updates |
Security improvements | Protects accounts, data, and business operations |
Legal and compliance reviews | May be necessary for regulated or sensitive products |
Customer-support tools | Help manage user questions and incidents. |
Admin operations | Internal teams may require controls and reporting. |
Post-launch iteration | Funds evidence-based product improvements |
Marketing and onboarding | Helps the product reach and activate its first users |
Google Maps Platform currently supports pay-as-you-go billing in which pricing is based on billable events for the services used. Google also provides quotas and budget alerts that teams can use to monitor spending.
Mobile distribution also carries direct account costs. Apple lists its Developer Program at $99 per membership year, while Google Play requires a US$25 one-time registration fee for a Play Console account.
These fees may look small compared with development, but they illustrate why founders should separate the build quotation from the complete launch and ownership budget.
How AI Changes MVP Development Cost in 2026
AI-assisted tools can reduce time spent on repetitive coding, documentation, testing support, and early prototyping.
They do not remove the need for product decisions, architecture, integration work, quality assurance, security, or experienced technical review.
GoodFirms’ 2026 software-development research found widespread adoption of AI for planning, coding, and testing, but it also noted that complex AI integrations can increase budgets.
An AI feature can increase cost when it requires:
- Model or provider selection
- Retrieval and data pipelines
- Prompt and output evaluation
- Guardrails and moderation
- Human-review workflows
- Usage monitoring
- Cost controls
- Privacy protection
- Fallback behavior
Startups should add AI when it improves the product’s central value proposition, not simply because it is popular. Specialized AI development services can support architecture, model integrations, automation, and intelligent product experiences.
MVP Features to Build First
Feature prioritization protects the budget by separating validation requirements from future product ambitions.
Priority | Feature type | MVP decision |
Must-have | Required to complete the core user journey | Include |
Should-have | Improves trust, clarity, or usability | Include when budget permits. |
Could-have | Useful but not essential to validation | Move to a later release. |
Advanced | AI, automation, personalization, or deep analytics | Include only when central to the hypothesis. |
A feature should normally enter the first release only when it helps answer a product, market, operational, or technical question.
For example:
- A booking MVP needs search, availability, booking, and confirmation.
- It may not need loyalty points, advanced recommendations, or multiple membership tiers.
- A SaaS MVP needs the workflow that creates measurable user value.
- It may not need a fully customizable reporting engine at launch.
A strong MVP is not the smallest possible product. It is the smallest product that can produce useful evidence.
How to Reduce MVP Cost Without Weakening Validation
Cost reduction should come from removing unnecessary scope, not removing the quality required to test the idea reliably.
Build one complete journey
Choose the most important user action and make it work from beginning to end.
Reduce roles before reducing quality
Supporting one user type well is often better than providing incomplete workflows for five different groups.
Start on the most important platform
Do not build iOS, Android, and web simultaneously unless validation genuinely depends on all three.
Use established services
Use proven tools for authentication, payments, notifications, analytics, and infrastructure when they suit the requirements.
Delay operational automation
Some early processes can remain manual until the product demonstrates that automation is necessary.
Define success before development
Choose the event that will demonstrate meaningful demand, such as
- Completed bookings
- Paid subscriptions
- Successful transactions
- Repeat usage
- Time saved
- Reduced operational errors
Control change requests
New ideas should enter a later roadmap unless they are essential to the current validation objective.
What You Should Not Cut
Even a lean product requires a reliable foundation.
Do not remove:
- The core user journey
- Basic security
- Suitable database design
- Error handling
- Essential compliance
- Analytics
- Critical QA
- Backup and recovery planning
- Basic monitoring
- Clear ownership and handover terms
A broken MVP can generate misleading feedback because users are responding to technical failure rather than the business idea.
Get a Clear MVP Budget Before Development Starts
How to Validate an MVP Development Quote
Before approving a proposal, confirm that it explains:
- Which features are included?
- Which platforms are included?
- How many user roles are covered?
- Is the backend included?
- Is an admin dashboard included?
- Which integrations are included?
- What testing will be completed?
- What is excluded?
- Who pays third-party service fees?
- How are change requests handled?
- What happens after launch?
- Who owns the source code and project accounts?
- What assumptions could change the estimate?
- Which milestones trigger payments?
Two quotations cannot be compared fairly unless these areas are aligned.
MVP Proposal Red Flags
A low total price is not enough to judge whether a proposal is reliable.
Be cautious when a proposal includes:
- A total price without a feature breakdown
- No discovery or planning phase
- No backend description
- No QA scope
- No integration assumptions
- No exclusions
- No delivery milestones
- No analytics plan
- No post-launch process
- Unqualified scalability promises
- Automatic ownership claims without contract terms
- An unusually short delivery timeline
A low quotation may represent a smaller scope rather than greater efficiency.
Common MVP Budgeting Mistakes
Many MVP budgets fail because the startup has not defined what must be validated first.
Common mistakes include:
- Building too many features before testing demand
- Treating an MVP as a smaller version of the complete product
- Designing for scale before proving the core user need
- Building two native apps when one platform or cross-platform product would work
- Underestimating backend complexity
- Ignoring admin and operational requirements
- Treating integrations as simple add-ons
- Removing QA to reduce the initial quotation
- Forgetting cloud, API, and store expenses
- Launching without analytics
- Comparing vendor prices without comparing scope
- Reserving no budget for post-launch learning
The best MVP budgets connect spending to evidence. Every first-release feature should help answer an important question.
When Should a Startup Spend More?
A larger budget may be justified when:
- Users must trust the product with money or sensitive data.
- The core experience depends on real-time performance.
- The product requires complex external systems.
- Multiple user roles are essential to validation.
- Strong UX is part of the value proposition.
- The MVP will be evaluated by enterprise buyers.
- Poor architecture would prevent the next planned stage.
- A security failure could harm users or the business.
Spend more where failure would invalidate the test. Avoid spending more on speculative features.
How These MVP Cost Ranges Were Estimated
The figures in this guide are planning benchmarks, not fixed quotations or claims about completed client projects.
They reflect the primary factors that influence development effort:
- Product complexity
- Number of user roles
- Platform selection
- Backend architecture
- Integration requirements
- Security obligations
- Testing scope
- Delivery timeline
- Team structure
- Post-launch needs
They were also compared with broader 2026 pricing research from Clutch and GoodFirms. Those sources demonstrate that app and software-development budgets vary widely according to scope, complexity, platform requirements, team composition, security, and scalability.
A final estimate should only be prepared after the requirements, assumptions, dependencies, and exclusions have been reviewed.
Two MVPs in the same category may require different budgets because their workflows, data requirements, and technical risks are not identical.
Why Work With Digixvalley?
Digixvalley supports startups with discovery, product scoping, UI/UX design, mobile and web development, backend engineering, integrations, testing, deployment, and post-launch improvement.
The objective is not to turn an MVP into a complete product before validation. It is to identify what the product must prove, build the required foundation, and create a realistic path for future development.
Businesses evaluating potential partners can review relevant software development case studies to understand how product strategy, interfaces, integrations, and engineering work together across digital products.
For mobile-first ideas, professional mobile app development services can support product planning, interface design, engineering, testing, and launch.
Final Takeaway
MVP app development cost in 2026 is determined by scope, product complexity, platform strategy, backend requirements, integrations, security, team structure, and launch objectives.
The cheapest application is not automatically the best MVP. The best MVP is the smallest reliable product capable of testing a real business assumption.
Before development begins, define:
- The first target user
- The main problem being tested
- The essential user journey
- The evidence that will indicate demand
- The features that can wait
- The risks that cannot be ignored
Clear priorities make the budget more predictable and the resulting product more useful. Startups that need expert support can work with Digixvalley for MVP app development to turn these priorities into a focused scope, practical budget, and realistic launch plan.
Plan Your MVP Before You Build It
FAQs About MVP App Development Cost
How much does MVP app development cost in 2026?
A custom startup MVP commonly requires approximately $20,000–$150,000 or more. A focused product may remain near the lower end, while marketplaces, AI products, fintech platforms, healthcare applications, and complex SaaS systems may exceed $100,000.
Can an MVP be built for under $10,000?
A prototype, landing page, no-code validation product, or tightly limited internal tool may cost less than $10,000.
A custom application with a backend, security, integrations, testing, and production deployment usually requires a larger budget.
How long does it take to develop an MVP?
A focused MVP may take approximately 8–20 weeks. Products with regulatory requirements, several user roles, real-time functionality, or external integrations may take longer.
Is a web MVP cheaper than a mobile MVP?
It often is because a web product can avoid separate mobile-platform requirements and app-store release work.
Mobile may still be the correct choice when the use case depends on portability, notifications, cameras, sensors, or location services.
Should a startup build iOS and Android together?
Only when both platforms are necessary to reach the first target users.
Otherwise, launching on one platform may reduce cost and accelerate validation. Cross-platform frameworks may also reduce duplicated frontend work.
What is usually the most expensive part of an MVP?
Backend architecture, integrations, security, and complex business logic frequently require more effort than founders initially expect.
The visible interface is only one part of the product.
Is no-code suitable for an MVP?
No-code can be useful for testing simple workflows, market demand, internal tools, and early product concepts.
It becomes less suitable when the product requires specialized logic, deep integrations, high performance, advanced security, or extensive customization.
How much should be reserved after launch?
A planning reserve of approximately 15%–30% of the initial development budget may help fund bug fixes, usability improvements, operational changes, and features supported by real user evidence.
What should an MVP estimate include?
An MVP estimate should cover discovery, UI/UX design, frontend development, backend development, integrations, administration tools, testing, deployment, assumptions, exclusions, milestones, ownership, and post-launch responsibilities.
