Two software development companies submit proposals for the same SaaS project. The nearshore provider offers daily collaboration with the US product team. The offshore provider quotes a lower hourly rate but operates several time zones away.
Both claim experienced engineers, agile delivery, and predictable releases.
The challenge begins when the buyer compares what each proposal actually includes. One vendor provides technical leadership and QA within its price. The other expects the customer’s engineering team to manage architecture, testing, and coordination.
Comparing hourly rates alone would produce the wrong conclusion.
The real decision in nearshore vs offshore software development is which delivery arrangement can produce the required software at an acceptable total cost, with manageable collaboration delays, quality risks, and contractual responsibilities.
Nearshore teams often offer convenient business-hour overlap. Offshore teams may provide competitively priced engineering capacity, particularly when work can progress through structured asynchronous collaboration.
Neither model guarantees better code, faster releases, or lower total spending.
For US founders, CTOs, and engineering leaders planning projects in 2027, the comparison should start with project requirements and delivery accountability—not geography.
This guide explains cost differences, time-zone requirements, outsourcing risks, engagement models, and vendor evaluation. It also introduces a practical total-delivery-cost model and paid-pilot scorecard for comparing providers before signing a contract.
Nearshore vs Offshore Software Development: What's the Difference?
Nearshore software development involves working with an external engineering team in a geographically nearby country or region.
Offshore software development involves working with a team in a more distant country, often with a larger difference in working hours.
Both are software outsourcing arrangements. Their distinction primarily concerns delivery location, not the quality of the engineers or the contractual engagement model.
For US businesses, Mexico and Colombia are common nearshore examples, while India, Pakistan, and Vietnam are offshore examples.
The classifications depend on the customer’s location. A destination considered offshore for a US business may be nearshore for a company elsewhere.
Onshore vs Nearshore vs Offshore: Key Differences
| Factor | Onshore | Nearshore | Offshore |
|---|---|---|---|
| Team location | Customer’s country | Nearby country or region | Distant country or region |
| US buyer example | United States | Mexico or Colombia | Pakistan, India, Vietnam |
| Working-hour overlap | Usually convenient | Often substantial | Depends on location and agreed shifts |
| Hourly pricing | May be higher | Often competitive with domestic delivery | Often competitive in distant markets |
| Communication | Straightforward scheduling | Usually convenient for live meetings | Often requires deliberate coordination |
| In-person meetings | Generally easier | International travel may be practical | May involve longer travel |
| Engineering quality | Provider-dependent | Provider-dependent | Provider-dependent |
| Main advantage | Domestic presence and collaboration | Geographic proximity and overlapping hours | Access to broader talent markets and pricing options |
| Main limitation | Potentially higher delivery costs | Rate differences and available skills vary | Potential scheduling and coordination complexity |
The geographic distinction matters, but it should not determine the purchasing decision by itself.
A geographically offshore team working an agreed US-compatible schedule remains offshore. The adjusted working hours improve collaboration without changing the team’s physical location.
Similarly, geographic proximity does not automatically guarantee sufficient overlap with the specific engineers assigned to a project.
Which Is Better: Nearshore or Offshore Software Development?
Nearshore development is often a stronger option when product requirements change frequently, internal stakeholders need ongoing access to engineers, or critical technical decisions require real-time discussion.
Offshore development can be a strong option when the project has a stable backlog, clearly assigned ownership, and delivery work that can proceed independently.
The best choice changes according to the assigned team’s expertise and operating arrangements.
Software Outsourcing Decision Matrix
| Project situation | Model to evaluate first | Why | What could change the recommendation |
|---|---|---|---|
| Early-stage SaaS with frequent product changes | Nearshore | Easier stakeholder interaction | Offshore team offers dependable overlap and product leadership |
| Well-defined feature modules | Offshore | Supports independent delivery | Frequent cross-system approvals are necessary |
| Legacy modernization | Nearshore or hybrid | Architecture and dependencies need coordination | Strong documentation enables independent workstreams |
| Automated testing and regression | Offshore | Work can often proceed asynchronously | Restricted environments require live access or supervision |
| US-hour production engineering | Nearshore | Easier daytime coordination | Offshore team offers contracted shift coverage |
| Long-term product roadmap | Either | Team continuity matters more than location | Technical leadership, pricing and availability determine fit |
| Regulated enterprise application | Qualified eligible provider | Compliance requirements are decisive | Legal or contractual restrictions exclude particular arrangements |
| Multiple independent engineering workstreams | Offshore or hybrid | Can support scalable execution | Cross-team dependencies increase coordination cost |
These recommendations are starting points, not universal rules.
A strong offshore provider may be a better choice for a highly collaborative project than a weak nearshore provider.
The deciding factors should be actual delivery capability, agreed availability, management responsibility, and total cost.
Compare Location Separately From Engagement Model
Nearshore and offshore describe where engineers work.
Staff augmentation, dedicated teams, managed delivery, and fixed-scope development describe how responsibility and payment are structured.
For example, a nearshore staff-augmentation arrangement may require the customer to manage every engineer directly.
An offshore managed team may include its own technical lead, QA responsibilities, release process, and delivery coordination.
Those differences can have more influence on the buyer’s operating workload than geography alone.
How Much Does Nearshore vs Offshore Software Development Cost?
Nearshore and offshore development costs vary by region, seniority, technical specialization, engagement structure, and included services.
For US businesses, Latin American providers often compete on working-hour alignment, while selected Asian markets may offer lower quoted rates for comparable roles.
However, regional price ranges do not establish the cost of an individual vendor.
Published Software Development Rate Benchmarks
Accelerance published regional developer-rate ranges on November 24, 2025, as part of its 2026 Global Software Development Rates & Trends research.
| Region | Junior Developer | Senior Developer |
|---|---|---|
| Latin America | $33–$45/hour | $60–$75/hour |
| Asia | $24–$31/hour | $31–$41/hour |
| Europe | $31–$39/hour | $64–$76/hour |
Source: Accelerance — 2026 Outsourcing Rate Trends.
The published figures draw on Accelerance’s research with software development partners. They are regional benchmarks, not guaranteed quotes or independently established averages for every engineer.
Actual proposals may fall above or below these ranges.
Clutch’s Software Development Company Pricing Guide, updated September 21, 2026, reports that many development companies listed on its platform charge $24–$49 per hour.
These sources measure different populations. Clutch’s company-level pricing information should not be treated as directly equivalent to Accelerance’s seniority-specific regional ranges.
Are There Verified 2027 Developer Rates?
Accelerance has published a 2027 Global Software Engineering Rates & Trends Guide.
Its public description discusses updated rate benchmarking, AI adoption, engineering maturity, and delivery economics.
However, the exact new regional numerical benchmarks are not visible in the publicly accessible guide description reviewed for this article.
For that reason, the table above retains its clearly dated 2026 source rather than presenting unverified figures as 2027 rates.
Buyers preparing 2027 budgets should compare current vendor quotations with published benchmarks and verify that the methodology and services are comparable.
What Does the Hourly Rate Include?
A quoted rate may cover only a developer or include a broader delivery service.
Before comparing vendors, determine whether each quotation includes the same responsibilities.
| Responsibility | Individual Developer Quote | Managed Delivery Quote |
|---|---|---|
| Feature implementation | Usually included | Usually included |
| Technical architecture | May be client-owned | Depends on agreed scope |
| Code reviews | May rely on client engineers | May be included |
| Quality assurance | Often separate | May be included |
| Project management | Often client-owned | May be included |
| DevOps and deployment | Depends on role | Depends on agreement |
| Delivery reporting | Usually limited | Often part of governance |
| Support and maintenance | Contract-dependent | Contract-dependent |
These are common engagement distinctions, not promises about every provider.
The buyer should request a responsibility matrix and a complete commercial schedule.
A lower rate may still offer better value, but only after missing services and customer-side work are accounted for.
Planning a medicine delivery platform for Texas?
How to Calculate the True Cost of Nearshore vs Offshore Development
The most useful cost comparison estimates the expense of delivering the same accepted product.
Hourly rates are only one component.
A meaningful total-cost model also considers the customer’s management effort, onboarding, integration, additional billable work, and agreed transition responsibilities.
Total Delivery Cost Formula
Estimated Total Delivery Cost = Vendor Fees + Buyer-Side Coordination + Onboarding & Integration + Additional Contractually Billable Work + Transition & Support Costs
The model should use equivalent deliverables, quality requirements, support periods, and commercial assumptions.
Costs already included in a vendor’s fees should not be counted again.
For example, if a managed team includes technical leadership, the buyer should not automatically add an identical external architecture-management charge.
Example: Comparing Two Hypothetical Vendor Proposals
Consider a US SaaS company planning one product release.
The buyer defines 1,000 billable team-hours of equivalent engineering work covering implementation, agreed reviews, testing, and release preparation.
Both vendor scenarios are assumed to satisfy the same technical requirements and acceptance standards.
| Cost Component | Nearshore Scenario | Offshore Scenario |
|---|---|---|
| Illustrative blended rate | $60/hour | $40/hour |
| Planned billable team-hours | 1,000 | 1,000 |
| Initial vendor fees | $60,000 | $40,000 |
| Assumed buyer-side coordination | $6,000 | $12,000 |
| Initial modeled cost | $66,000 | $52,000 |
All amounts are hypothetical examples, not vendor quotations, observed project outcomes, regional coordination averages, or Digixvalley prices.
Under these assumptions, the offshore scenario begins $14,000 below the nearshore scenario.
That difference represents an initial cost advantage—not a proven saving.

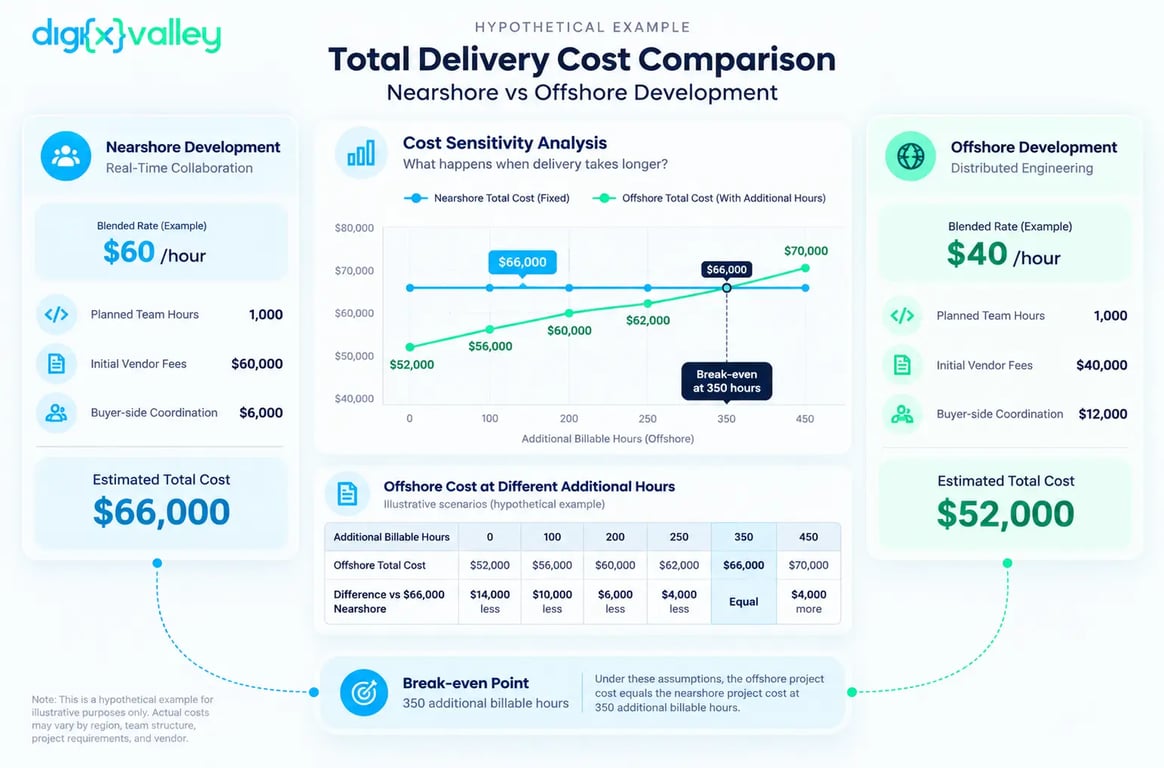

Cost Sensitivity: What Happens When Delivery Takes Longer?
Suppose the offshore engagement is time-and-materials based, and the estimate increases while the agreed scope remains the same.
Any additional hours must be contractually billable. The example does not assume the customer should pay for defects the vendor is obligated to correct.
| Additional Billable Offshore Hours | Offshore Total Cost | Difference vs $66,000 Nearshore |
|---|---|---|
| 0 | $52,000 | $14,000 less |
| 100 | $56,000 | $10,000 less |
| 200 | $60,000 | $6,000 less |
| 250 | $62,000 | $4,000 less |
| 350 | $66,000 | Equal |
| 450 | $70,000 | $4,000 more |
The break-even calculation is:
($66,000 − $52,000) ÷ $40 = 350 additional billable hours
This result applies only to the assumptions above.
It does not mean offshore projects typically require 350 additional hours or that nearshore projects have fewer overruns.
The point is to test how much estimate variance a cost advantage can absorb.
Sensitivity to Buyer-Side Coordination
The model also changes when internal coordination is more expensive than originally forecast.
Assume the direct offshore fee remains $40,000 and the nearshore comparison remains $66,000.
| Offshore Coordination Cost | Offshore Cost Before Extra Hours | Additional Billable Hours to Break Even |
|---|---|---|
| $12,000 | $52,000 | 350 |
| $16,000 | $56,000 | 250 |
| $20,000 | $60,000 | 150 |
These figures are illustrative scenarios, not evidence that offshore teams generally need more supervision.
They help buyers identify which assumptions materially affect the decision.
What Should Be Included in a Comparable Vendor Estimate?
Both proposals should cover the same functional requirements, technology responsibilities, engineering roles, testing standards, integrations, documentation, deployment conditions, and acceptance criteria.
Where a responsibility is excluded, assign an estimated owner and cost.
This is especially important when comparing a managed delivery team with staff augmentation.
The buyer should separate:
Approved scope changes: New work the customer explicitly authorizes.
Estimate variance: Additional effort that may be billable depending on the agreed commercial terms.
Vendor-caused defects: Remediation that may remain the vendor’s contractual responsibility.
External delays: Dependencies whose cost treatment should be agreed in advance.
Combining these into one generic “rework budget” hides important contractual distinctions.
What the Cost Model Cannot Reliably Predict
A late product launch may cause lost revenue, contractual penalties, or internal team downtime.
Those effects should only be quantified when the company has credible supporting assumptions.
If the commercial impact is unknown, record the dependency and risk rather than inventing a dollar value.
A useful cost model identifies the assumptions most likely to change the purchasing decision.
It does not guarantee the outcome of a future engagement.
How Much Time-Zone Overlap Does a Development Team Need?
A development team needs enough working-hour overlap to resolve decisions without repeatedly blocking progress.
The required amount depends on the project, team independence, stakeholder availability, and type of work.
There is no universal rule requiring every outsourced software team to share a fixed number of working hours with a US customer.

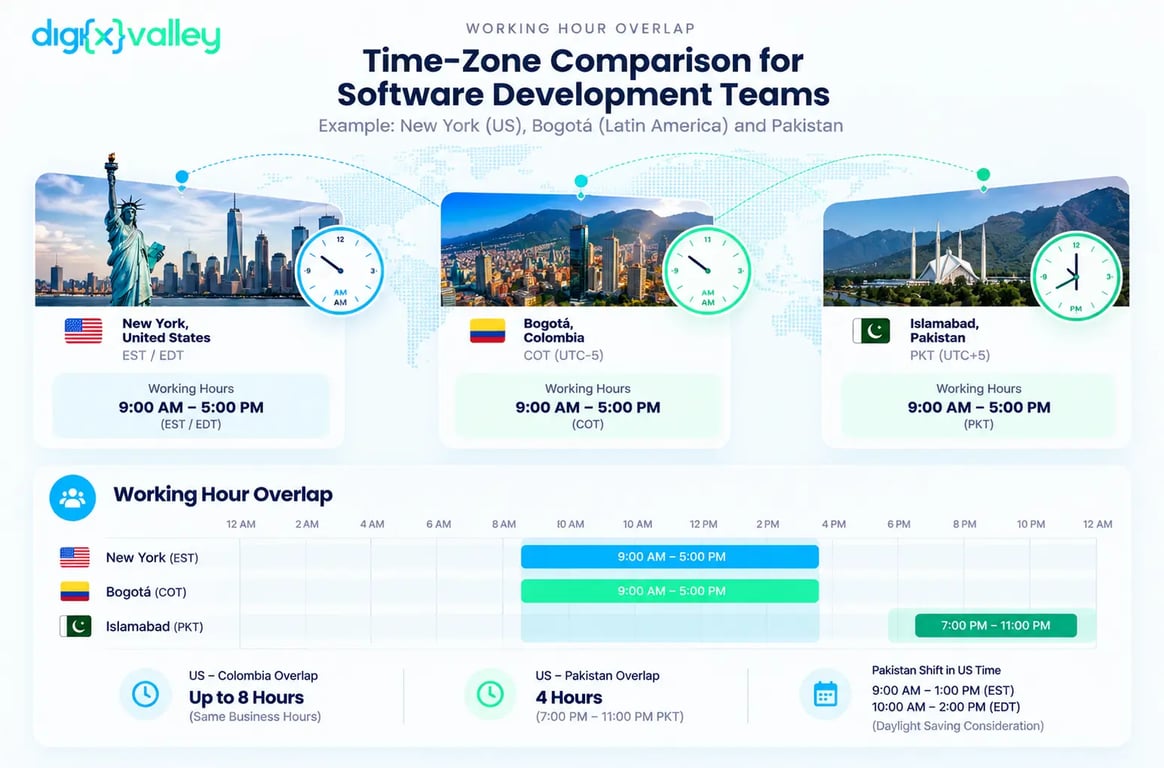

Example: US, Latin American, and Pakistan Working Hours
Assume a New York product team works from 9:00 AM to 5:00 PM Eastern Time.
A Bogotá-based team following ordinary local business hours can share much of that workday, although exact overlap varies seasonally.
A Pakistan-based team working only from 9:00 AM to 5:00 PM Pakistan Standard Time would generally have no overlap with New York’s 9-to-5 schedule.
However, a later Pakistan shift changes the calculation.
A team working 7:00 PM–11:00 PM Pakistan time would overlap with New York as follows:
| New York Season | Pakistan Shift | Corresponding New York Hours |
|---|---|---|
| Eastern Standard Time | 7:00–11:00 PM PKT | 9:00 AM–1:00 PM EST |
| Eastern Daylight Time | 7:00–11:00 PM PKT | 10:00 AM–2:00 PM EDT |
That provides four scheduled hours of overlap despite the offshore location.
The actual availability must be confirmed with the assigned engineers.
A generic promise of “US-friendly overlap” is not enough.
Contracts or statements of work should clarify the agreed schedule, applicable holidays, daylight-saving changes, required participants, and arrangements for absences.
Which Engineering Activities Require Real-Time Collaboration?
| Activity | Typical Collaboration Need | Reason |
|---|---|---|
| Product discovery | High | Requirements need discussion and clarification |
| Architecture decisions | Medium to high | Multiple stakeholders approve consequential tradeoffs |
| Independent feature implementation | Low to medium | Approved work can progress asynchronously |
| Code review | Depends on release urgency | Feedback delays can block merging |
| Automated regression testing | Often low | Stable test plans support independent execution |
| Complex integration debugging | Medium to high | Several system owners may need to coordinate |
| Production incident response | Depends on severity and contract | Coverage must satisfy operational obligations |
| Documentation and maintenance | Often low | Defined tasks support asynchronous handoff |
These are operational planning guidelines rather than fixed industry standards.
Measure Decision Latency, Not Just Overlap Hours
Working-hour overlap is useful only when it improves access to the people who can resolve problems.
A team may share four hours with the customer but still wait two days for architecture approval.
Another team may share only one hour but receive actionable decisions through structured documentation and clear ownership.
Decision latency measures the time between a team identifying a blocked question and receiving an answer sufficient to proceed.
Buyers can measure this during a paid pilot.
A good handoff record should identify the blocker, options considered, responsible decision-maker, required response, and next action.
Example: A Delayed Integration Decision
Suppose an outsourced engineer discovers that a payment provider’s API does not support a required transaction flow.
The developer needs the customer’s product owner to choose between changing the user experience and adopting an alternate integration.
If the engineer sends an unstructured message after the product owner finishes work, the issue may remain unresolved until the next business day.
That delay can affect subsequent engineering work.
A defined escalation channel and decision owner can reduce the delay regardless of whether the vendor is nearshore or offshore.
The goal is not to fill every hour with meetings. It is to keep delivery decisions moving.
What Are the Main Risks of Nearshore and Offshore Software Development?
Nearshore and offshore outsourcing share many of the same risks.
Poor requirements, weak testing, unclear ownership, security gaps, and vendor dependency can affect any distributed team.
Location influences some operational constraints, but it does not determine engineering quality.
Software Outsourcing Risk and Control Matrix
| Risk | Potential Failure | Recommended Control |
|---|---|---|
| Requirements ambiguity | Engineers implement incorrect assumptions | Acceptance criteria and named decision owners |
| Communication delays | Important work remains blocked | Overlap schedule, written handoffs, escalation rules |
| Budget increases | Additional work exceeds approved spending | Scope baseline and change control |
| Quality failures | Features pass demos but fail real use | Code reviews, automated tests, release gates |
| Security exposure | Excessive access to code or sensitive systems | Least privilege, monitoring, secure onboarding |
| IP ownership uncertainty | Rights to software become disputed | Written ownership or licensing terms |
| Knowledge concentration | Critical knowledge sits with one engineer | Documentation and cross-training |
| Vendor dependency | Transition becomes costly or disruptive | Client-controlled assets and exit arrangements |
| Unsupported incident response | No responsible engineer is available | Defined operational support coverage |
| AI-generated code risks | More output enters review without adequate validation | Human reviews, tests, and security controls |
These risks should be assessed against the proposed team and contract rather than assumed from its country.
Security Starts With Supplier Due Diligence
A development vendor may receive access to source code, cloud environments, customer information, proprietary algorithms, or production systems.
Security checks should therefore evaluate the supplier, not merely the application being developed.
NIST published its finalized Cybersecurity Supply Chain Risk Management Due Diligence Assessment Quick-Start Guide, SP 1326, on July 8, 2026.
It identifies areas such as supplier provenance, foreign ownership or control, resilience, foundational cybersecurity practices, and supply-chain tiers.
For buyers, this provides a useful structure for evaluating technology suppliers before contracting.
It does not certify a vendor or guarantee that the supplier is secure.
For engineering practices, NIST’s Secure Software Development Framework, SP 800-218, and the OWASP Application Security Verification Standard can inform appropriate security requirements and testing.
A vendor should demonstrate how relevant controls are implemented.
Cross-Border Data Access: What US Buyers Should Check
US buyers should identify what information offshore or nearshore personnel will access, which jurisdictions are involved, and whether contracts or regulations restrict that access.
The US Department of Justice’s Data Security Program addresses certain transactions involving specified countries of concern or covered persons and access to defined categories of US government-related data or bulk sensitive personal data.
It is not a general prohibition on offshore development.
The program’s applicability depends on the parties, transaction type, data categories, relevant thresholds, and other regulatory conditions.
A buyer should not assume that any developer outside the United States is automatically restricted under this program.
Organizations handling relevant data should obtain a legal and security assessment of the actual proposed arrangement.
European Data Transfers
For applicable transfers of personal data from the European Economic Area, the European Commission provides guidance on international transfers and Standard Contractual Clauses.
These instruments may be relevant to some outsourcing arrangements.
However, they are not mandatory in every project and do not automatically resolve all legal requirements.
The applicable mechanism depends on the parties, processing roles, destinations, and other safeguards.
Intellectual Property Ownership and Software Deliverables
Software outsourcing contracts should clearly establish rights to the deliverables.
A buyer should determine whether it will own or license project-specific source code, documentation, designs, technical assets, and other work.
The agreement should also address existing vendor IP, third-party software, and open-source licenses.
Under US copyright law, paying an independent contractor does not automatically make every commissioned software deliverable a work made for hire.
The US Copyright Office explains the relevant categories and written-agreement requirements in its work-made-for-hire guidance.
Under 17 U.S.C. § 204, most copyright ownership transfers require a signed written instrument, subject to the applicable legal conditions.
For international engagements, qualified counsel should assess the agreement and relevant jurisdictions.
An NDA by itself does not establish ownership of newly developed software.
What Should an Exit Plan Include?
A vendor agreement should address what happens when the engagement ends or the team changes.
Important transition requirements may include source code, repository ownership, infrastructure configuration, deployment documentation, test assets, technical decisions, unresolved defects, and credential revocation.
Where the client expects to maintain the software independently, handover documentation should make the application reproducible and supportable.
A strong partner relationship should not require the buyer to remain dependent on one vendor indefinitely.
How Does AI-Assisted Development Affect Outsourcing Decisions in 2027?
AI-assisted coding changes how software teams complete development tasks, but it does not eliminate the need for architecture, testing, integration, security, or technical leadership.
Faster code generation can shift effort toward review, validation, and deployment governance.
In March 2026, DORA’s analysis of AI-assisted software development described how productivity gains can introduce additional verification demands and delivery tradeoffs.
The DORA research cautions against treating individual productivity gains as automatic improvements in organization-wide software delivery.
For outsourcing buyers, this creates a new evaluation requirement.
What to Ask an AI-Assisted Engineering Vendor
| Evaluation Area | Buyer Question |
|---|---|
| AI-generated code | How is generated code reviewed and validated? |
| Security | What information can engineers share with AI tools? |
| IP and licensing | How are third-party code and licensing risks handled? |
| Testing | Does increased code output have adequate automated test coverage? |
| Architecture | Who approves consequential implementation decisions? |
| Productivity claims | What accepted delivery outcomes support claimed improvements? |
| Change management | How does the team prevent larger, riskier release batches? |
A vendor claiming that AI makes its developers substantially faster should provide evidence relevant to the actual type of work.
That might include measured delivery throughput, accepted implementation quality, defect rates, and review efficiency.
The use of an AI tool alone is not proof of improved delivery value.
The same standard should apply to nearshore and offshore teams.
Which Engagement Model Works Best With Nearshore or Offshore Developers?
Development location and delivery responsibility should be selected separately.
The engagement model determines who manages engineering priorities, accepts deliverables, and owns execution.
Staff Augmentation vs Dedicated Team vs Managed Delivery
| Model | Main Management Responsibility | Best Fit | Buyer Consideration |
|---|---|---|---|
| Staff augmentation | Usually customer-managed | Expanding an established engineering team | Requires internal technical leadership |
| Dedicated development team | Shared according to agreement | Continuous product development | Needs clear governance and ownership |
| Managed delivery | Vendor manages agreed execution | Defined outcomes or workstreams | Requires measurable acceptance criteria |
| Fixed-scope project | Contract-defined | Stable, sufficiently specified work | Scope changes need controlled approval |
A buyer with a strong in-house CTO may prefer staff augmentation to add specialist capacity.
A startup without established engineering leadership may need a managed team with architecture, testing, and delivery coordination.
These arrangements can exist in either nearshore or offshore locations.
For an ongoing roadmap, dedicated development teams provide one relevant engagement approach to evaluate.
When Is Offshore Staff Augmentation Appropriate?
Offshore staff augmentation can work when the buyer controls architecture, development standards, code reviews, and product priorities.
The supplier provides engineering capacity, while the customer’s organization remains responsible for integrating that work into its delivery process.
This can be effective when the customer has enough internal leadership to manage distributed engineers.
Businesses evaluating this arrangement should compare relevant offshore software development services against their actual management capacity and required support.
When Is Nearshore Collaboration Valuable?
Nearshore development can be useful when product managers, designers, and engineers need recurring discussions during normal working hours.
That convenience may justify a higher quoted rate when important decisions frequently block delivery.
The buyer should still verify the actual developers’ locations, schedules, technical experience, and delivery responsibilities.
A service advertised as nearshore should not be assumed to provide engineers in a particular country without written confirmation.
When Does a Hybrid Nearshore and Offshore Model Make Sense?
A hybrid arrangement can combine nearshore and offshore teams to balance real-time coordination with distributed engineering capacity.
For example, a US product team may work closely with an overlap-aligned technical lead while independent implementation and QA responsibilities are distributed across other locations.
The model works best when work can be separated clearly.
Example Hybrid Team Responsibilities
| Responsibility | Potential Owner |
|---|---|
| Business priorities | Customer product owner |
| Architecture decisions | Named technical lead |
| Stakeholder coordination | Overlap-aligned delivery lead |
| Defined implementation modules | Assigned development teams |
| Automated testing | QA ownership across agreed workstreams |
| Release approval | Authorized release owner |
| Production incidents | Assigned support team and escalation path |
The main risk is unclear decision ownership.
If two engineering groups both believe the other owns integration testing or release approval, work can stall despite the apparent benefit of additional resources.
A hybrid arrangement should have one shared backlog, consistent development standards, agreed interfaces, and explicit release responsibilities.
Its additional coordination cost should be included in the total delivery model.
How to Evaluate Nearshore and Offshore Vendors Before Signing
Vendor selection should begin with mandatory qualification requirements.
Only providers that satisfy those conditions should proceed to commercial scoring and delivery comparison.
Otherwise, a cheap quote could appear attractive even though the provider cannot meet a critical legal, security, or operational requirement.
Step 1: Apply Mandatory Vendor Qualification Gates
| Qualification Gate | Evidence to Request | Decision Rule |
|---|---|---|
| Delivery locations | Actual locations of assigned engineers and subcontractors | Must satisfy applicable location and access restrictions |
| Technical capability | Relevant work, interviews, engineering evidence | Must demonstrate required expertise |
| Security readiness | Policies, controls and relevant assessments | Must meet project-specific security requirements |
| Data access | Data categories, systems, access controls, vendor arrangements | Must satisfy applicable legal and contractual obligations |
| IP and deliverables | Written ownership/licensing and asset-access terms | Must provide required rights |
| Delivery ownership | Named technical, QA and release responsibilities | Must eliminate critical ownership gaps |
| Collaboration | Assigned schedule and escalation coverage | Must satisfy project decision and support needs |
| Continuity | Replacement and transition arrangements | Must address unacceptable single-person dependency |
These are qualification gates, not arbitrary geographic preferences.
For example, a vendor with an excellent hourly rate should not advance if it cannot lawfully access required systems or provide the agreed source-code rights.
Step 2: Normalize the Vendor Proposals
Ask shortlisted vendors to estimate the same deliverables.
Compare the same quality requirements, technical roles, deployment responsibilities, review obligations, and support period.
Document exclusions separately.
A provider that omits QA may still be suitable if the customer already has an effective QA function.
However, the buyer must account for that responsibility when comparing total costs.
Step 3: Conduct a Technical Evaluation
Interview the people expected to do the work.
Discuss architecture choices, integration failures, testing practices, code review, operational tradeoffs, and relevant project experience.
A general sales presentation should not replace direct engineering evaluation.
Step 4: Run a Representative Paid Pilot
For a substantial engagement, use a paid pilot based on a real, limited work package.
Define the scope, deliverables, access permissions, acceptance criteria, payment conditions, and evaluation process before the pilot begins.
The purpose is to observe actual delivery behavior.
A pilot should not be judged solely by whether the team produces a convincing demonstration.
Paid-Pilot Vendor Evaluation Scorecard
| Evaluation Metric | Evidence to Collect | What Success Looks Like |
|---|---|---|
| Accepted deliverables | Completed tasks and acceptance results | Work meets agreed functional and nonfunctional requirements |
| Decision latency | Timestamps of meaningful blockers and responses | Critical questions receive usable decisions within agreed expectations |
| Code-review turnaround | Review requests and feedback records | Reviews happen without recurring avoidable delays |
| Defect remediation | Defect log and verification results | Agreed defects are corrected and retested |
| Estimate reliability | Planned versus actual effort | Variances are explained and managed transparently |
| Test quality | Test results and coverage evidence | Critical behaviors and failures are appropriately validated |
| Documentation | Handover notes and setup instructions | Another authorized engineer can understand and reproduce the work |
| Security adherence | Access records and procedural evidence | Team follows approved data and development controls |
| Communication quality | Handoffs, status updates and decisions | Stakeholders can understand progress and risks without constant follow-up |
Buyers should agree on evaluation criteria before the pilot starts.
There is no universal defect count, response-time threshold, or delivery score that applies to every software project.
A regulated banking integration and a low-risk administrative dashboard will require different acceptance standards.
Step 5: Review Total Cost and Delivery Reliability Together
Once vendors have passed the mandatory gates, compare:
Estimated total delivery cost.
Relevant pilot results.
Required stakeholder involvement.
Decision and response coverage.
Engineering quality and testing evidence.
Contractual ownership.
Transition readiness.
Avoid allowing a small price advantage to override a serious delivery or compliance concern.
Step 6: Verify Handover Before Full Commitment
Confirm who controls repositories, environments, deployment assets, documentation, and relevant credentials.
The buyer should know how the product can be maintained if the relationship ends.
A practical exit plan is part of vendor selection, not an afterthought.
What Should US Businesses Choose in 2027?
The most suitable development model depends on the project and the organization’s ability to manage external engineering work.
Choose a nearshore-first evaluation when frequent live product discussions and time-sensitive collaboration are central to delivery.
Choose an offshore-first evaluation when technical requirements are clear, cost-efficient capacity matters, and the delivery process can support structured asynchronous work.
Consider a hybrid model when different workstreams have genuinely different collaboration needs and the business can manage coordination across teams.
Final Nearshore vs Offshore Decision Checklist
| Decision Question | What the Buyer Must Confirm |
|---|---|
| Can the vendor deliver the required software? | Relevant capability and evidence |
| Is the proposed location permitted? | Regulatory, contractual and data-access requirements |
| What is the actual total cost? | Normalized fees, internal work and other billable costs |
| Is collaboration sufficient? | Named engineers, working hours and escalation terms |
| Who owns technical decisions? | Clear architecture and implementation authority |
| Who tests and accepts the work? | Quality ownership and acceptance criteria |
| Are security controls appropriate? | Evidence of relevant safeguards |
| Can the engagement scale or change? | Replacement, staffing and transition terms |
| Can the customer exit cleanly? | Repositories, documentation, rights and operational handover |
| Has actual delivery been validated? | Paid-pilot evidence where appropriate |
This framework can be used across nearshore, offshore, onshore, and hybrid proposals.
The strongest vendor is the provider that meets the mandatory requirements and demonstrates the best fit for the agreed outcomes.
How Digixvalley Supports Software Outsourcing Decisions
Software outsourcing engagements can be structured around different levels of engineering capacity, collaboration, and delivery ownership.
Digixvalley’s public service portfolio includes nearshore software development alongside offshore and dedicated-team arrangements.
These offerings provide relevant commercial options for businesses planning to expand engineering capacity or deliver software projects.
However, the actual delivery model should be established for each engagement.
Define the Team Before Comparing Prices
An outsourcing proposal should identify the intended engineering responsibilities, actual staffing locations, agreed working-hour overlap, technical leadership, testing approach, and delivery process.
It should also distinguish customer-controlled decisions from responsibilities assigned to the development partner.
Published service descriptions do not independently establish the location of every engineer who might be proposed for a particular project.
Buyers should request written confirmation of assigned personnel arrangements where geographic location matters.
Compare the Proposed Delivery Arrangement
The appropriate team structure depends on the product’s requirements, current architecture, in-house capacity, security constraints, and expected collaboration.
A realistic proposal should explain who will build, review, test, deploy, and support the software.
It should also identify the assumptions behind the quoted scope and pricing.
This creates a stronger procurement basis than claims of universal savings, guaranteed velocity, or automatic time-zone compatibility.
Compare Delivery Outcomes, Not Just Developer Locations
Nearshore vs offshore software development is not a competition between two universally better or worse regions.
Nearshore delivery can make live collaboration easier. Offshore delivery can provide competitively priced engineering capacity, especially when teams use effective asynchronous processes and clearly defined responsibilities.
But geography and hourly price cannot establish delivery quality by themselves.
The stronger decision is based on comparable project scope, total cost, working-hour arrangements, qualified engineering capability, security eligibility, and contractual accountability.
For software projects planned in 2027, buyers should also consider how AI-assisted development changes code review, testing, and technical leadership responsibilities.
A reliable vendor-selection process starts with mandatory qualification gates, tests real engineering practices, and evaluates the full cost of accepted deliverables.
The best outsourcing model is the one that delivers the software your business needs with acceptable cost, collaboration, quality, and risk—not simply the lowest quoted hourly rate.
Evaluating nearshore and offshore development partners for your next software project?
Frequently Asked Questions
1. Is nearshore development always more expensive than offshore?
No. Some regional benchmarks show higher quoted rates for nearshore locations, but actual costs vary by expertise, team structure, and services included. The right comparison is total delivery cost for equivalent accepted work, not geography alone.
2. Can offshore developers work during US business hours?
Yes. Offshore providers may schedule approved shifts that overlap with US working hours. The agreement should confirm the assigned engineers, time window, daylight-saving adjustments, availability expectations, and required support coverage.
3. How should a buyer compare two outsourcing proposals with different hourly rates?
First normalize scope, roles, quality requirements, testing, and delivery responsibilities. Then include vendor fees, customer-side management, onboarding, and other contractually billable costs. Test how estimate variance or changes in coordination cost affect the comparison.
4. Does a lower offshore hourly rate guarantee cost savings?
No. A lower rate creates a possible cost advantage, but the final outcome depends on accepted engineering effort, coordination, delivery quality, and contractual terms. Savings should be calculated from actual or carefully modeled project costs.
5. Is offshore development suitable for a complex SaaS product?
Yes, provided the assigned team has suitable experience, technical leadership, clear decision ownership, adequate access to stakeholders, and reliable testing practices. Complexity alone does not make offshore delivery unsuitable.
6. What should be measured during an outsourcing vendor pilot?
Measure accepted deliverables, decision latency, estimate reliability, test quality, defect handling, documentation, and adherence to agreed security controls. Set project-specific acceptance criteria before the pilot begins.
7. Is a dedicated team the same as staff augmentation?
No. Staff augmentation generally adds specialists to a customer-managed team. A dedicated development team is organized around ongoing product responsibilities and may include coordinated delivery governance. Both can operate nearshore or offshore.
8. Does working with offshore engineers automatically violate US data security rules?
No. Applicable restrictions depend on the data, transactions, parties, and relevant regulations. Organizations handling sensitive or restricted information should evaluate actual access arrangements with qualified legal and security advisers.
9. Who owns software developed by an outsourcing company?
Ownership depends on the applicable law and signed agreement. Paying for development does not automatically establish every copyright or licensing right. Buyers should clarify assignments, pre-existing IP, open-source obligations, and deliverable access before work begins.
