How Long Does It Take to Build a Mobile App?

How Long Does It Take to Build a Mobile App?

August 7, 2026
Areeba
Written By : Areeba
Content Writer
Facts Checked by : Zayn Saddique
Technical Validation
Zayn Saddique

Table of Contents

Share Article:

Digixvalley featured image for a mobile app development timeline guide explaining how long it takes to build a mobile app.

At Digixvalley, a typical mobile app is generally planned within approximately 2–5 months, while a deliberately focused first version may be planned within approximately 4–8 weeks.

These are planning ranges, not guaranteed delivery dates. The actual mobile app development timeline depends on product scope, user workflows, platforms, backend requirements, third-party integrations, security needs, testing coverage, stakeholder decision speed, and release readiness.

A product with relatively few screens can still require a longer schedule when those screens depend on payments, identity verification, real-time data, complex backend logic, hardware, external APIs, sensitive information, or approvals from multiple stakeholders.

Digixvalley generally plans a typical mobile app within approximately 2–5 months and a focused first version within approximately 4–8 weeks. A reliable project-specific timeline comes from validating the scope, dependencies, integrations, quality requirements, and release conditions behind that range.

The more useful planning question is therefore not simply:

How many months will my app take?

It is:

Which workstreams control the launch date, which can safely happen in parallel, and which unresolved dependencies could move the schedule?

Key Timeline Takeaways

  • A typical Digixvalley mobile app is generally planned within approximately 2–5 months.
  • A deliberately focused first version may be planned within approximately 4–8 weeks.
  • These are planning ranges rather than guaranteed project durations.
  • User workflows and dependencies are stronger timeline signals than screen count.
  • Backend systems, integrations, QA, stakeholder decisions, and release preparation can control the launch date even when mobile development is progressing.
  • Several workstreams can run simultaneously, but only when their interfaces and responsibilities are sufficiently stable.
  • Adding developers does not automatically shorten a dependency on the critical path.
  • Cross-platform development can reduce duplicated implementation in suitable products, but it does not eliminate backend, integrations, security, testing, or release work.
  • A credible delivery date should identify its assumptions and what could change them.

How Long Does Mobile App Development Usually Take?

At Digixvalley, the planning range depends on what the first release actually needs to accomplish.

Digixvalley Planning ScenarioTypical Planning RangeWhat Can Change the Timeline
Typical mobile appApproximately 2–5 monthsScope, platforms, backend complexity, integrations, security, testing, approvals, and release requirements
Focused first version (MVP)Approximately 4–8 weeksRequires intentionally limited users, workflows, platforms, integrations, and launch requirements

DIGIXVALLEY PLANNING RANGE: These ranges are intended for early project planning. They are not contractual delivery guarantees. A project-specific timeline should be confirmed after reviewing the required workflows, platforms, backend systems, integrations, quality expectations, dependencies, and launch conditions.

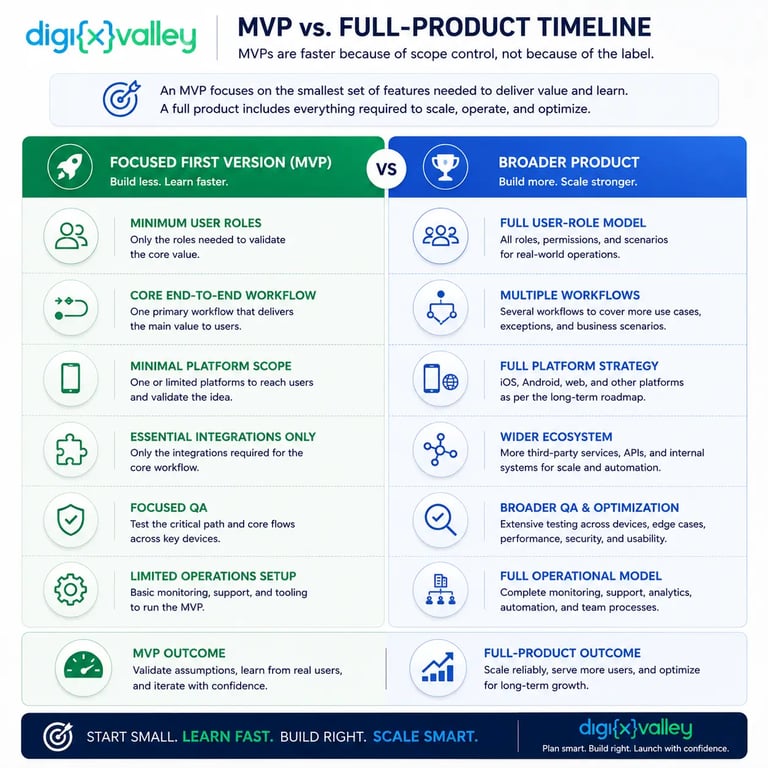

The label attached to the product is not enough.

One MVP might contain a single user role and one complete workflow. Another might include customers, providers, administrators, payments, real-time messaging, location tracking, a custom backend, and several external services.

The same principle applies to a typical app. The timeline becomes more useful when the work inside the label is defined.

A reliable schedule should answer:

  • What must be completed before launch?
  • Which tasks depend on other tasks?
  • Which workstreams can happen simultaneously?
  • Which decisions require stakeholder approval?
  • Which external systems can block progress?
  • What quality level defines release readiness?
  • Which assumptions could change the schedule?

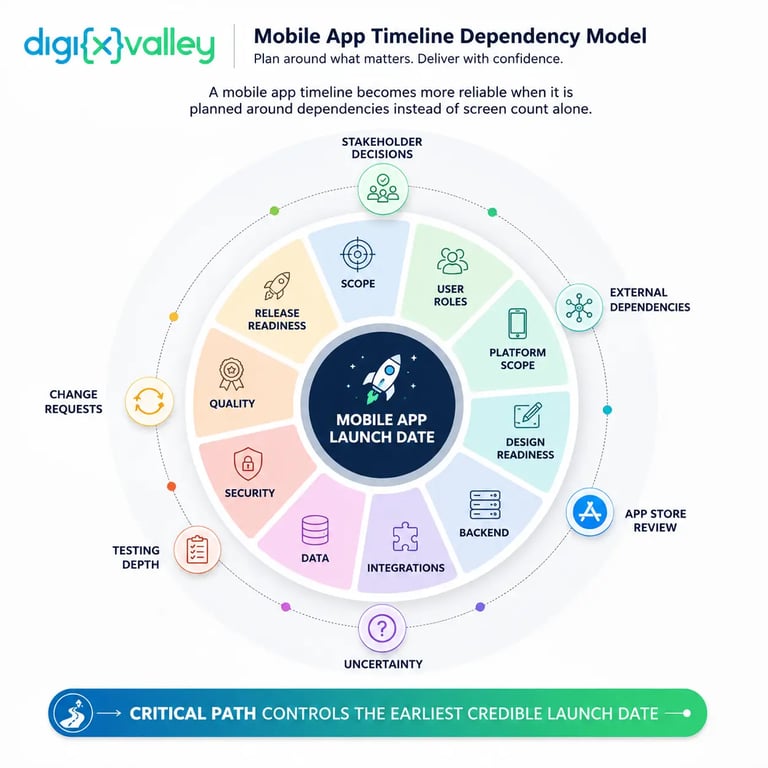

Mobile App Timeline Dependency Model

The Mobile App Timeline Dependency Model replaces broad labels such as simple, medium, and complex with the conditions that actually control calendar duration.

The central principle is:

A mobile app timeline should be planned around dependencies, not only estimated engineering hours.

Timeline DimensionQuestion to EvaluateEffect on the Timeline
Scope clarityAre launch workflows and acceptance criteria defined?Unclear scope creates additional discovery, decisions, and rework.
User rolesHow many user types, permissions, and approval paths exist?More roles create more workflows, states, logic, and testing.
Platform scopeiOS, Android, both, tablets, wearables, or other interfaces?More platforms expand implementation and compatibility work.
Design readinessAre important journeys, states, and interactions approved?Unresolved design can block or invalidate implementation.
BackendDoes an existing backend exist or must a new one be built?APIs, databases, administration, authentication, and business logic create dependent workstreams.
IntegrationsAre APIs, credentials, sandboxes, and documentation available?External dependencies can create waiting time outside engineering control.
DataAre data sources, ownership, migrations, and test data defined?Missing or inconsistent data can block integration and QA.
SecurityWhat sensitive data, permissions, identity, or audit requirements apply?Higher-risk systems require additional architecture and validation.
QualityWhich devices, OS versions, environments, and failure states must work?Broader release criteria expand testing and stabilization.
Stakeholder decisionsHow quickly can requirements and open questions be resolved?Slow decisions create idle time or assumption-based rework.
Release readinessAre store accounts, privacy information, production systems, and support owners ready?Missing launch dependencies can delay an otherwise finished app.
UncertaintyWhich product or technical assumptions remain unvalidated?Unknowns reduce schedule confidence and increase contingency needs.

The most important timeline factor is not always the workstream with the most engineering hours.

It may be the dependency sitting on the critical path.

Consider a payment workflow:

Provider approval → credentials → integration → end-to-end testing → release validation

The payment integration may require less implementation effort than the mobile interface, but it can still control the launch date when everything after it depends on the provider being ready.

Mobile App Timeline Dependency Model by Digixvalley showing how scope, backend, integrations, testing, security, and critical-path dependencies determine a mobile app launch date.

Turn Your App Scope Into a Realistic Delivery Plan

Share your workflows, platforms, integrations, and constraints to identify schedule dependencies before committing to launch.

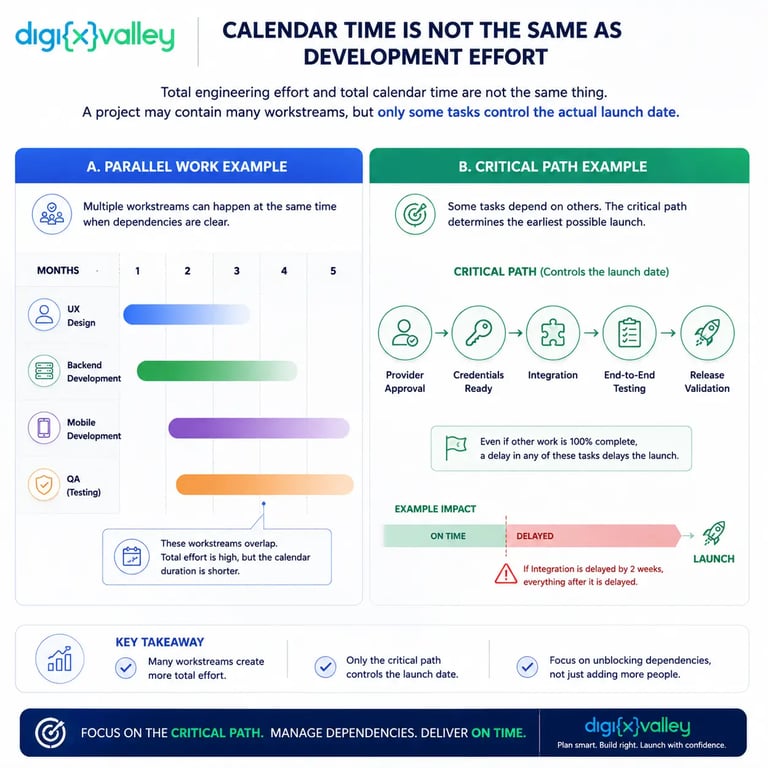

Calendar Time Is Not the Same as Development Effort

Total development effort and elapsed calendar duration measure different things.

A mobile project can contain several simultaneous workstreams:

  • Product discovery
  • UX design
  • UI design
  • Technical architecture
  • Backend engineering
  • Mobile engineering
  • Integration work
  • Quality assurance
  • Security validation
  • Release preparation

When these workstreams have stable boundaries, several specialists can work at the same time. The project can therefore contain more total person-weeks of effort than calendar weeks.

The opposite is also possible.

A task requiring relatively little coding can add substantial calendar time when it depends on unavailable credentials, an external approval, hardware, legal guidance, stakeholder feedback, test data, or a third-party system.

Think in Terms of the Critical Path

The critical path is the chain of dependent activities that determines the earliest credible completion date.

This helps distinguish different schedule problems:

ProblemWhat It MeansAppropriate Response
Effort problemMore work exists than expected.Reduce scope or increase suitable capacity.
Capacity problemWork is ready, but insufficient resources can execute it.Add appropriate resources.
Dependency problemWork cannot proceed yet.Resolve or redesign around the dependency.
Decision problemAn approval or clarification is missing.Escalate ownership and decision timing.
Quality problemCompleted functionality has not met release criteria.Fix, retest, and stabilize.

Adding more developers can help with a capacity problem.

It does not automatically solve the other four.

Digixvalley infographic comparing mobile app development effort and calendar time, showing overlapping UX, backend, mobile development and QA workstreams alongside the critical path from provider approval to release validation.

Real Digixvalley Examples: How Product Dependencies Change the Timeline

Digixvalley case study portfolio includes mobile apps, multi-platform products, SaaS systems, marketplaces, real-time platforms, and other custom digital products. These projects show why mobile app timelines cannot be estimated reliably from screen count or an app label alone.

Different products create different dependency chains.

Digixvalley projectProduct dependenciesWhat it demonstrates for timeline planning
Turbo Last MileDriver mobile app, dispatch operations, live delivery tracking, route optimization, ETA logic, Stripe subscriptions, customer portals, role-based accessReal-time and logistics products require mobile, backend, location, operational, and multi-role workflows to remain synchronized
TakeHairCustomer booking, provider availability, scheduling, notifications, payment workflows, reviews, provider management, admin operationsMarketplace timelines depend on several user roles and on booking, availability, payment, and notification workflows working together
Pickleball ManagerMobile live streaming, real-time scoring, referee workflows, commentary, YouTube integration, tournament management, spectators, role-based accessReal-time media products introduce synchronization, streaming, scoring, platform-integration, and multi-user testing dependencies
FoodageFlutter mobile apps, web platform, backend services, social feed, restaurant discovery, geo-location, reviews, notifications, moderation, role-based managementMulti-platform products require coordinated mobile, web, backend, location, content, and moderation workstreams

Turbo Last Mile, for example, combines a driver mobile app with dispatch, live tracking, route optimization, customer portals, subscription workflows, and several user roles. Its published case study identifies real-time tracking, ETA calculations, route optimization, dispatch automation, multi-tenant architecture, Stripe billing, and role-based access as important system requirements.

A simplified dependency chain looks like:

Driver workflow → location data → backend state → dispatch visibility → route behavior → customer tracking

A failure or delay in one part can affect several downstream workflows.

TakeHair demonstrates a different dependency pattern. Its booking marketplace connects customers, hairstylists, and administrators through provider availability, appointment scheduling, booking status, notifications, payment workflows, reviews, and marketplace operations.

A simplified relationship is:

Provider availability → booking selection → confirmation → payment workflow → notifications → appointment management

The interface may appear straightforward to the customer, but the timeline also depends on the rules and systems operating behind that interface.

Pickleball Manager introduces another type of complexity. The product connects players, referees, commentators, tournament administrators, spectators, and sports-media workflows through mobile live streaming, real-time scoring, commentary, tournament operations, and YouTube integration.

Its dependency chain can include:

Match creation → referee scoring → real-time synchronization → commentary → live stream → spectator experience

This type of product requires more than completing individual screens. Several user roles and real-time systems must behave correctly together.

Foodage demonstrates how timeline dependencies change again when one product spans mobile, web, backend, geo-based discovery, social content, reviews, notifications, moderation, and several types of users. Its public case study identifies Flutter for Android and iOS, Next.js for the web platform, NestJS for the backend, and workflows involving restaurant discovery, user-generated content, geo-location, notifications, search, and role-based management.

A simplified dependency relationship is:

User content → backend data → discovery/search → location context → moderation → mobile and web presentation

What These Projects Show About Mobile App Timelines

These projects have different industries and product models, but they reveal the same scheduling principle:

The visible mobile interface is only one part of the delivery timeline.

A project schedule can also depend on:

  • User roles and permissions
  • Backend business logic
  • Real-time communication
  • Third-party integrations
  • Location and mapping
  • Payments
  • Streaming
  • Notifications
  • Administration workflows
  • Mobile and web coordination
  • Security and access controls
  • Test environments
  • Realistic end-to-end validation

That is why two apps with a similar number of screens can require very different delivery schedules.

None of these case studies should be used to claim that a particular product type always takes a specific number of weeks unless a verified project duration is publicly approved.

Their purpose in this guide is different:

They provide first-party evidence that mobile development timelines are shaped by interconnected workflows, dependencies, platforms, integrations, and validation requirements—not screen count alone.

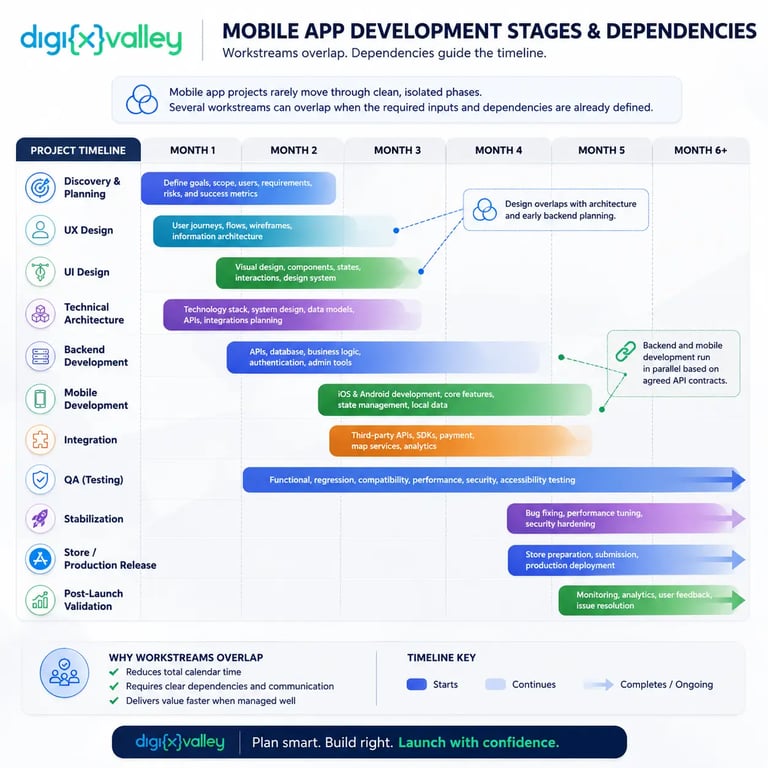

Mobile App Development Stages and Dependencies

A mobile application commonly moves through discovery, design, engineering, testing, release, and post-launch work.

These stages do not always happen one after another.

The more important scheduling question is:

Which output from one workstream does another workstream need before it can proceed safely?

StageMain WorkMain DependencyCan Overlap?
Discovery and planningUsers, workflows, scope, requirements, and risksStakeholder decisionsPartly
UX designJourneys, information architecture, wireframes, and prototypesStable core workflowsYes
UI designComponents, screens, states, and responsive behaviorApproved UX directionYes
Technical architectureMobile structure, backend boundaries, data, and integrationsCritical technical requirementsYes
Backend developmentAPIs, databases, authentication, business logic, and administrationArchitecture and interface contractsYes
Mobile developmentPlatform implementation and device behaviorStable workflows and API contractsYes
IntegrationExternal APIs, SDKs, payments, identity, and hardwareProvider readinessPartly
Continuous QAFunctional, regression, compatibility, and accessibility testingTestable incrementsYes
StabilizationDefects, performance, security, and release blockersRelease candidateLimited
Store and production releaseSigning, metadata, privacy details, and deploymentRelease-ready build and accountsLimited
Post-launch validationMonitoring and production issuesLive production environmentAfter release

Discovery and Planning

Discovery establishes what the first release must accomplish and what remains uncertain.

It should clarify:

  • Business outcome
  • Target users
  • User roles
  • Core workflows
  • Platform requirements
  • Launch priorities
  • Integrations
  • Data sources
  • Security obligations
  • Operational requirements
  • Acceptance criteria
  • Major technical unknowns

Skipping discovery does not necessarily remove these decisions.

It can move them into implementation, where changing direction may affect completed design, APIs, database structures, integrations, and tests.

UX and UI Design

Design is more than producing polished screens.

A production-ready workflow may require:

  • Navigation
  • Loading states
  • Empty states
  • Validation
  • Errors
  • Permissions
  • Offline behavior
  • Recovery paths
  • Responsive behavior
  • Accessibility
  • Content requirements

Development can begin before every visual detail is finished when the important workflows and interface rules are stable.

Starting too early becomes risky when fundamental product behavior is still changing.

Architecture and Backend Development

A mobile application may depend on authentication, databases, APIs, administration tools, notifications, reporting, real-time services, scheduled jobs, search, file processing, or other server-side systems.

Backend and mobile engineering can proceed simultaneously when the interface between them is defined clearly.

Digixvalley backend development services describe API-first systems serving mobile, web, and third-party consumers and specifically identify parallel frontend and backend development as a benefit of defined API interfaces.

Parallel development does not make backend dependencies irrelevant.

An unstable API contract can create rework across every application consuming it.

Mobile Engineering

Mobile engineers turn product requirements, approved interactions, platform constraints, and backend interfaces into testable application increments.

Implementation generally expands when the app requires:

  • Multiple user roles
  • Complex state management
  • Offline workflows
  • Real-time updates
  • Background processing
  • Device hardware
  • Payments
  • Location tracking
  • Media handling
  • Specialized platform functionality
  • Broad device compatibility

The schedule is therefore driven more by the behavior that must work than by the number of screens.

Third-Party Integrations

Integrations deserve separate timeline attention because another organization may control part of the dependency.

Before treating an integration as schedule-ready, confirm:

  • Documentation
  • Sandbox access
  • Credentials
  • Authentication
  • Test accounts
  • Test data
  • Rate limits
  • Webhooks
  • Error behavior
  • Approval requirements
  • Production access
  • Support ownership

Digixvalley API development services provide the relevant commercial path when a product requires custom APIs or integration layers connecting the mobile application with other systems.

Mobile app development stages and dependencies timeline by Digixvalley showing overlapping workstreams across discovery, UX/UI design, backend, mobile development, integration, QA, stabilization, production release, and post-launch validation.

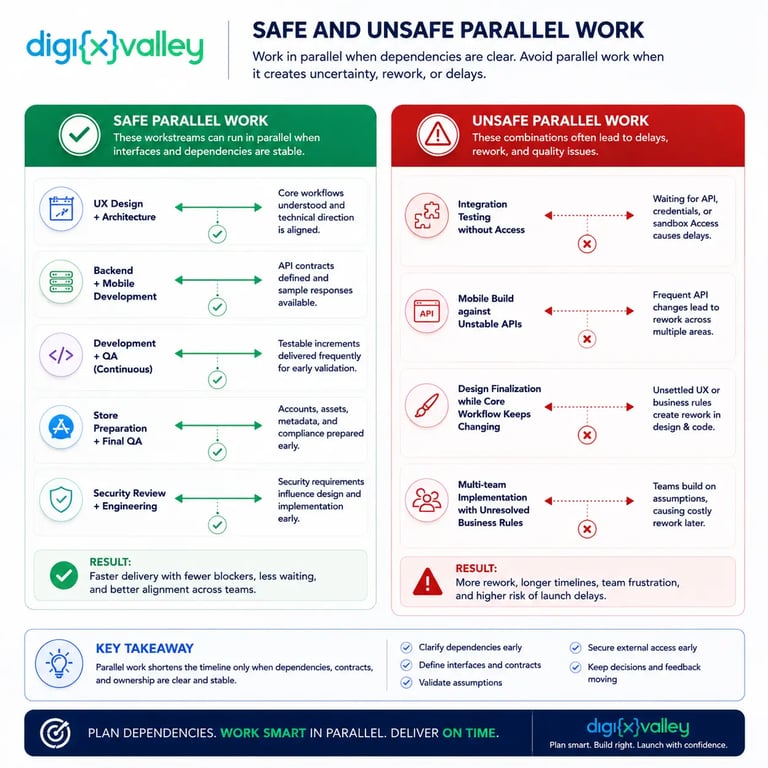

What Work Can Run in Parallel?

Parallel execution can shorten elapsed calendar duration only when workstreams have sufficiently stable boundaries.

WorkstreamsCan Overlap?Required Condition
Discovery + technical researchYesHigh-risk assumptions are identified early.
UX + architectureYesCore workflows are sufficiently understood.
UI design + backend developmentYesProduct behavior and technical contracts are stable enough.
Backend + mobile developmentYesTeams agree on API contracts and representative responses.
Native iOS + native AndroidYesPlatform teams can coordinate shared product behavior.
Cross-platform development + backendYesShared architecture is not blocked by unresolved native requirements.
Development + QAYesTestable increments are delivered continuously.
Security review + engineeringYesSecurity requirements influence implementation early.
Store preparation + final QAPartlyAccounts, metadata, privacy information, and assets are prepared early.
Integration testing + unavailable provider accessNoThe external dependency must first be resolved.

Parallel work fails when multiple teams build against changing assumptions.

Three engineers working simultaneously on three tightly connected modules can create more rework than a smaller, well-sequenced team when none of the interfaces is stable.

The goal is not maximum concurrency.

It is safe concurrency.

Digixvalley infographic comparing safe and unsafe parallel work in mobile app development, including UX and architecture, backend and mobile development, QA, security review, unstable APIs, and unresolved dependencies.

What Affects Mobile App Development Time Most?

1. Product Scope and User Workflows

A product with one main user and one complete workflow is easier to sequence than a system connecting customers, providers, administrators, support teams, managers, and auditors.

Each additional role can introduce:

  • Permissions
  • Navigation
  • Notifications
  • Approval paths
  • Data visibility
  • Reporting
  • Recovery flows
  • Administration

Timeline estimation should therefore begin with complete user journeys rather than a screen-count spreadsheet.

2. Platform Scope

Supporting one mobile platform creates a different workload from supporting both iOS and Android.

The schedule depends on:

  • Native or cross-platform architecture
  • Shared implementation
  • Platform-specific behavior
  • Device functionality
  • Supported OS versions
  • Testing requirements

Platform choice matters, but it is only one timeline variable.

3. Backend Readiness

An application connected to an existing, stable API creates a different schedule from a product requiring new:

  • Authentication
  • Databases
  • APIs
  • Business logic
  • Administration
  • Reporting
  • Real-time communication
  • Search
  • Notifications
  • Data synchronization

Backend work can happen alongside mobile development when contracts are stable.

Unresolved server-side decisions can instead block several mobile workflows simultaneously.

4. Third-Party Integrations

A documented API with working test credentials is more predictable than a legacy system with unclear ownership.

External dependencies can introduce waiting through:

  • Partner approval
  • Enterprise IT access
  • Production credentials
  • Payment-provider verification
  • Hardware availability
  • Security reviews
  • Legal agreements
  • Third-party technical support

Integration readiness can therefore matter as much as integration complexity.

5. Security, Privacy, and Compliance

Security requirements should influence architecture early.

Applications handling sensitive identity, financial, healthcare, employee, or other protected information may require additional controls, documentation, validation, and review.

A requirement identified before implementation is easier to plan than the same requirement discovered during stabilization.

6. Testing Scope

Testing requirements increase with:

  • Platforms
  • Device classes
  • Operating-system versions
  • User roles
  • Languages
  • Integrations
  • Network states
  • Offline workflows
  • Accessibility requirements
  • Performance targets
  • Security requirements

QA should begin with testable increments instead of waiting for the entire application to be declared complete.

7. Stakeholder Decision Speed

A project can be delayed even when engineering is progressing correctly.

Examples include:

  • Design waiting for approval
  • Engineering waiting for business rules
  • QA waiting for test accounts
  • Integration work waiting for credentials
  • Product decisions waiting for legal guidance
  • Release work waiting for store-account information

Decision latency is part of the project timeline.

How Native and Cross-Platform Development Affect Timeline

Cross-platform development can reduce duplicated application-layer implementation when iOS and Android share substantially the same workflows.

It does not mean the entire project timeline is automatically reduced by a fixed percentage.

Both native and cross-platform projects may still require:

  • Product discovery
  • UX design
  • Backend development
  • API integration
  • Security work
  • Analytics
  • Device testing
  • Store preparation
  • Production monitoring

The cross-platform advantage can become smaller when an application requires extensive native modules, unsupported SDKs, substantially different interfaces between platforms, or specialized hardware.

Native development can also be efficient when only one platform is required or when the product depends deeply on platform-specific capabilities.

The architecture should therefore be selected from product requirements rather than a universal faster label.

For the detailed architectural decision, review Digixvalley guide to native versus cross-platform app development. The guide is a distinct decision page covering architecture, performance, cost, timeline, and long-term tradeoffs.

How Long Does App Store Review Take?

Store review is a variable release dependency, not a guaranteed development duration.

Apple currently states that 90% of App Store submissions are reviewed in less than 24 hours on average. Apple also warns that incomplete submissions or missing review information can delay review.

Google Play states that certain developer accounts may experience review times of up to seven days or longer in exceptional cases.

Neither figure should be treated as a guaranteed launch date.

Teams can reduce preventable submission delays by preparing:

  • Developer accounts
  • Signing credentials
  • Privacy information
  • Store descriptions
  • Screenshots and assets
  • Content or age ratings
  • Demo accounts
  • Reviewer credentials
  • Required policies
  • Production configuration
  • Support information

A technically finished mobile app is not launch-ready while these release dependencies remain incomplete.

MVP vs. Full-Product Timeline

At Digixvalley, a deliberately focused first version may be planned within approximately 4–8 weeks when the users, workflows, integrations, platforms, and launch requirements are intentionally limited.

The word MVP does not automatically create that timeline.

The schedule advantage comes from scope reduction and sequencing.

Planning AreaFocused First VersionBroader Product
User rolesMinimum roles needed to validate valueFull operating model and permissions
WorkflowsSmallest complete end-to-end journeyCore, supporting, administrative, and recovery workflows
PlatformsMinimum coverage needed for validationFull audience and device strategy
IntegrationsOnly systems required for the core hypothesisWider ecosystem and automation
DesignCoherent and usable first-release experienceDeeper brand expression and optimization
BackendProduction-ready foundation for core workflowsExpanded services, administration, and scalability
AnalyticsEvents needed to evaluate the hypothesisBroader product and operational measurement
QARelease criteria for focused scopeWider compatibility, resilience, and optimization
OperationsAppropriate production baselineAdvanced monitoring, governance, and support

A first version requiring multiple roles, custom backend systems, payments, live location, real-time communication, sensitive data, or difficult integrations may require more than 4–8 weeks.

That does not mean it has failed to be an MVP.

It means its minimum viable scope still contains substantial delivery dependencies.

Startups defining or refining their first release can review Digixvalley startup product development services, which publicly covers product roadmap validation, architecture review, development, QA, and release work.

Digixvalley infographic comparing an MVP focused first version with a broader full product across user roles, workflows, platform scope, integrations, QA, operations, and development timeline.

Why Mobile App Projects Get Delayed

Many substantial delays originate in unresolved dependencies rather than slow coding.

Delay CauseWhat HappensBetter Control
Undefined launch scopeFeatures continue entering development.Define launch-critical workflows and change control.
Changing business rulesCompleted work must be redesigned.Validate rules and acceptance criteria earlier.
Late stakeholder feedbackTeams wait or proceed on assumptions.Assign clear product ownership.
Missing API accessIntegration cannot be completed or tested.Validate providers, sandboxes, and credentials early.
Design changes during implementationScreens and logic require rework.Prototype high-risk workflows first.
Backend instabilityMobile implementation repeatedly changes.Define interface contracts and ownership.
Missing test dataQA cannot validate realistic scenarios.Prepare representative data and environments.
Late security requirementsArchitecture may require modification.Identify sensitive data and controls during planning.
Device issues discovered lateRelease candidate fails compatibility checks.Test important devices continuously.
Store-account problemsFinished application cannot be submitted.Prepare accounts and release details early.
Scope expansionAdditional work enters the same launch date.Re-estimate or move work into a later phase.
Unclear ownershipImportant decisions remain unresolved.Assign a decision owner to each dependency.

A realistic project timeline therefore considers:

engineering time + dependency waiting + decision latency + stabilization

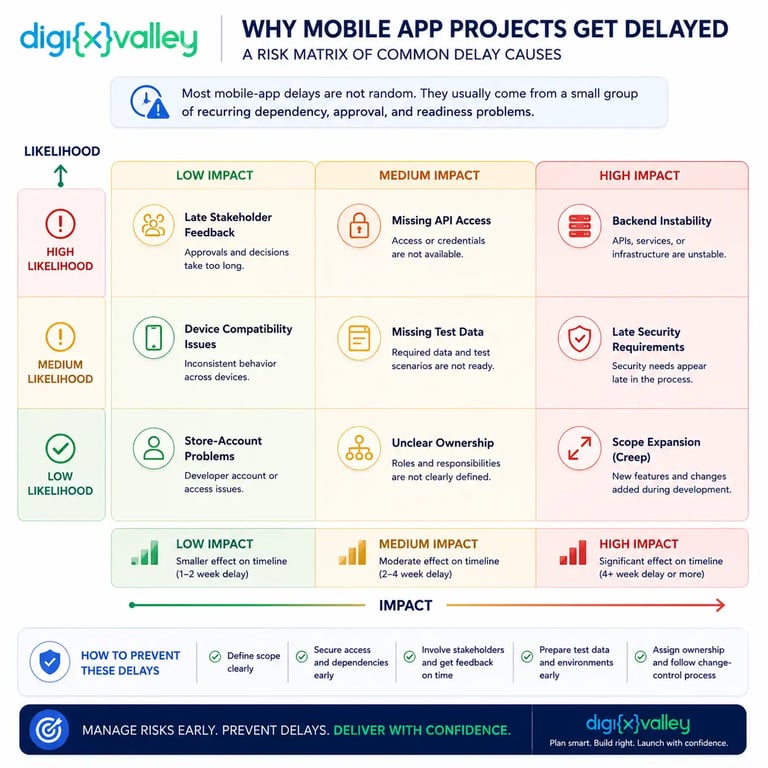

Digixvalley mobile app project delay risk matrix showing how unclear scope, missing API access, backend instability, late security requirements, scope expansion, and stakeholder delays affect project timelines.

How to Shorten a Mobile App Timeline Safely

Faster delivery usually comes from removing unnecessary work, waiting, duplication, and uncertainty not simply telling a development team to code faster.

Define a Smaller Complete Release

Do not remove random features.

Define:

  • Which user matters first
  • Which problem the release must solve
  • Which complete workflow proves the value
  • Which platforms are necessary
  • Which integrations are essential
  • Which quality requirements are non-negotiable

A narrow but complete workflow provides a stronger first release than a wider collection of incomplete functionality.

Prototype High-Risk Requirements Early

Prototype the requirement most likely to change the architecture or schedule.

Examples include:

  • Background location
  • Offline synchronization
  • Hardware communication
  • Legacy API integration
  • Authentication
  • Payment flows
  • AI outputs
  • Large-file processing

A technical proof can expose a blocking assumption before the whole product is built around it.

Define API Contracts Early

Backend and mobile teams can work simultaneously when they agree on:

  • Endpoints
  • Request formats
  • Response formats
  • Authentication
  • Error models
  • Versioning
  • Representative test data

Mock responses can allow mobile engineering to move forward before every backend service is production-ready.

Test Continuously

Testing should follow implementation instead of accumulating entirely at the end.

Continuous QA allows product, device, integration, accessibility, and architecture problems to surface while the relevant workstream is still active.

Prepare Release Work Before Development Ends

Developer accounts, privacy details, reviewer credentials, production environments, monitoring, and support ownership can be prepared while the application is still moving through final QA.

Keep Decisions Moving

A product owner who can resolve critical questions quickly can improve schedule predictability more than another engineer assigned to an already blocked workstream.

Define who can approve:

  • Scope
  • Design
  • Business rules
  • Integration behavior
  • Content
  • Security decisions
  • Release decisions

Can AI Shorten Mobile App Development Time?

AI-assisted development can reduce effort on selected engineering tasks, but it should not be translated into a universal percentage reduction for an entire mobile-app timeline.

Potential uses include:

  • Boilerplate generation
  • Test scaffolding
  • Documentation
  • Refactoring assistance
  • Prototype code
  • Code explanation
  • Data transformation
  • Repetitive implementation

AI does not remove dependencies such as:

  • Product decisions
  • External API access
  • Security review
  • Test data
  • Device testing
  • Store review
  • Stakeholder feedback
  • Production accountability

AI-generated code also requires appropriate engineering review and validation.

The useful timeline question is not:

Are AI tools being used?

It is:

“Do they reduce verified effort in this workstream without increasing review, rework, security, or maintenance risk?”

Does Adding More Developers Make an App Launch Faster?

Sometimes but not proportionally.

Additional developers help when:

  • Work can be divided into independent modules
  • Architecture boundaries are clear
  • Requirements are ready
  • Product decisions are available
  • Testing capacity can keep pace
  • Engineering leadership can coordinate parallel work

More developers help less when everyone depends on:

  • One unresolved architecture decision
  • One external integration
  • One migration
  • One product owner
  • One outside approval
  • One unstable API

More capacity cannot remove a dependency bottleneck.

The better question is:

Which workstream controls the launch date, and can additional capacity actually shorten that workstream?

How Cost and Timeline Affect Each Other

Project cost and calendar duration are connected, but they are not interchangeable.

A shorter schedule may require:

  • More workstreams operating simultaneously
  • Greater engineering capacity
  • Additional coordination
  • Parallel QA
  • Earlier architecture decisions
  • Faster stakeholder availability
  • Additional environments
  • More automation
  • Stronger release management

A smaller team may reduce monthly spend while increasing elapsed duration.

When comparing proposals, separate these variables:

VariableWhat It Represents
Engineering effortTotal work required
Team capacityWork that can be executed concurrently
Calendar durationElapsed time from start to milestone
Dependency waitingTime during which dependent work cannot proceed
ContingencyAllowance for unresolved uncertainty
ScopeWhat must actually be delivered

A shorter timeline does not automatically mean less work or a lower total project cost.

How Confident Should You Be in a Mobile App Timeline?

Timeline confidence should increase as important dependencies become validated.

Confidence LevelProject ConditionAppropriate Planning Approach
LowScope, workflows, platforms, or integrations remain unclear.Use a broader range and prioritize discovery.
MediumCore workflows are defined, but design, data, integrations, or quality requirements remain open.Use a range with explicit dependencies and contingency.
HighRequirements, major integrations, designs, environments, responsibilities, and acceptance criteria are substantially defined.Build a detailed milestone plan and control changes against documented assumptions.

A narrower estimate is not automatically a better estimate.

A wider range supported by clear assumptions can be more useful than a precise date built on unresolved dependencies.

How Digixvalley Plans Mobile App Delivery

Digixvalley mobile app development offering covers product planning, iOS and Android development, cross-platform implementation, testing, release activities, and post-launch support. Its live mobile-app service page describes delivery from idea validation through App Store launch and continued scaling.

For a project-specific timeline, the scope review should answer:

  • What business outcome defines the first release?
  • Which users and workflows are launch-critical?
  • Which platforms and devices are required?
  • Which journeys are already designed?
  • What backend systems already exist?
  • Which APIs and third-party services are required?
  • Which dependencies sit outside the delivery team’s control?
  • Which security and privacy requirements apply?
  • What quality criteria define production readiness?
  • Which workstreams can safely run in parallel?
  • Which assumptions need a prototype or technical validation?
  • Who owns product decisions and approvals?
  • Which production and store dependencies must be ready?
  • Which changes would require the timeline to be reviewed?

The goal is not simply to produce the earliest possible date.

It is to establish:

why the date is achievable → what assumptions support it → what could move it

Businesses evaluating end-to-end implementation can review Digixvalley mobile app development services.

Timeline planning should also continue beyond the initial release. Digixvalley mobile app maintenance and support services cover ongoing areas including OS compatibility, security monitoring, performance optimization, bug resolution, store management, and feature work.

Mobile App Timeline Planning Checklist

Before accepting a proposed launch date, verify the following.

Scope

  • Core users are defined.
  • Launch workflows are documented.
  • Features are classified as launch-critical or later.
  • Acceptance criteria exist for important workflows.

Technical Dependencies

  • Target platforms are confirmed.
  • Backend ownership is defined.
  • Required APIs are identified.
  • Third-party access has been checked where possible.
  • Data sources are known.
  • High-risk technical assumptions are documented.

Design

  • Core journeys are approved.
  • Important interface states are covered.
  • Accessibility expectations are defined.
  • Content ownership is assigned.

Delivery

  • Product decision-makers are named.
  • Engineering responsibilities are clear.
  • QA begins during development.
  • Test and production environments are defined.
  • Change-control rules exist.

Launch

  • Required developer accounts are ready.
  • Store metadata ownership is assigned.
  • Privacy and policy information is available.
  • Production monitoring is planned.
  • Support ownership is defined.

A project becomes easier to schedule as fewer critical questions remain unanswered.

Final Takeaway

At Digixvalley, a typical mobile app is generally planned within approximately 2–5 months, while a deliberately focused first version may be planned within approximately 4–8 weeks.

Those ranges become meaningful only when they are connected to the actual project.

A dependable timeline comes from understanding:

scope → dependencies → critical path → parallel work → validation → release readiness

The strongest project schedule identifies:

  • Which activities control the launch date
  • Which workstreams can safely happen simultaneously
  • Which assumptions remain uncertain
  • Which external dependencies can move the schedule
  • What conditions define release-ready

That gives founders, CTOs, product managers, and enterprise teams something more useful than a hopeful deadline:

a timeline they can explain, challenge, monitor, and manage.

Build a Timeline You Can Actually Plan Around

Share your product requirements with Digixvalley to review scope, dependencies, delivery risks, and launch priorities.

Frequently Asked Questions

How Long Does It Take to Develop a Mobile App?

At Digixvalley, a typical mobile app is generally planned within approximately 2–5 months. The project-specific timeline can move depending on workflows, platforms, backend requirements, integrations, testing, stakeholder decisions, and release dependencies.

How Long Does It Take to Build an MVP or Focused First Version?

At Digixvalley, a deliberately focused first version may be planned within approximately 4–8 weeks when the release intentionally limits users, workflows, platforms, integrations, and launch requirements.

A first version requiring multiple roles, a substantial custom backend, payments, real-time functionality, difficult integrations, specialized hardware, or sensitive data can require more time.

Are Digixvalley’s 2–5 Month and 4–8 Week Timelines Guaranteed?

No. They are planning ranges. A project-specific schedule should be confirmed after reviewing the scope, dependencies, integrations, quality requirements, responsibilities, and release conditions.

What Part of Mobile App Development Takes the Longest?

There is no universal longest stage. Development may contain the greatest amount of work, but an external integration, approval, migration, security requirement, design decision, or stabilization problem can control the launch date when it sits on the critical path.

Does Cross-Platform Development Make an App Faster to Build?

It can reduce duplicated implementation when iOS and Android share similar workflows. The advantage becomes smaller when the product requires substantial native modules, unsupported SDKs, hardware access, or significantly different behavior between platforms.

Can Design and Development Happen at the Same Time?

Yes, when core workflows and design rules are stable enough for engineering to proceed. Starting development while navigation, business rules, or major interface behavior remain unresolved can create rework rather than save time.

Does Adding More Developers Make App Development Faster?

Only when work can be divided safely. Additional developers do little to resolve a blocked API, delayed stakeholder decision, unstable architecture, unavailable test data, or missing production environment.

How Long Does App Store Approval Take?

Apple currently reports that 90% of App Store submissions are reviewed in less than 24 hours on average. Google Play states that certain developer accounts may experience reviews of up to seven days or longer in exceptional cases. Neither figure should be treated as a guaranteed release duration.

Why Do Mobile App Projects Get Delayed?

Common causes include unclear scope, changing business rules, slow approvals, missing integration access, late design changes, unstable APIs, missing test data, late security requirements, compatibility problems, and incomplete release preparation.

How Can a Company Get a More Accurate Mobile App Timeline?

Define the users, launch workflows, platforms, integrations, data, design expectations, security requirements, quality criteria, release dependencies, decision owners, and unresolved technical risks. Schedule confidence increases as those dependencies become validated.

About Author

Zayn Saddique is the CEO & Owner with strong expertise in digital transformation, web development, mobile app development, custom software, and AI solutions services. He helps startups, SMEs, and enterprises leverage innovative, scalable, and business-focused technologies to stay competitive in a rapidly evolving market. With a deep understanding of modern trends and intelligent solutions, he is dedicated to delivering practical strategies that drive growth, efficiency, and long-term success.
Zayn Saddique

Let’s Build Something Great Together!

Latest Blogs
